Game Production for Dummies or What the hell

  • Slides: 34
Download presentation
Game Production for Dummies (or, What the hell does a producer do anyway? )

Game Production for Dummies (or, What the hell does a producer do anyway? ) Andy Satterthwaite Producer: Sidhe Interactive

Who Am I? • Andy Satterthwaite • Producer – Team Manager – Project Planner

Who Am I? • Andy Satterthwaite • Producer – Team Manager – Project Planner – Designer (sometimes) • In the game industry since 1993 – Producer “Wipeout 2097” & “Colony Wars” for Sony Psygnosis • Formed Curly Monsters Ltd. in 1998 – Produced & co-designed “N-GEN Racing” and “Quantum Redshift” • Joined Sidhe in June 2003

N-GEN Racing

N-GEN Racing

Quantum Redshift

Quantum Redshift

What I’m going to talk about Production at development team level for a development

What I’m going to talk about Production at development team level for a development studio What I’m not going to talk about Executive Production – producing the producers External Production – the publisher’s producer License Acquisition

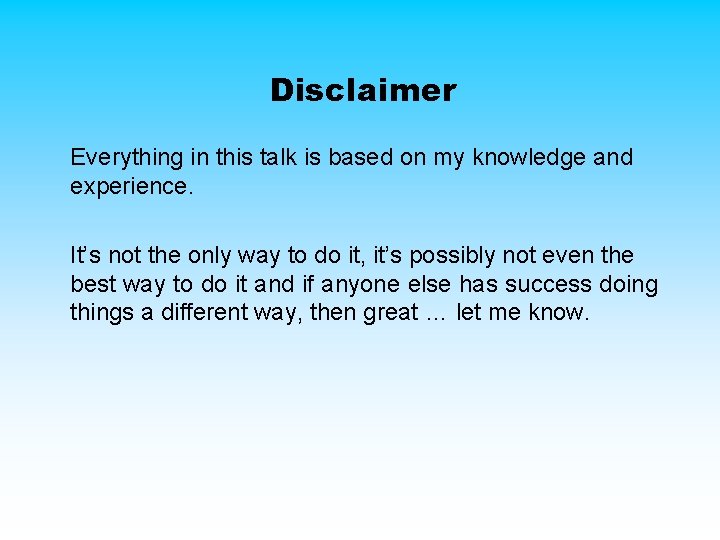

Disclaimer Everything in this talk is based on my knowledge and experience. It’s not

Disclaimer Everything in this talk is based on my knowledge and experience. It’s not the only way to do it, it’s possibly not even the best way to do it and if anyone else has success doing things a different way, then great … let me know.

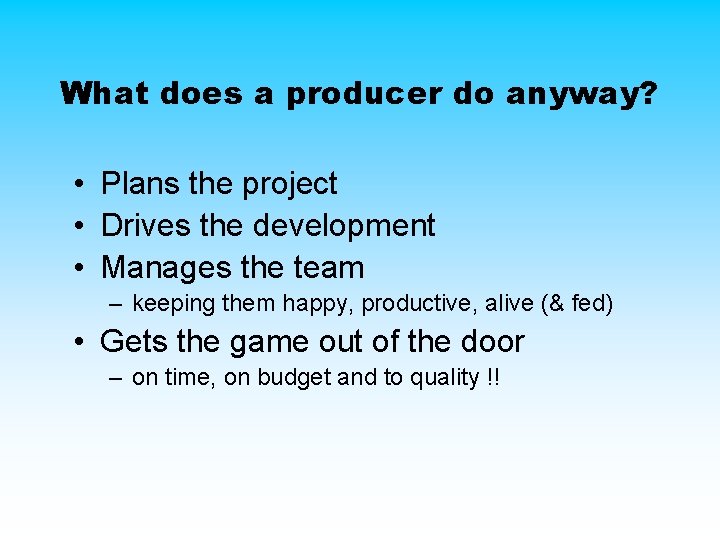

What does a producer do anyway? • Plans the project • Drives the development

What does a producer do anyway? • Plans the project • Drives the development • Manages the team – keeping them happy, productive, alive (& fed) • Gets the game out of the door – on time, on budget and to quality !!

About Project Planning • • Project planning software My golden rules of planning How

About Project Planning • • Project planning software My golden rules of planning How to get an instant overview plan How to calculate a project budget

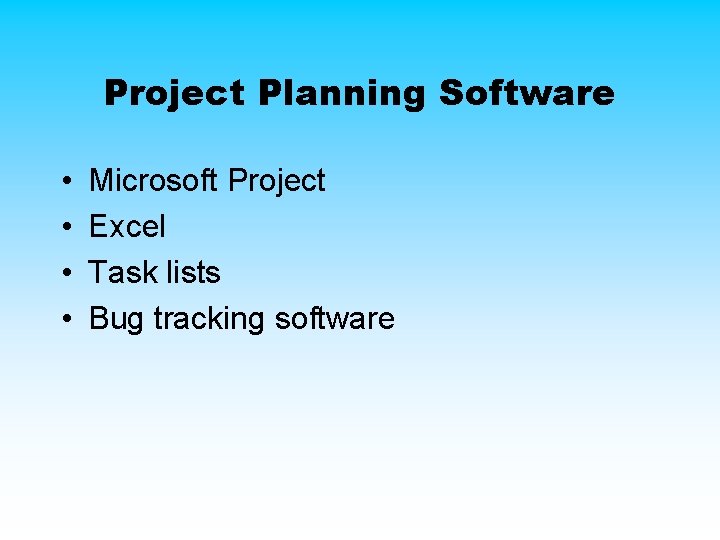

Project Planning Software • • Microsoft Project Excel Task lists Bug tracking software

Project Planning Software • • Microsoft Project Excel Task lists Bug tracking software

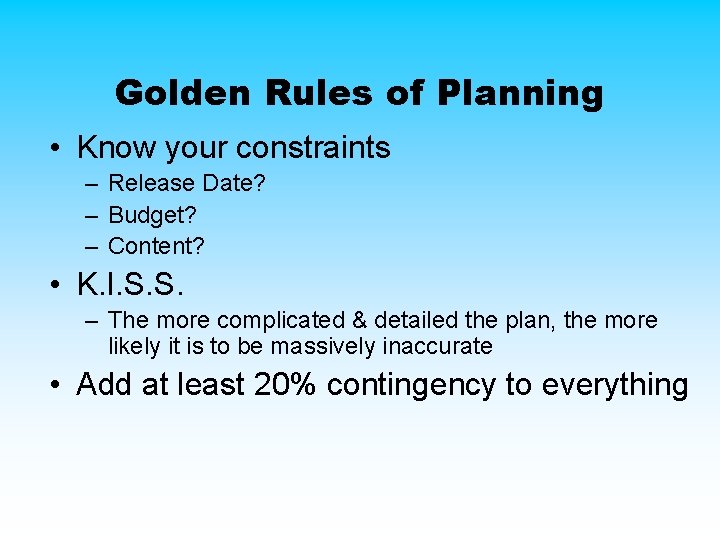

Golden Rules of Planning • Know your constraints – Release Date? – Budget? –

Golden Rules of Planning • Know your constraints – Release Date? – Budget? – Content? • K. I. S. S. – The more complicated & detailed the plan, the more likely it is to be massively inaccurate • Add at least 20% contingency to everything

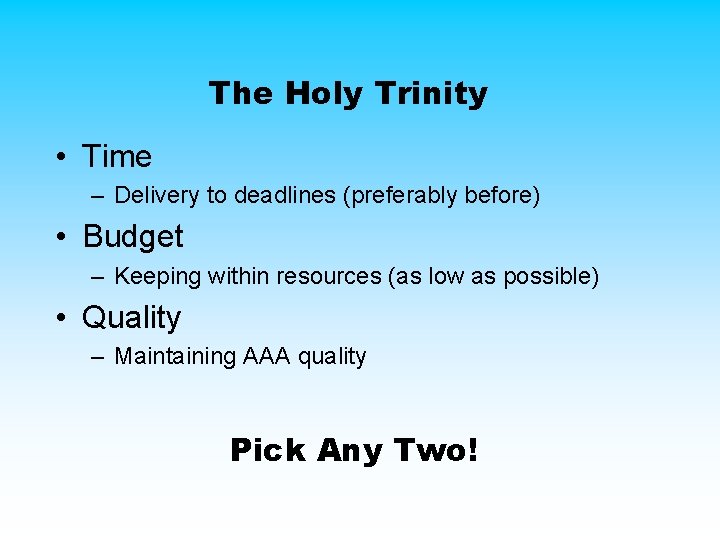

The Holy Trinity • Time – Delivery to deadlines (preferably before) • Budget –

The Holy Trinity • Time – Delivery to deadlines (preferably before) • Budget – Keeping within resources (as low as possible) • Quality – Maintaining AAA quality Pick Any Two!

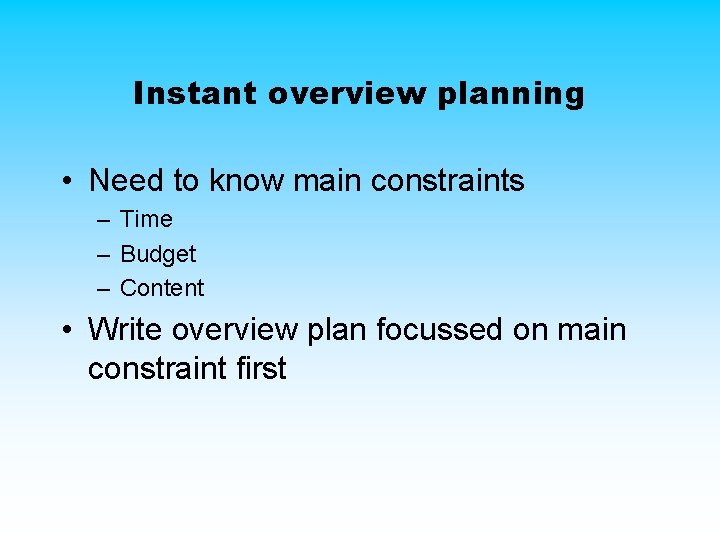

Instant overview planning • Need to know main constraints – Time – Budget –

Instant overview planning • Need to know main constraints – Time – Budget – Content • Write overview plan focussed on main constraint first

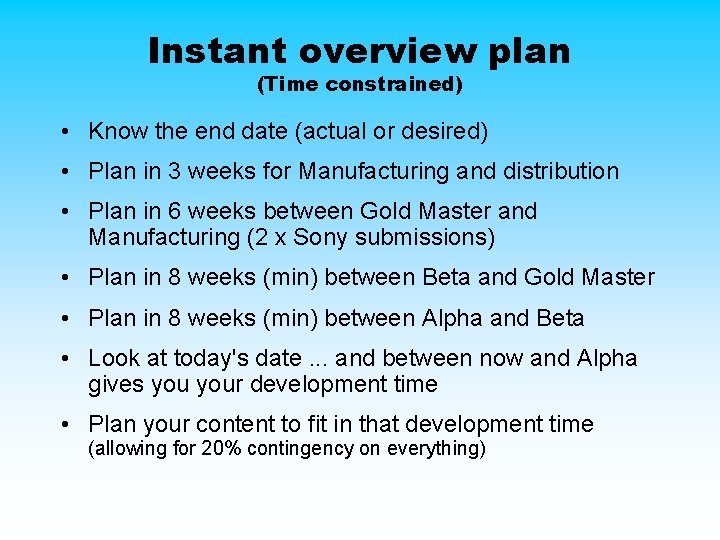

Instant overview plan (Time constrained) • Know the end date (actual or desired) •

Instant overview plan (Time constrained) • Know the end date (actual or desired) • Plan in 3 weeks for Manufacturing and distribution • Plan in 6 weeks between Gold Master and Manufacturing (2 x Sony submissions) • Plan in 8 weeks (min) between Beta and Gold Master • Plan in 8 weeks (min) between Alpha and Beta • Look at today's date. . . and between now and Alpha gives your development time • Plan your content to fit in that development time (allowing for 20% contingency on everything)

Instant overview plan Time Constrained - example Task name Production Start Release Date Duration

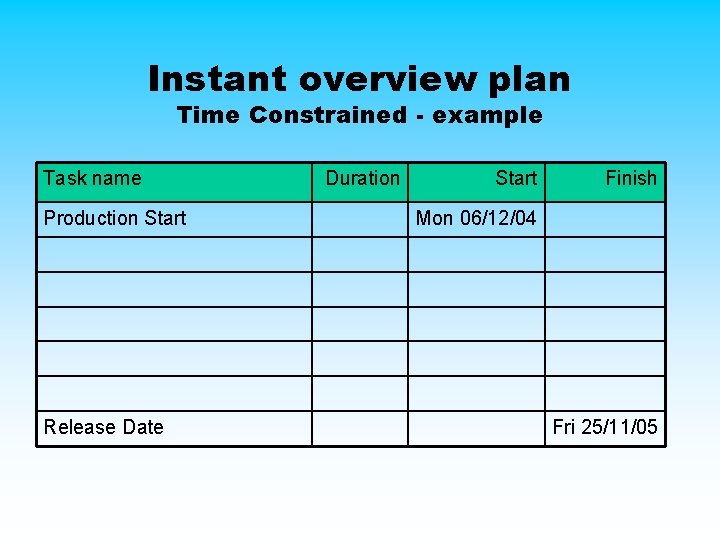

Instant overview plan Time Constrained - example Task name Production Start Release Date Duration Start Finish Mon 06/12/04 Fri 25/11/05

Instant overview plan Time Constrained - example Task name Production Start Manufacturing & Distribution

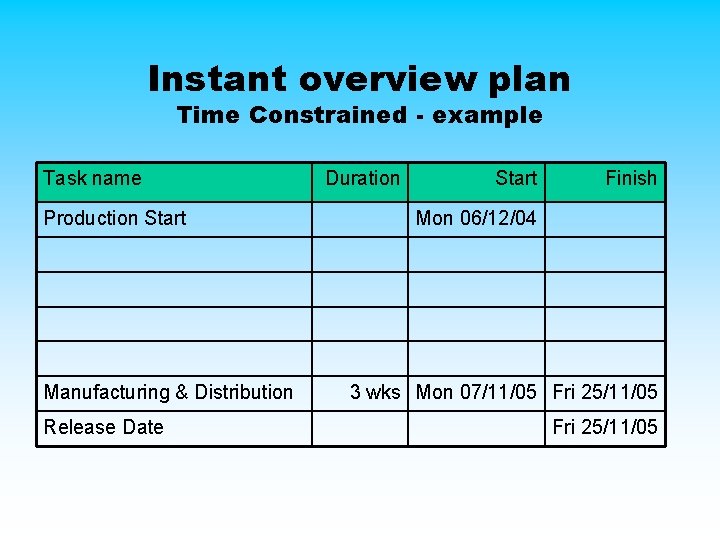

Instant overview plan Time Constrained - example Task name Production Start Manufacturing & Distribution Release Date Duration Start Finish Mon 06/12/04 3 wks Mon 07/11/05 Fri 25/11/05

Instant overview plan Time Constrained - example Task name Production Start Duration Start Finish

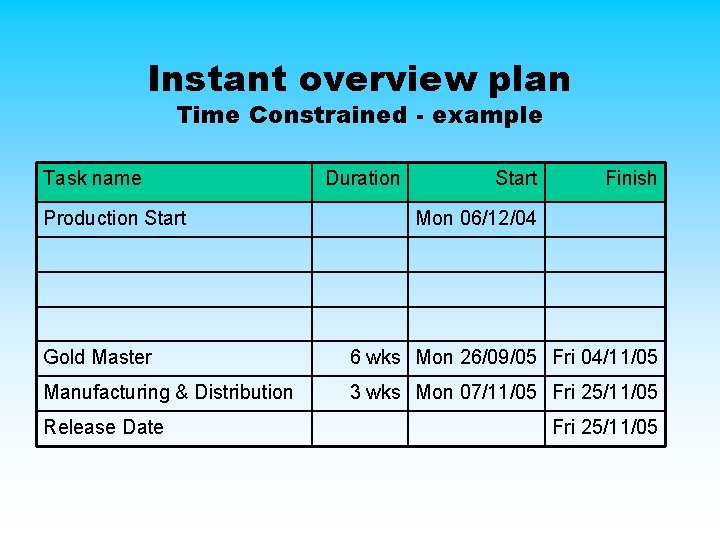

Instant overview plan Time Constrained - example Task name Production Start Duration Start Finish Mon 06/12/04 Gold Master 6 wks Mon 26/09/05 Fri 04/11/05 Manufacturing & Distribution 3 wks Mon 07/11/05 Fri 25/11/05 Release Date Fri 25/11/05

Instant overview plan Time Constrained - example Task name Production Start Duration Start Finish

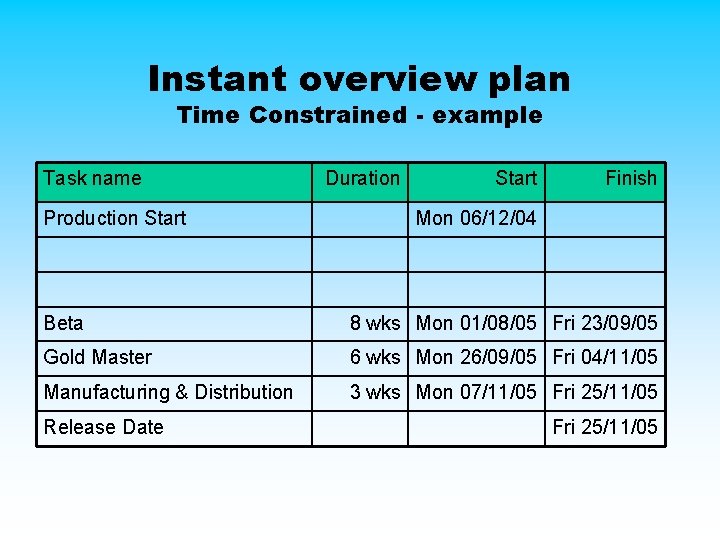

Instant overview plan Time Constrained - example Task name Production Start Duration Start Finish Mon 06/12/04 Beta 8 wks Mon 01/08/05 Fri 23/09/05 Gold Master 6 wks Mon 26/09/05 Fri 04/11/05 Manufacturing & Distribution 3 wks Mon 07/11/05 Fri 25/11/05 Release Date Fri 25/11/05

Instant overview plan Time Constrained - example Task name Production Start Duration Start Finish

Instant overview plan Time Constrained - example Task name Production Start Duration Start Finish Mon 06/12/04 Alpha 8 wks Mon 06/06/05 Fri 29/07/05 Beta 8 wks Mon 01/08/05 Fri 23/09/05 Gold Master 6 wks Mon 26/09/05 Fri 04/11/05 Manufacturing & Distribution 3 wks Mon 07/11/05 Fri 25/11/05 Release Date Fri 25/11/05

Instant overview plan Time Constrained - example Task name Production Start Production Duration Start

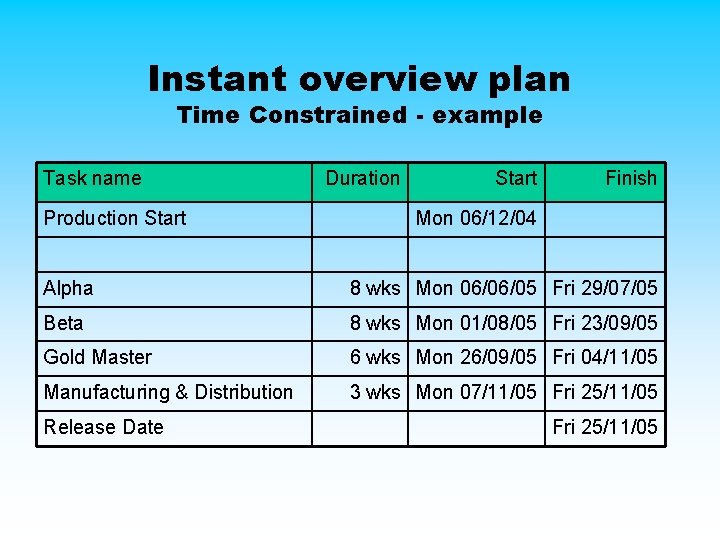

Instant overview plan Time Constrained - example Task name Production Start Production Duration Start Finish Mon 06/12/04 26 wks Mon 06/12/04 Fri 06/06/05 Alpha 8 wks Mon 06/06/05 Fri 29/07/05 Beta 8 wks Mon 01/08/05 Fri 23/09/05 Gold Master 6 wks Mon 26/09/05 Fri 04/11/05 Manufacturing & Distribution 3 wks Mon 07/11/05 Fri 25/11/05 Release Date Fri 25/11/05

Budget constrained • • Same principle as for time constrained Put in end phase

Budget constrained • • Same principle as for time constrained Put in end phase times (but don’t lock release) Work out how much man-time you’ve got Calculate how many man hours you require for end phase • Subtract from total man hours. • Remainder = development time • Plan content accordingly

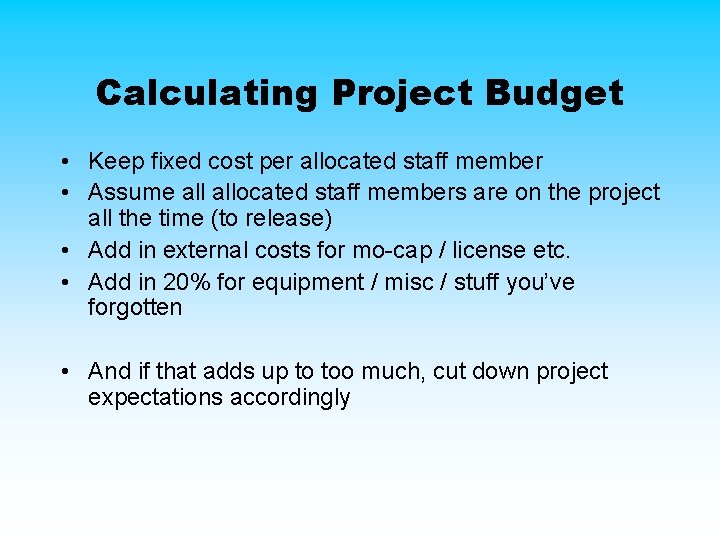

Calculating Project Budget • Keep fixed cost per allocated staff member • Assume allocated

Calculating Project Budget • Keep fixed cost per allocated staff member • Assume allocated staff members are on the project all the time (to release) • Add in external costs for mo-cap / license etc. • Add in 20% for equipment / misc / stuff you’ve forgotten • And if that adds up to too much, cut down project expectations accordingly

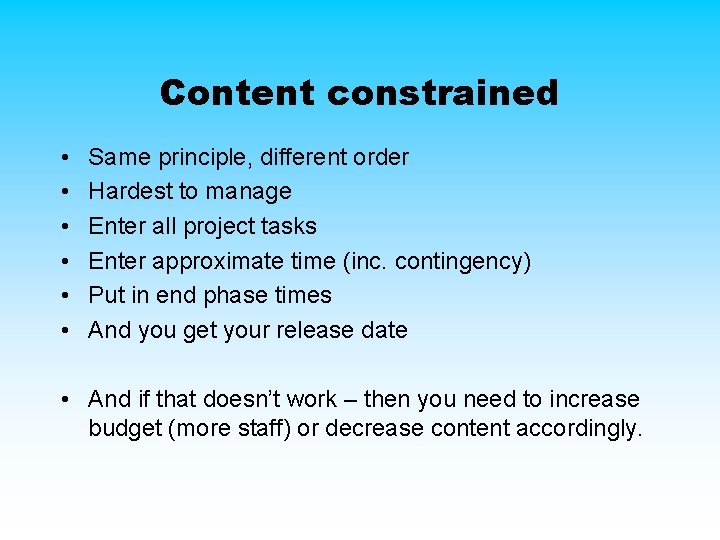

Content constrained • • • Same principle, different order Hardest to manage Enter all

Content constrained • • • Same principle, different order Hardest to manage Enter all project tasks Enter approximate time (inc. contingency) Put in end phase times And you get your release date • And if that doesn’t work – then you need to increase budget (more staff) or decrease content accordingly.

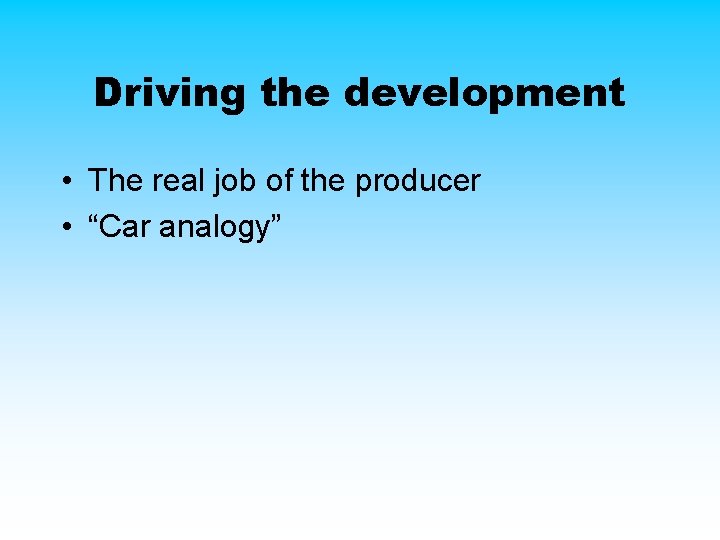

Driving the development • The real job of the producer • “Car analogy”

Driving the development • The real job of the producer • “Car analogy”

Managing the development • Taking the project through the key development phases • Avoiding

Managing the development • Taking the project through the key development phases • Avoiding problems • Keeping focus

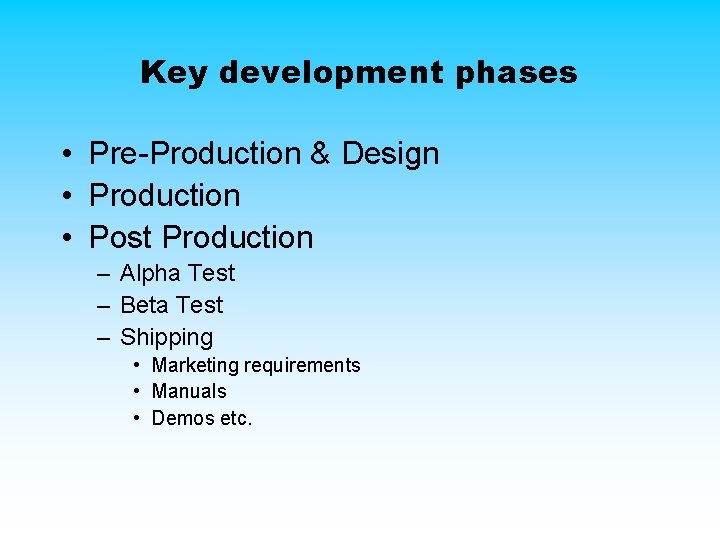

Key development phases • Pre-Production & Design • Production • Post Production – Alpha

Key development phases • Pre-Production & Design • Production • Post Production – Alpha Test – Beta Test – Shipping • Marketing requirements • Manuals • Demos etc.

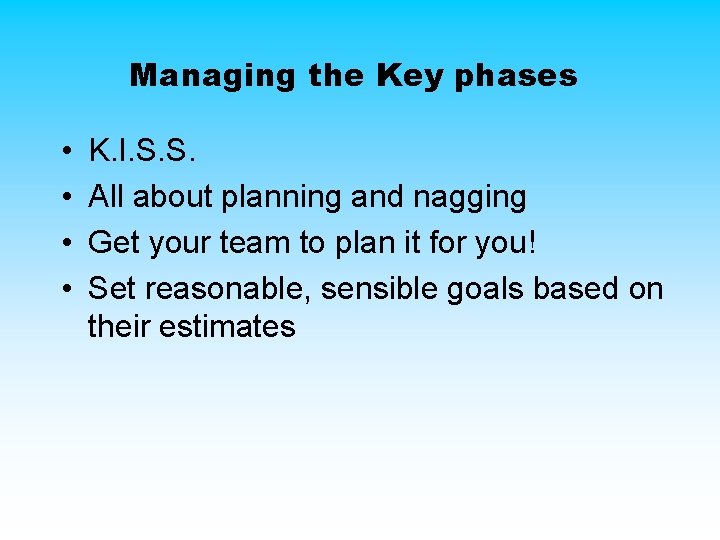

Managing the Key phases • • K. I. S. S. All about planning and

Managing the Key phases • • K. I. S. S. All about planning and nagging Get your team to plan it for you! Set reasonable, sensible goals based on their estimates

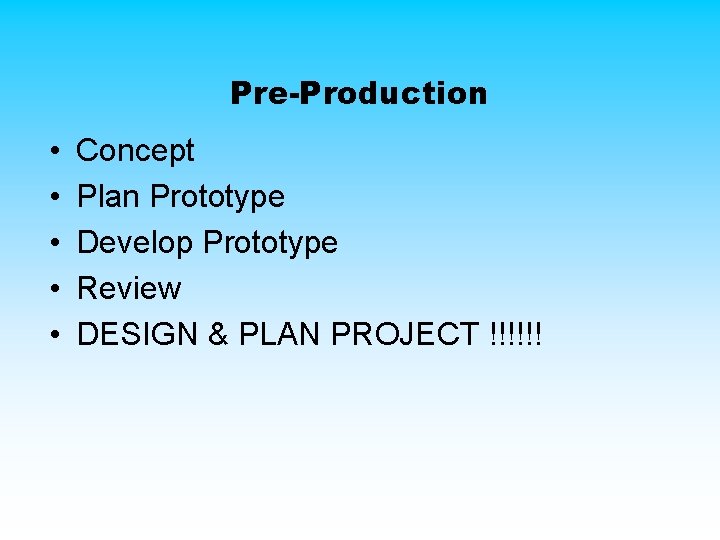

Pre-Production • • • Concept Plan Prototype Develop Prototype Review DESIGN & PLAN PROJECT

Pre-Production • • • Concept Plan Prototype Develop Prototype Review DESIGN & PLAN PROJECT !!!!!!

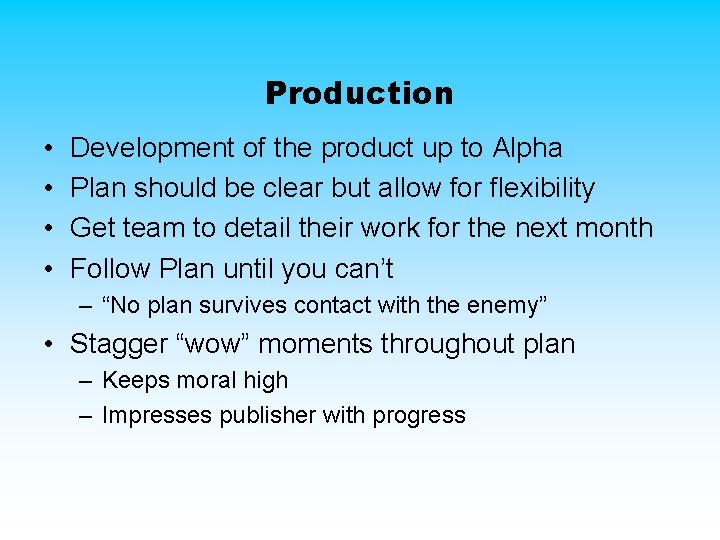

Production • • Development of the product up to Alpha Plan should be clear

Production • • Development of the product up to Alpha Plan should be clear but allow for flexibility Get team to detail their work for the next month Follow Plan until you can’t – “No plan survives contact with the enemy” • Stagger “wow” moments throughout plan – Keeps moral high – Impresses publisher with progress

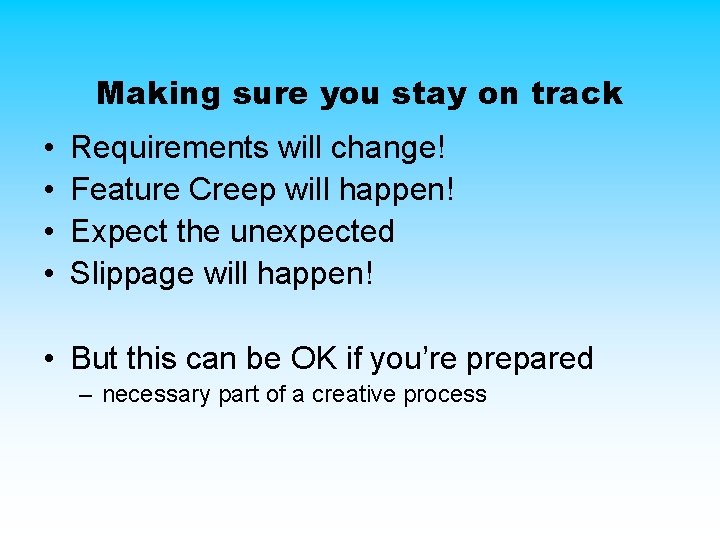

Making sure you stay on track • • Requirements will change! Feature Creep will

Making sure you stay on track • • Requirements will change! Feature Creep will happen! Expect the unexpected Slippage will happen! • But this can be OK if you’re prepared – necessary part of a creative process

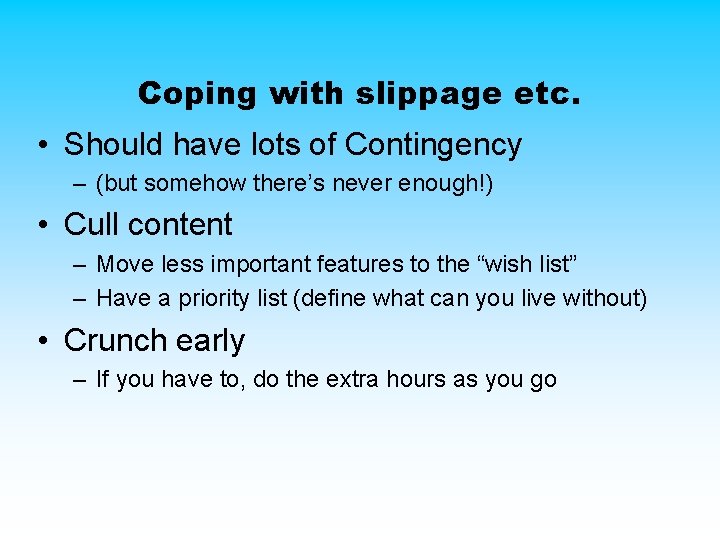

Coping with slippage etc. • Should have lots of Contingency – (but somehow there’s

Coping with slippage etc. • Should have lots of Contingency – (but somehow there’s never enough!) • Cull content – Move less important features to the “wish list” – Have a priority list (define what can you live without) • Crunch early – If you have to, do the extra hours as you go

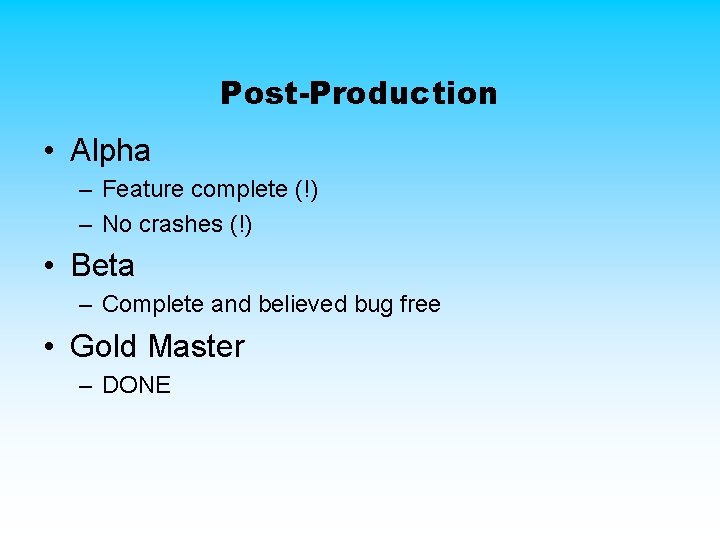

Post-Production • Alpha – Feature complete (!) – No crashes (!) • Beta –

Post-Production • Alpha – Feature complete (!) – No crashes (!) • Beta – Complete and believed bug free • Gold Master – DONE

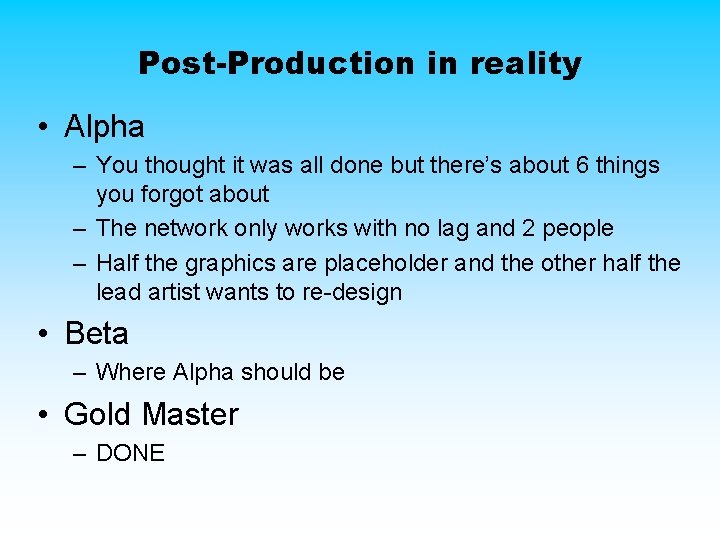

Post-Production in reality • Alpha – You thought it was all done but there’s

Post-Production in reality • Alpha – You thought it was all done but there’s about 6 things you forgot about – The network only works with no lag and 2 people – Half the graphics are placeholder and the other half the lead artist wants to re-design • Beta – Where Alpha should be • Gold Master – DONE

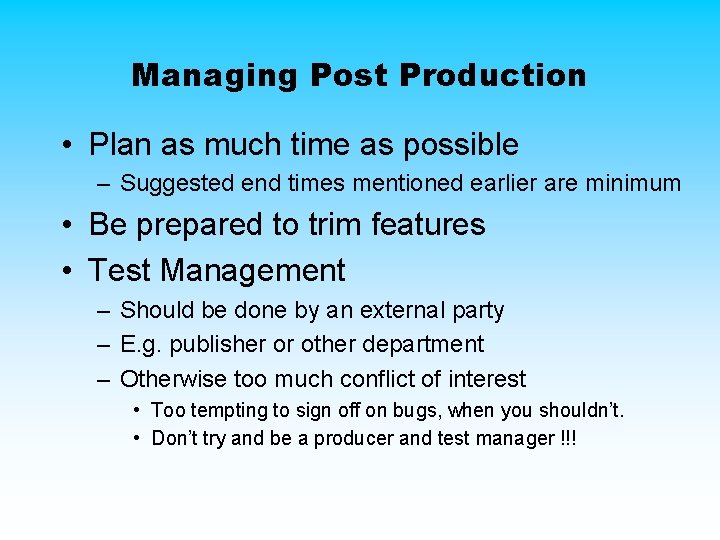

Managing Post Production • Plan as much time as possible – Suggested end times

Managing Post Production • Plan as much time as possible – Suggested end times mentioned earlier are minimum • Be prepared to trim features • Test Management – Should be done by an external party – E. g. publisher or other department – Otherwise too much conflict of interest • Too tempting to sign off on bugs, when you shouldn’t. • Don’t try and be a producer and test manager !!!

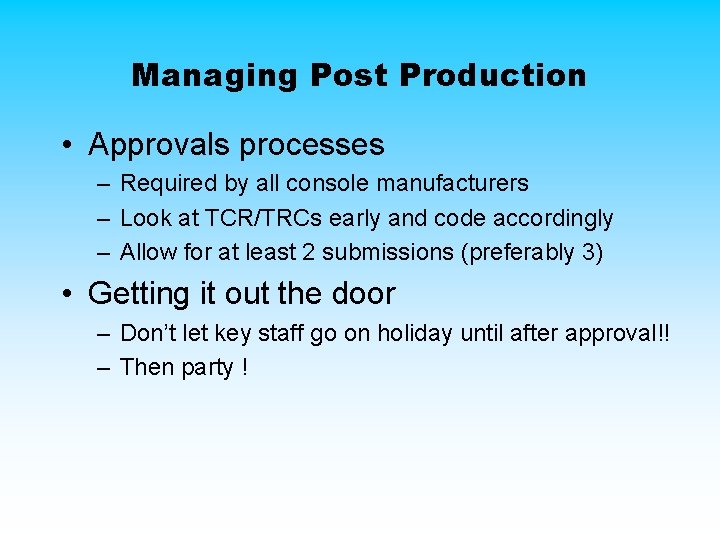

Managing Post Production • Approvals processes – Required by all console manufacturers – Look

Managing Post Production • Approvals processes – Required by all console manufacturers – Look at TCR/TRCs early and code accordingly – Allow for at least 2 submissions (preferably 3) • Getting it out the door – Don’t let key staff go on holiday until after approval!! – Then party !
