Financing Transaction Module 5 Project Financing Outline 1

  • Slides: 42
Download presentation
Financing & Transaction Module 5 Project Financing: Outline 1. The carbon market 2. CER

Financing & Transaction Module 5 Project Financing: Outline 1. The carbon market 2. CER Purchasers 3. Transactions Strategy 4. Matching projects to investors 5. ERPAs

Introduction • Your project’s CERs can be sold for a price in the global

Introduction • Your project’s CERs can be sold for a price in the global carbon market • They are one of the ‘products’ your project generates • They are an important part of your project’s financial package • You can use them in return for technology, investment, upfront project finance, or to secure loan finance • Alternatively you can sell them to generate a revenue stream to your project over its lifetime

Know your project’s CER profile! Identify up front: • How large is the total

Know your project’s CER profile! Identify up front: • How large is the total volume of CERs your project will generate? (> 500, 000 t? (medium) > 1 million t (large)? ) • How is this volume distributed over the project’s lifetime? • What is the average annual CER generation? • Is your project Gold Standard?

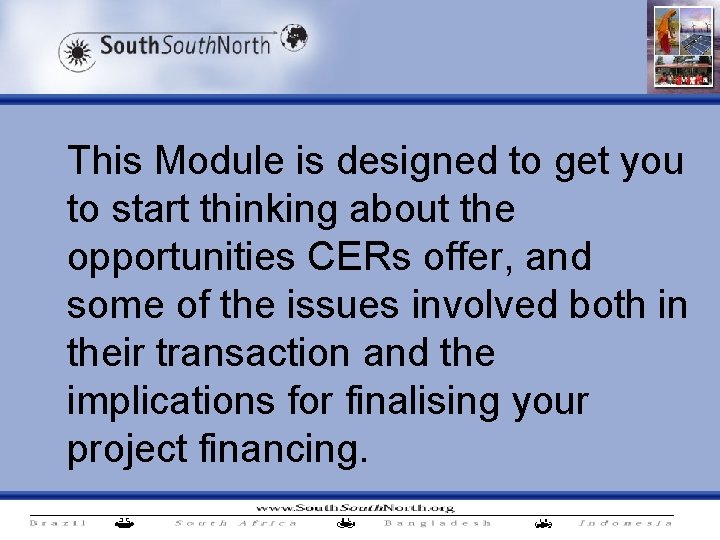

This Module is designed to get you to start thinking about the opportunities CERs

This Module is designed to get you to start thinking about the opportunities CERs offer, and some of the issues involved both in their transaction and the implications for finalising your project financing.

1. The Carbon Market What is it? ‘The international transaction of greenhouse gas emission

1. The Carbon Market What is it? ‘The international transaction of greenhouse gas emission reduction credits’ -Emissions trading schemes (Cap and Trade) -Project credits (Baseline and Credit)

Global Carbon Credit Transactions Canadian Scheme starting 2007 Denmark power generating scheme UK scheme

Global Carbon Credit Transactions Canadian Scheme starting 2007 Denmark power generating scheme UK scheme 2001 -3 started 2002 EU scheme started 2005 Japanese Scheme planned Chicago Climate Exchange New South Wales scheme

Compliance Timeline First Kyoto Commitment Period First Phase EU Emissions Trading Scheme 2005 16

Compliance Timeline First Kyoto Commitment Period First Phase EU Emissions Trading Scheme 2005 16 Feb 2005 Kyoto entered into force 2008 ? (Second Phase EU Scheme) 2012 Second Commitment Period

What is traded? Units = 1 tonne CO 2 e reduced or stored -

What is traded? Units = 1 tonne CO 2 e reduced or stored - AAUs ERUs CERs Carbon capture and storage units VERs

2. CER Purchasers Who is purchasing CERs? Annex One: • Governments • CDM funds

2. CER Purchasers Who is purchasing CERs? Annex One: • Governments • CDM funds • Companies Offset Purchasers

Investors vs Buyers • Investors: – Contribute • Capital • Technology – Receive •

Investors vs Buyers • Investors: – Contribute • Capital • Technology – Receive • Equity/Profit share • CER ownership • Buyers: – Purchase CERs for $

Transaction Timing You can transact at any stage of your project’s development! PIN •

Transaction Timing You can transact at any stage of your project’s development! PIN • PDD • Validation • DNA approval • Project commissioned / implemented • Project registered • CERs issued • The timing has implications for the type of transaction, price, and whom you transact with

The Three Broad Transaction Choices… 1 2 Get a partner/investor on board at outset

The Three Broad Transaction Choices… 1 2 Get a partner/investor on board at outset Self develop the project and sell CERs forward at some point during project development 3 Self develop The project and sell the CER’s on the spot market

Transaction Modes • Spot market purchase • Forward sale - option - right of

Transaction Modes • Spot market purchase • Forward sale - option - right of first refusal - price: fixed / floating / marked to market

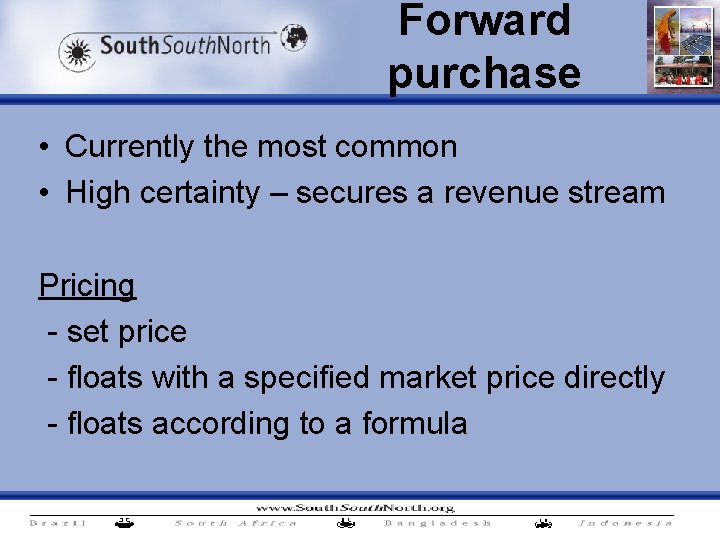

Forward purchase • Currently the most common • High certainty – secures a revenue

Forward purchase • Currently the most common • High certainty – secures a revenue stream Pricing - set price - floats with a specified market price directly - floats according to a formula

Options • An option is an open right to make the choice to purchase

Options • An option is an open right to make the choice to purchase • An option taker may pay for this right (upfront or in the credit price) • The price may be stipulated • The right does not mean that the option holder WILL purchase • You could have a meet-and-beat clause • An option can be used to raise finance, but its not a guarantee…

Right of first refusal • This is a form of option where the option

Right of first refusal • This is a form of option where the option holder has an absolute right to be the first person to refuse or take up the credits • The contract will stipulate when the right is available to be taken up • You would have to stipulate the price, or a price formula in advance

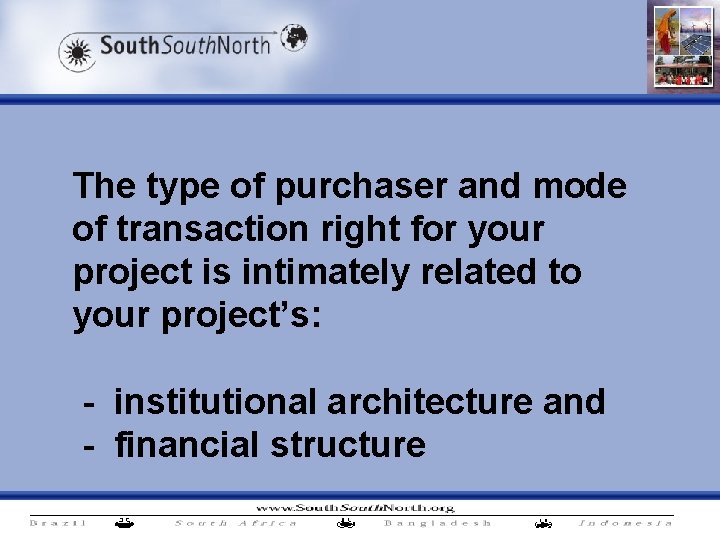

The type of purchaser and mode of transaction right for your project is intimately

The type of purchaser and mode of transaction right for your project is intimately related to your project’s: - institutional architecture and - financial structure

4. Transactions Strategy • Do I need an investment partner? • Do I need

4. Transactions Strategy • Do I need an investment partner? • Do I need upfront financing for my project? • Is there a transfer of technology involved? • Do I need loan collateral? • What are my objectives in the CER transaction?

Developing your transaction strategy Components: 1. project risk profile (conventional and CDM) 2. current

Developing your transaction strategy Components: 1. project risk profile (conventional and CDM) 2. current carbon market risk profile 3. project’s cash flow requirements 4. owner’s transaction requirements,

1. Project Risk Profile • At various points of the project cycle, there exist

1. Project Risk Profile • At various points of the project cycle, there exist levels of risk • These risks are both normal project risk, and additional risks related to the CDM • Consider moments of risk, timing of these risks and MITIGATION strategies. • You can structure your project so that risk is shared (investor, partner), transferred through the credit sale, or taken by the seller in a spot market sale.

Stages of Risk I • Country appraisal – Stability • Environmental, labour, institutional –

Stages of Risk I • Country appraisal – Stability • Environmental, labour, institutional – Lawlessness – Litigiousness MINIMISE BY: Ø Produce a country assessment report! Ø Consider the use of country risk protection as part of the financial structure

Stage of Risk II • Project Approval – Is the DNA in existence? –

Stage of Risk II • Project Approval – Is the DNA in existence? – What are the rules and process track – Will the Project contribute to Sustainable Development? MINIMISE RISKS BY: Ø Design project according to the Gold Standard SD criteria Ø Obtain a host government Letter of No Objection

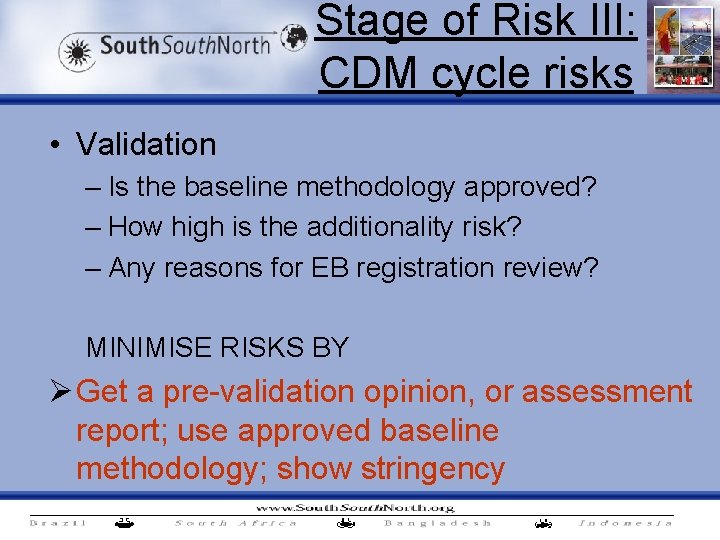

Stage of Risk III: CDM cycle risks • Validation – Is the baseline methodology

Stage of Risk III: CDM cycle risks • Validation – Is the baseline methodology approved? – How high is the additionality risk? – Any reasons for EB registration review? MINIMISE RISKS BY Ø Get a pre-validation opinion, or assessment report; use approved baseline methodology; show stringency

Stage of Risk IV: Financial Feasibility • Has the project secured all its underlying

Stage of Risk IV: Financial Feasibility • Has the project secured all its underlying finance? • How liquid is the Project Participant in relation to the timing of the production of CERs? • How creditworthy is the project owner? • How far has the financial contracted for the underlying project progressed? • What are the profit margins in respect of the bigger project MINIMISE RISKS BY • Seeking the advice of a project finance specialist; progressing the financing as far as possible; producing financial statements for the project

Stage of Risk V: Technological Feasibility • Does the project rely on reliable and

Stage of Risk V: Technological Feasibility • Does the project rely on reliable and locally tested Technology? • What is the relationship between the technology and the baseline? • How complicated is the technology? • What provision is there for ongoing training and maintenance? • What possibility is there for technology proliferation/on-selling? What likelihood is there for take-up of the technology? MINIMISE RISK BY Ø Undertaking a pilot; using locally tested technology

Stage of Risk VI: Underperformance • How high is the chance that the predicted

Stage of Risk VI: Underperformance • How high is the chance that the predicted emission reductions won’t be achieved? • Is it possible to secure performance insurance? • How high are the contractual, market demand, exchange rate and other conventional project risks? Are they insured? • How positive is the project’s relationship with its stakeholders? MINIMISE RISK BY • Secure project insurance; undertake detailed stakeholder consultation; elaborate contingency plans in the event of each performance risk.

Lowering your CDM project risks Project Idea Note • New Methodology approved • Stakeholder

Lowering your CDM project risks Project Idea Note • New Methodology approved • Stakeholder consultation • PDD Complete • Financial feasibility with all shareholders identified • Technological feasibility undertaken • DOE identified • Validation Complete • DNA approval complete • Financial close achieved • Project commissioned / implemented • Registered Project • CERs issued RISK •

2. Current Carbon Market Risk Profile • How advanced are 2 CP negotiations? •

2. Current Carbon Market Risk Profile • How advanced are 2 CP negotiations? • What prices are CERs fetching at the moment? • What stage of CER is currently being purchased (approved? , validated? , registered? ) • What is the status of Canadian demand for CERs? • How robust is the offset market? MINIMISE RISK BY Ø Undertake a market assessment; contact brokers to get a feel for current prices; plan the timing of your sale

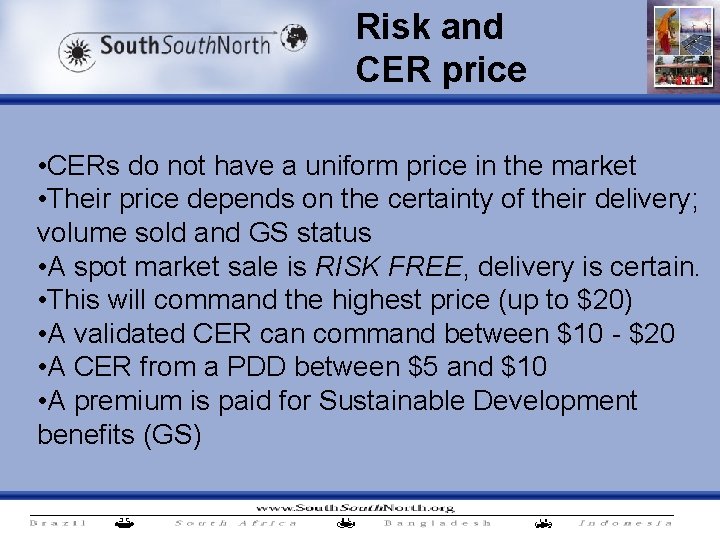

Risk and CER price • CERs do not have a uniform price in the

Risk and CER price • CERs do not have a uniform price in the market • Their price depends on the certainty of their delivery; volume sold and GS status • A spot market sale is RISK FREE, delivery is certain. • This will command the highest price (up to $20) • A validated CER can command between $10 - $20 • A CER from a PDD between $5 and $10 • A premium is paid for Sustainable Development benefits (GS)

SSN Toolkit Group Exercise: Aligning project and market risk

SSN Toolkit Group Exercise: Aligning project and market risk

3. Your Project’s Cash Flow Requirements Workshop Activity: (Project cash flow exercise A) •

3. Your Project’s Cash Flow Requirements Workshop Activity: (Project cash flow exercise A) • Is your project profitable (positive IRR) without the CER revenues? • At what points over the project’s lifetime does it require CER revenues? • Is up-front CER revenue required?

4. Owner’s Transaction Objectives - Why are you undertaking a CDM project? Do you

4. Owner’s Transaction Objectives - Why are you undertaking a CDM project? Do you need revenue from the CER stream? Are you experimenting and learning about the CDM? Do you need to secure a relationship with a technology partner? - Do you have a timeframe for transaction? Do you need an early transaction to demonstrate confidence in the CDM to your organisation? - Is this a funder driven project? Do they require CERs? - Do you have a particular CER price need?

Transaction Strategy: Putting it all together. . . What are the implications of your

Transaction Strategy: Putting it all together. . . What are the implications of your transaction objectives on: - type of purchaser? Mode of transaction? Timing? Volume? Assess your project’s cash requirements relative to the CER forward price schedule: - when is the best time to transact to realise the highest possible CER revenue? (Note you can transact a number of years CERs in one go)

Remember: Three Broad Transaction Choices… 1 2 Get a partner/investor on board at outset

Remember: Three Broad Transaction Choices… 1 2 Get a partner/investor on board at outset Self develop the project and sell CERs forward at some point during project development 3 Self develop The project and sell the CER’s on the spot market

Option 1: RISK: here the risk is zero: you get help to put together

Option 1: RISK: here the risk is zero: you get help to put together the project and you get money upfront for development REWARD: the reward is a financed and transacted project Get a partner/investor on board at outset CER PRICE: will obviously be greatly discounted against risk OTHER: Low control, autonomy and capacity transfer

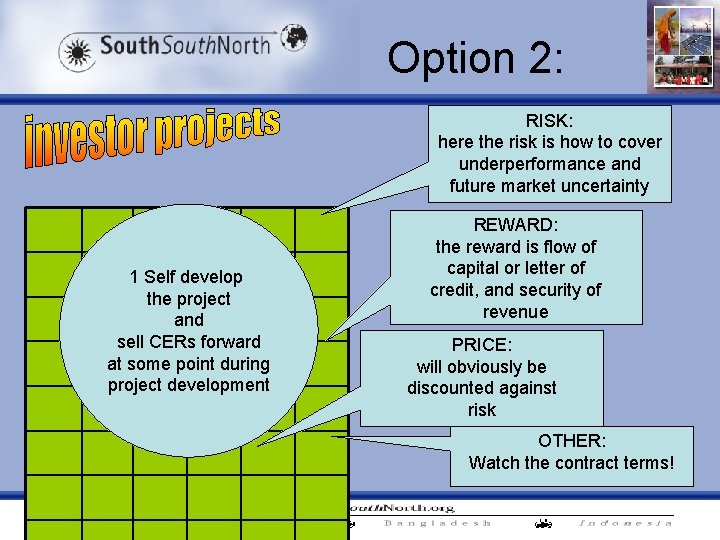

Option 2: RISK: here the risk is how to cover underperformance and future market

Option 2: RISK: here the risk is how to cover underperformance and future market uncertainty 1 Self develop the project and sell CERs forward at some point during project development REWARD: the reward is flow of capital or letter of credit, and security of revenue PRICE: will obviously be discounted against risk OTHER: Watch the contract terms!

Option 3: RISK: here the risk is the market price at time of going

Option 3: RISK: here the risk is the market price at time of going to market (issuance or beyond) REWARD: have to self finance, but rewards could be great Self develop The project and sell the CER’s on the spot market PRICE: prevailing price, Maximum benefit if price is good OTHER: High control, autonomy and capacity building

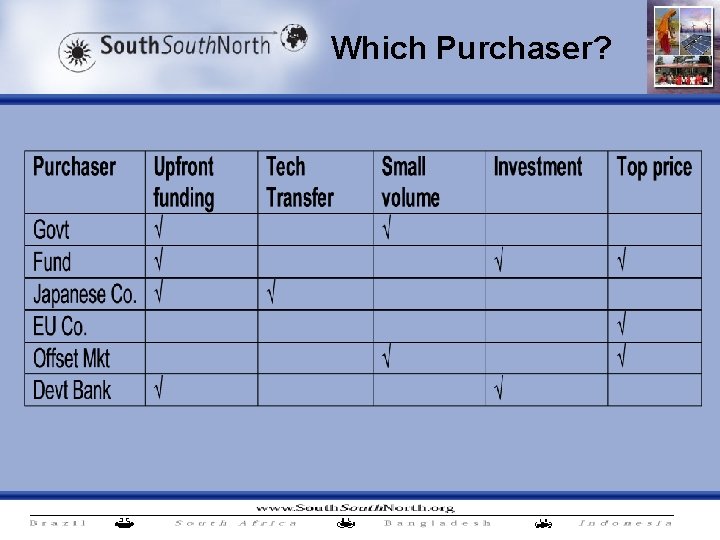

Which Purchaser?

Which Purchaser?

Purchaser PINS • Purchasers transacting via options 1 and 2 (forward sales) often require

Purchaser PINS • Purchasers transacting via options 1 and 2 (forward sales) often require project information in their own PIN format • These all differ, but may require specific information on: – – the seller’s creditworthiness project financing other project partners project risk profile

5. ERPAs • The contract for a forward sale of CERs is called an

5. ERPAs • The contract for a forward sale of CERs is called an Emission Reduction Purchase Agreement (ERPA) • This sets out the terms and price of the transaction • A number of standard ERPAs are publicly available • Buyers may prefer to use their own ERPA

ERPAs (cont. ) • The terms of the ERPA are as, if not more

ERPAs (cont. ) • The terms of the ERPA are as, if not more important than the price! • You need a lawyer with CDM expertise to review the ERPA • You may sign a number of ERPAs for your project if you transact with more than one purchaser

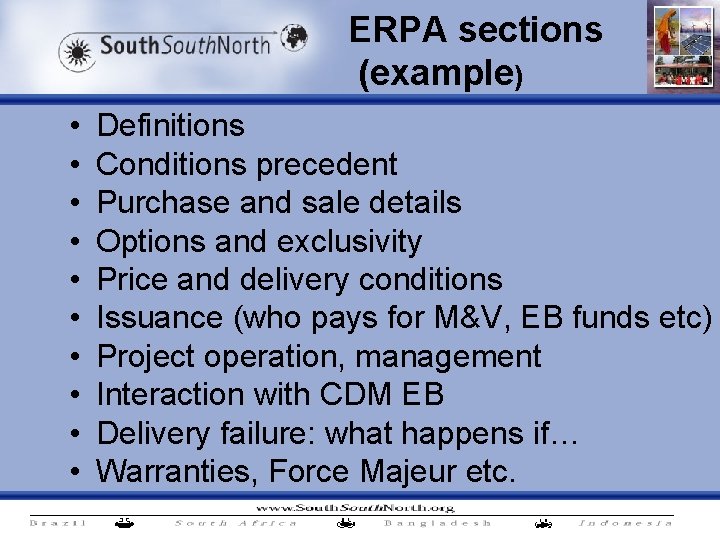

ERPA sections (example) • • • Definitions Conditions precedent Purchase and sale details Options

ERPA sections (example) • • • Definitions Conditions precedent Purchase and sale details Options and exclusivity Price and delivery conditions Issuance (who pays for M&V, EB funds etc) Project operation, management Interaction with CDM EB Delivery failure: what happens if… Warranties, Force Majeur etc.
