EPC converters in SPS complex ISTs and Hardware

  • Slides: 25
Download presentation

EPC converters in SPS complex ISTs and Hardware commissioning Ø Master schedule Ø Organisation,

EPC converters in SPS complex ISTs and Hardware commissioning Ø Master schedule Ø Organisation, definition & application on converter ) T 2 S I Ø Sectorisation # e o r i d r o o i f Ø IST/HWC periods (for EPC projects) a r e e n b T p e Ø EPC needs & requests Sc ent ard IS r d r n Ø Follow up form a u t s c th i o Ø Safety (n W Ø EPC equipment (up to medium power & Main converters) L. De Oliveira 15 th Sept. 2019 2

Actual schedule for SPS complex: 10 th august 2020 21 th Sept. 2020 (6

Actual schedule for SPS complex: 10 th august 2020 21 th Sept. 2020 (6 weeks) tests IST period DSO 18 th Sept. 2020 16 th November 2020 Hardware commissioning (8 weeks) Mas ter s ched ule 3

Organisation, definition & application on converter q q (Manage by EN-ACE) Machine in access

Organisation, definition & application on converter q q (Manage by EN-ACE) Machine in access and partially not powered Coordination of activities through facility coordinators Individual system tests Dry runs IST : Master + EPC work lockouts If necessary AC lockouts move to DC Converter installation/modification Electronic tests on EPC equipment (Control, intlk tests) Imag=0 A ü 18 k. V consolidation pre-tests (EN-EL hand over to EPC) ü ü M ac hi ne OP EN Long Shutdown : Machine OPEN + ACE access control (Manage by EN-ACE) q Need to be carried out before dry runs and hardware commissioning tests q Not executed in operational environment, not relying on operational tools nor (necessarily) scenario q Defined by equipment experts (example: conditioning of kickers) EPC context Current sent to load IF & only IF NO current on load Followingthe the. Buildingplanning üüFollowing Balisageononload(singlemagnet) üüBalisage Sectorization(multiplemagnets) üüSectorization If not fulfill conditions Tests during HWC I ≠ 0 A Tests during HWC : (Manage by BE-OP) Machine CLOSED q Machine closed Current sent to load IF Current on load q Individual system tests (on particular system) ü Following the OP planning q Final qualification of all equipment and controls for beam according to ü Following the OP planning ü Tests ü Power tests indicated (surface & & underground) operational scenarios and with operational tools 4

With Power Service IST / HWC for EPC equipment: 1. 2. 3. 4. 5.

With Power Service IST / HWC for EPC equipment: 1. 2. 3. 4. 5. 6. 7. 8. 9. 10. 11. 12. 13. 14. Converter inspected by HSE (Electrical) and ready to be powered Power Converter connected to the AC network and the responsibility transferred to EPC Power Converter connected to the Water Circuit Control infrastructure validated EIS out-of-chain and interface validated Power converter water interlock operational [WIC] <=> [power converter] interface comissionning Insulation tests on the DC magnets + cables Connection to Magnet Current loop tuning (10 % I. nom) Possible during IST period if: Polarity check (circuit and magnet) • Balisage on magnet Current loop tuning at I. max • Isolated test sector Heat run at I. mag [BIS Interlock / External conditions] <=> [power converter] interface comissionning. Important to consider for EPC: ü ü ü Standard process IST period EPC pre-test (Load disconnected) IST period Hardware commissioning Powering test HWC period OPTIMIZATION with EPC follow-up form Commissioning OR restart tests Range of power converter ( load distribution around the machine) Check if particular sector can be fully isolated for powering test (TT 20/TT 40/…) Balisage in the machine ! (EPC on surface and MSC in underground) Ensure availibility of different services (AC + cooling + WIC + etc…) to maximum anticipated ISTs! Implement in the planning the different possible slots (in function on constraints, buildings, lines, …) 5

To consider for EPC preliminary-tests: (Imag = 0) q q HSE agreement = Start

To consider for EPC preliminary-tests: (Imag = 0) q q HSE agreement = Start point for EPC pre-tests No current on machine (move lockout to DC) Y T No co-activities around converter locations E F A S Move Lockouts to DC cables (if possible) q q q Plan HSE inspection Availibilities of different services (AC + cooling + WIC + etc…) Plan Hand-over tasks (with EN-EL) PLANNING Plan EPC preliminary tests (up to Uloop) Plan Functional tests with ICS (cvs interlocked on new EIS-PPS) DC DC DC Magnet 6

To consider for IST: (Imag ≠ 0) q Sectorization & balisage (constraints, close area)

To consider for IST: (Imag ≠ 0) q Sectorization & balisage (constraints, close area) q Who manage these tasks, & who approve? q SAFETY in these conditions To discuss !!! q Connection to magnet = Start point for IST q Dedicated for low current CURRENT tests (10%. Inom on magnet) q Optimize test sequences (EPC follow-up form to reduce impact of HWC) To consider for HWC (powering tests): q q (Imag ≠ 0) DSO test validated Dedicated for full CURRENT tests (100%. Inom on magnet) Possibility to control converters at same time (independently of location) Optimize test sequences (EPC follow-up form to reduce impact on HWC period) 7

G 4 PP BA 2 BA 4/BB 4 TI 8 SPS PPG 2003 PPG

G 4 PP BA 2 BA 4/BB 4 TI 8 SPS PPG 2003 PPG 5003 3 BA 5 00 PPG 61031 TS 6 Sextant 6 3 0 TT 1 TT 60 00 PP G 1 8 82 02 BA 6 TI 2 G 6 PP G 1 PP 1 1 TS ant xt Se BA 1 TT 4 1 Se TS 5 xt an t 5 G 2 4 4 TS t ur de on n a M rati pa xt sé 03 PP BA 3/BB 3 Exemple on TS 4 with RPPDO. BB 4. MSE 4183 M Sectorisations not possible for: • Main Dipoles • Main Quadrupoles • Sextupoles • Octupoles Se 0 G 3 103 0 PP Se TS xt 2 an t 2 TT 2 0 TS 3 Sextant 3 (Manage by EN-ACE) Machine OPEN with NO access control 00 3 Sectorisation for IST: Exemple on TS 6 with RPPDB. BA 6. MSE 6183 M Open questions: q Safety conditions? q Access control? q Restriction in powering area q Time for balisage? q Green light for power tests (I≠ 0 A)? q Active lockouts? Verification : ü Location of magnet(s) ü Balisage ü Sectorisation possible on sextant or transfer line ü Lockouts dedicated for ARC- / LSS / ARC+ (possible for MACAOs) ü Identification of doors for sectorisation 8

Identification des portes d'entrées et de sortie de zones, du complexe SPS et de

Identification des portes d'entrées et de sortie de zones, du complexe SPS et de ses lignes de transferts 9

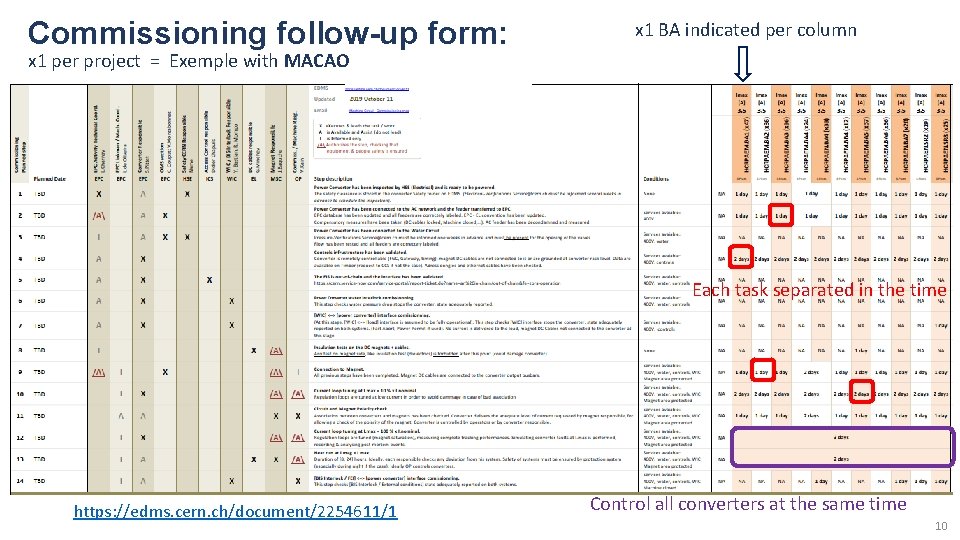

Commissioning follow-up form: x 1 BA indicated per column x 1 per project =

Commissioning follow-up form: x 1 BA indicated per column x 1 per project = Exemple with MACAO Each task separated in the time https: //edms. cern. ch/document/2254611/1 Control all converters at the same time 10

Summary for MACAOs: Dates flexible per BA (not at same time) (x 10 buildings)

Summary for MACAOs: Dates flexible per BA (not at same time) (x 10 buildings) LS 2 Lockouts move to DC cables d o i r e p T S I t r a d n a t s p e e K DSO tests 18 to 21 th Sept. 2020 10 th august 2020 16 th November 2020 IST HWC (6 weeks) (8 weeks) Imag = 0 Imag = 10%. Inom Imag = 100%. Inom 4 days per BA 5 days for all BAs EPC pre-test HSE agreement … Connection to magnet Current loop at 100% AC connected & EPC hand-over …. Current loop at 10% Heat run at 100% Water connected …. Polarity tests BIS / FEI comissionning Control validated EIS out of chain & validated Water intlk test WIC converter comissionning Insulation test on DC cables 11

Thanks for your attention…. Any questions ? ? ? 12

Thanks for your attention…. Any questions ? ? ? 12

13

13

EPC equipment (low/medium power) in SPS complex: NEW NEW New MACAO Converter New AUX-PS

EPC equipment (low/medium power) in SPS complex: NEW NEW New MACAO Converter New AUX-PS converter BA 1 47 2 (Sirius) BA 2 38 BA 3 36 Already in operation Tasks on 18 k. V transformer AUX-PS BB 3 uri t d s e T Other EPC consolidation projects during LS 2: 36 2 iod r e p T S I ng ** Mains SMD/SMQ not considered ** 55 H g n i dur t s e T 13 1 28 1 22 BA 4 57 BB 4 12 BA 5 38 BA 6 36 BA 7 28 SR 2 19 18 (type 7) +3 (Comet) 29 -(18+3) SR 8 25 18 (type 7) +2 (RB 6) 22 -(18+2) 2 (N 06 A+N 07) WC ü EIS upgrade ü SPS Mains upgrade (Quad output filter + CIS + control) ü Impact of 18 k. V grid consolidation Recomissioning of x 22 departures 12 2 36 20 New Equipment must be considering during IST period (or before) 336 Macaos + 45 Aux. PS + 2 new 18 k. V cast resin transformers Re-start tests post LS 2 232 converters 14

EPC equipment (high power) in SPS complex: Main power converter RPPCA. BA 2. MPNH

EPC equipment (high power) in SPS complex: Main power converter RPPCA. BA 2. MPNH 2173 RPPBG. BA 2. MSE 2183 M Test during IST RPPCK. BA 2. MBE 2103 M (x 23) RPPDR. BA 4. RBIH. 400309 RPPDT. BA 4. RBI. 81607 and RPPDU. BA 4. RBI. 81607 (for TI 8) RPPDT. BA 4. RBI. 81607 and RPPDU. BA 4. RBI. 81607 (for Awake) RPPDP. BA 4. RBIV. 81107 RPPDO. BB 4. MSE 4183 M RPPCL. BB 4. RBI. 410010 RPSLK. BA 6. RBIH. 660004 RPPGS. BA 6. RBI. 610405 RPPDB. BA 6. MSE 6183 M RPPCA. BA 6. MPNH 6173 (not test) RPPCI. BA 6. RBIH. 660107 N 04. BB 3. SPARE 1 RPPDJ. BB 3. LOF C RPPDJ. BB 3. LSFC W RPPCB. BB 3. LSDA H g n RPPCB. BB 3. LSFB ri ) u RPPDJ. BB 3. LSDB t d (x 25 s RPPDJ. BB 3. LSFA Te RPPDJ. BB 3. LOD SMD 1 to 14 SQF , SQD, SQS RPPDP. BA 7. RBIV. 20637 Test during IST RPPCP. BA 7. RBIH. 20150 1 day test per converter (except Mains) Magnet per circuit EIS Period 1 4 30 4 236 73 12 6 8 8 9 5 1 4 17 2 X X X X X IST IST IST IST HWC HWC HWC IST Sector to condamned Type of balisage Sextant 2 Local balisage TT 20 Area TT 40 Local balisage TI 8 Area SPS+LHC TT 41 TBC? TI 8 Area SPS+LHC Sextant 4 Local balisage TT 40 Area TT 60, BA 7 Area TBC TT 60 Area Sextant 6 Local balisage TT 60 Area SPS RING DISTRIBUTED SPS RING DISTRIBUTED SPS RING DISTRIBUTED TI 2 Area SPS+LHC TT 60 Local balisage 15

Location of loads powered by EPC equipment (high power) in SPS complex: ** for

Location of loads powered by EPC equipment (high power) in SPS complex: ** for sectorisation ** TT 2 0 TS 3 Sextant 3 G 4 PP BA 4/BB 4 PPG 5003 3 BA 5 PP G 1 TS 6 Sextant 6 3 0 TT 1 TT 60 PPG 61031 00 BA 6 TI 2 G 6 PP 8 82 02 G 1 00 PP 1 1 TS ant xt Se BA 1 1 TI 8 SPS PPG 2003 TT 4 Se TS 5 xt an t 5 103 G 2 3 PP 4 4 TS t ur de on n a M rati pa xt sé 00 BA 2 No possible sectorisations for: • Main Dipoles • Main Quadrupoles • Sextupoles • Octupoles Se G 3 Se TS xt 2 an t 2 0 PP BA 3/BB 3 00 3 Exemple on TS 4 with RPPDO. BB 4. MSE 4183 M Exemple on TS 6 with RPPDB. BA 6. MSE 6183 M Verification : * Each converter (high power). * Number of magnets. * Location of first and last magnet in series. * Sectorisation possible on sextant or transfer line. * Lockouts dedicated for ARC- / LSS / ARC+ (if possible for MACAOs) * Identification of doors for sectorisation * Remove partial lockouts. * Particular case (MBE. 2103 M) 16

First draft - EPC planning for IST: 15 participants n o i s r

First draft - EPC planning for IST: 15 participants n o i s r e v t s 1 • • 45 Aux. PS converters (new converters or new electronic) 336 correctors (MACAOs) 3 converters with new cast resin transformers (18 k. V) Converters impacted by EIS upgrade (except Mains/oct/sext) 17

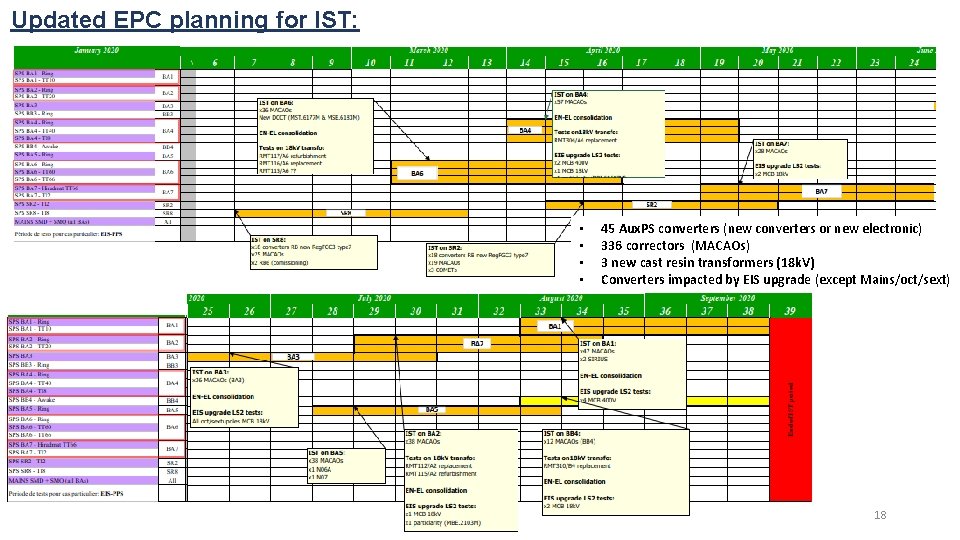

Updated EPC planning for IST: • • 45 Aux. PS converters (new converters or

Updated EPC planning for IST: • • 45 Aux. PS converters (new converters or new electronic) 336 correctors (MACAOs) 3 new cast resin transformers (18 k. V) Converters impacted by EIS upgrade (except Mains/oct/sext) 18

First draft - EPC planning for Hardware commissioning: n o i s r e

First draft - EPC planning for Hardware commissioning: n o i s r e v t s OP tests on SMD/SMQ (3 weeks) 1 • 232 Aux. PS converters Participant for test: 2 x 2 teams (composed from 26 persons) • 336 correctors (MACAO) Duration: 9 weeks • 23 High power converters (MBE+MSE…) • 14 SMD + 3 SMQ + 3 Octupoles + 7 Sextupoles WORK = 180 homme-jours NB: no details in this planning for SMD/ SMQ tests during HWC (in preparation) But minimum of 6 weeks required for EPC tests!! 19

Updated EPC planning for Hardware commissioning: 2 x 2 teams (composed from 26 persons)

Updated EPC planning for Hardware commissioning: 2 x 2 teams (composed from 26 persons) Duration: 8 weeks • Annual restart : 232 Aux. PS converters • 23 High power converters (MBE+MSE…) • 14 SMD + 3 SMQ + 3 Octupoles + 7 Sextupoles NB: no details for SMD/ SMQ tests during HWC (dedicated planning) But minimum of 6 weeks required for EPC tests!! WORK = 160 homme-jours 20

Historical from hardware commissioning after LS 1 (SPS complex): BA 1 BA 2 BA

Historical from hardware commissioning after LS 1 (SPS complex): BA 1 BA 2 BA 3 BB 3 BA 4 BA 5 BA 6 BA 7 SR 2 SR 8 Nb of days Nb of persons 4. 5 7 0. 5 2 2. 5 4 4. 5 9 3 6 4. 5 7 1 6 4 6 3 4 Descriptif x 1 new convertisseur CVS not tested = MSE + MST + MBE all CVS + MSE in BB 4 x 3 new converters all CVS Comparison Hardware commissioning Team per building Homme/jours Total of 32, 5 days = 209 HJ BUT during LS 1: • No heavy EPC consolidation project • No works on 18 k. V electrical grid • AWAKE not started (no test in BB 4) • More staff available for tests LS 1 LS 2 6, 5 weeks 9 weeks 6, 5 persons 4 persons 210 180 None negligible differences: +15% of time work More EPC consolidation projects Number of projects involve a great dispatching (in term of staff) Impacts of SPS 18 k. V network consolidation on EPC to considerer 21

Needs for EPC group: Ø Declare and announce prerequisites and service availabilities in the

Needs for EPC group: Ø Declare and announce prerequisites and service availabilities in the SPS planning * General service (AC, light, water, wifi) * HV Circuits locked-out by the network separation procedures * Hand-over to TE/EPC (18 k. V departures) * Controls, Ethernet, Interlock system, WIC, BIS * etc… Ø Identify and plan in accordance with ACE, all preliminary tests * DSOs * EIS-PPS * Control tests on EPC equipment (no power) Ø Depending buildings, ADVANCE start dates for IST periods (6 weeks per building) BA 1: BA 2: BA 3: BA 4: BA 5: BA 6: BA 7: SR 2: SR 8: IMPOSSIBLE to advance mid-July 2020 mid-June 2020 from April 2020 July 2020 mid-march 2020 from May 2020 from April 2020 from February 2020 to be analysed Shadow with RF conditioning more flexible Shadow with ABT ISTs more flexible BB 3: BB 4: idem BA 3 mid-February 2020 (TT 40) 2 nd week of April 2020 Important for EPC Ø As much as possible, ANTICIPATE tests of EPC consolidation projects (without power before the IST period) !! Ø Hardware commissioning FOCUS on: * Power tests on SMD/SMQ, Sextupoles and Octupole converters * Restart tests on equipment in operation before LS 2 Ø IST period FOCUS on: * Tests of converters involved in consolidation projects 22

Commissioning follow up form (for EPC equipment): X e. Xecutes & leads the task

Commissioning follow up form (for EPC equipment): X e. Xecutes & leads the task / work A is Available and Assist (do not lead) I is Informed only /A Authorizes the step, checking that equipment & people safety is ensured Procedure already use for the converter commissioning on Booster’s consolidation 23

Safety all along LS 2, IST and HWC: Location of Electrical risks ü All

Safety all along LS 2, IST and HWC: Location of Electrical risks ü All longer, time/period test requests during the long shutdown must be announced for agreement ü Organisation/safety to be discussed in LS 2 C with compensatory measures Authorization from HSE / ACE exemple: Lockout move to DC cables LS 2 only on surface ü Active lockouts (converter responsible) can be moved to DC part (if necessary and possible), and clearly identified (even for SMD/SMQ) ü During LS 2 period, even none powering tests (on single converter), always request green light of ACE ü Before starting any powering tests: • Green light from ACE (during IST) • Green light from OP (during HWC) • Identification of test in progress on all building doors (where is located the equipment) • Local balisage in case of particular circuit test, during IST • Area closed (identified) and controlled by ccc, during HWC IST & HWC on surface and underground ü During IST and HWC periods, for powering tests on converters, request green light from ACE / OP 24
