ELENA Installation followup 25062015 Worksite followup Scrapers update
- Slides: 11
ELENA Installation follow-up 25/06/2015 • Worksite follow-up • Scrapers update
Worksite follow-up • EN-EL-BT works: • Clean Up of the rack area started • Cable trays installation in progress (Work due to finish by the end of next week) • Integration of the cable trays in the new platform to be clarified
Worksite follow-up • Installation of concrete block around the rack platform: • Access to the rack platform to be done
Worksite follow-up • General cleaning of the rack platform to be done before 13 th of July
Worksite follow-up • Survey : – • Survey completed the ground marking on Thursday • LNR, LNI, LNS, LNE 00 are marked • LNE 00 line is marked Remaining work : – – Measure of height to be done. Upgrade of the survey network once the surrounding shielding will be installed
Worksite follow-up • Cleaning of Gbar area: Moving of the big ASACUSA equipment planned today

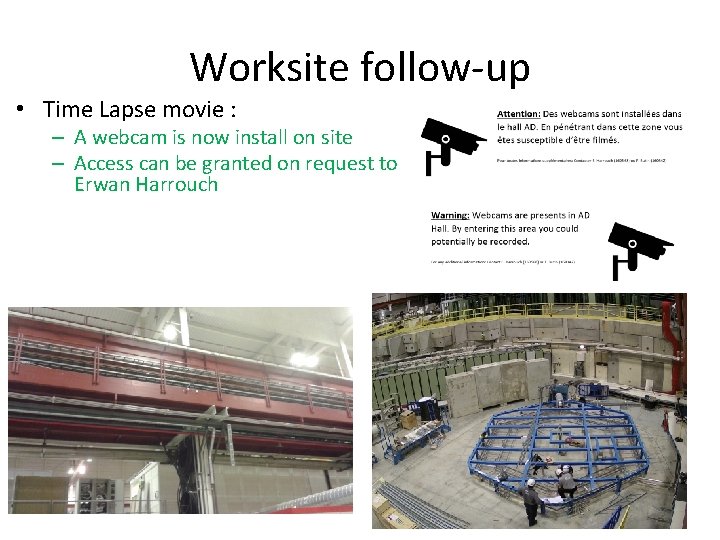

Worksite follow-up • Time Lapse movie : – A webcam is now install on site – Access can be granted on request to Erwan Harrouch
General information : - Worksite follow-up The crane cannot be reinstalled as it is : Reduce the maximum load or the length of the crane. The path to BASE has been cleared. It should remain like this in the future Warning : The PR 191 crane will be unavailable from Friday 26 th to Wednesday 1 st of July
Reminder Get in contact with Erwan Harrouch or Francois Butin before installing anything
Updated schedule for the coming weeks
Worksite follow-up • Activities for the week 27: – Cleaning of GBAR area – E. Harrouch (EN-MEF) – Path to the rack platform- F. Bais (EN-MEF)? – Drilling for the mechanical supports – Antti Kolehmainen (EN-MEF) – Installation of the ion switch and source support – Antti Kolehmainen (EN-MEF) – Cable trays installation– R. Necca (EN-EL)
