East Hall under construction 1962 East Area Renovation

  • Slides: 16
Download presentation
East Hall under construction - 1962 East Area Renovation meeting #7 Schedule Quentin Bouirek

East Hall under construction - 1962 East Area Renovation meeting #7 Schedule Quentin Bouirek / EN-EA, 17 -03 -2017 East Area Renovation

Contents • LS 2 schedule • PS closing constraint EN-EL resources constraint • TE-MSC

Contents • LS 2 schedule • PS closing constraint EN-EL resources constraint • TE-MSC phasing • Linear schedule • March 17 th, 2017 2

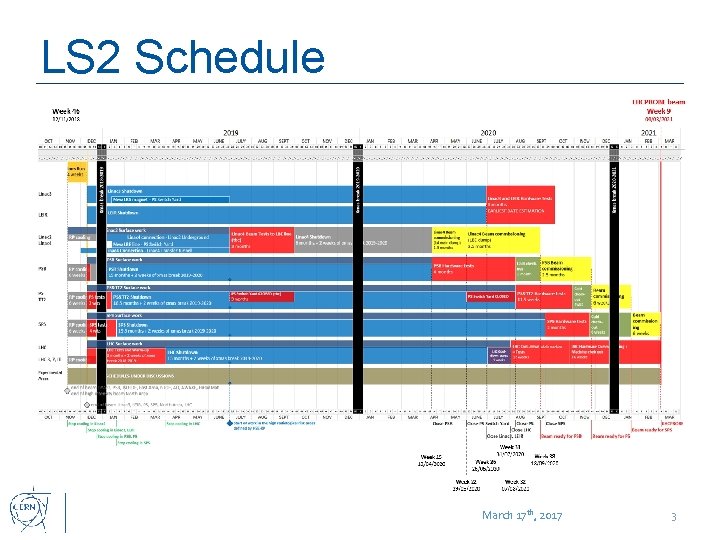

LS 2 Schedule March 17 th, 2017 3

LS 2 Schedule March 17 th, 2017 3

Hardware test Beam Comm’ PSB 04/2020 09/2020 PS 08/2020 12/2020 SPS 09/2020 01/2021 LHC

Hardware test Beam Comm’ PSB 04/2020 09/2020 PS 08/2020 12/2020 SPS 09/2020 01/2021 LHC 10/2020 03/2021 March 17 th, 2017 4

F 61 -PS activities • F 61 line installation • • • TB in

F 61 -PS activities • F 61 line installation • • • TB in the PS area Cables installation Magnets installation Alignment Few works to be done before weeks 32 March 17 th, 2017 5

EN-EL-ENP 65 switchboard in 157 and 251 + transformers All the switchboards will be

EN-EL-ENP 65 switchboard in 157 and 251 + transformers All the switchboards will be reinstalled on the ground floor Possible anticipation of these activities during 2018 to release LS 2 workload • • Ø Beginning of identification works : • Defining what is the extent of the project • Analyse the load requirements Ø Aim is to have a preliminary document (CDR) assessing resources, cost and planning • Ø Waiting arbitration of PLAN V 2 for further information March 17 th, 2017 6

EN-EL-FC constraint • Cabling activities from 06/2020 in 251 and 157 • • Containment

EN-EL-FC constraint • Cabling activities from 06/2020 in 251 and 157 • • Containment installation possible/mandatory before June in 251 • • • In the same time than TE-EPC installation (no room available to do it after converters installation) To be done before converters installation Possible modification of the metallic structure TE-EPC wishes to install converters from beginning 2020 Ø Solution have to be found to allow coactivity March 17 th, 2017 7

EN-EL-FC constraint • No availabilities in 2019 • • Shielding installation issue • •

EN-EL-FC constraint • No availabilities in 2019 • • Shielding installation issue • • Some DC cables must be installed before shielding installation Possibility to anticipate fibres and control installation • • • Ø De-cabling to be done by EN-EA For cables going to PS “center-ring” or CCC File will be circulating soon to collect the first needs Aim to reduce LS 2 EL workload Real need of pre-study before 2018 March 17 th, 2017 8

Cabling constraints • Cables pass from gallery to 157 can be under shielding blocs

Cabling constraints • Cables pass from gallery to 157 can be under shielding blocs or magnets • Shielding is normally raised above cables during installation • Some cables could be impossible to install after shielding or magnets installation • Situation likely to happen in the primary area : early magnets installation and long shielding/HVAC to be done March 17 th, 2017 9

TE-MSC • Magnets installation • • Hardware test • • • F 61 –

TE-MSC • Magnets installation • • Hardware test • • • F 61 – Mid 2019 Primary area – End 2019 Experimental areas – 2020 Need of water + DC + Control (interlock) Ideally before the accelerators hardware test Need of survey inputs March 17 th, 2017 10

EA Renovation baseline March 17 th, 2017 11

EA Renovation baseline March 17 th, 2017 11

EA Renovation linear schedule Timeline Different working areas March 17 th, 2017 12

EA Renovation linear schedule Timeline Different working areas March 17 th, 2017 12

EA Renovation linear schedule March 17 th, 2017 13

EA Renovation linear schedule March 17 th, 2017 13

EA Renovation linear schedule March 17 th, 2017 14

EA Renovation linear schedule March 17 th, 2017 14

Summary • Constraint EPC/EL • • • Constraint MSC/EL • • Impossible to install

Summary • Constraint EPC/EL • • • Constraint MSC/EL • • Impossible to install converters before DC cables from 06/2020, EPC wishes to begin from 01/2020 East Area hardware test will be in the same time than SPS and LHC hardware test Constraint EA/EL • Shielding and magnets installation can lead to difficulties in the DC cabling campaign March 17 th, 2017 15

Thanks for your attention! East Area Renovation March 17 th, 2017 16

Thanks for your attention! East Area Renovation March 17 th, 2017 16
