EASA FTL 2016 A Generic Interpretation Understanding EASA FTL 2016 Flight and Duty Time

EASA FTL 2016 A Generic Interpretation Understanding EASA FTL 2016 Flight and Duty Time Limitations and Rest Requirements. Version 1. 3 Copyright © 2012 -2014 Understanding EASA FTL 2016 – A Generic Interpretation All rights reserved.

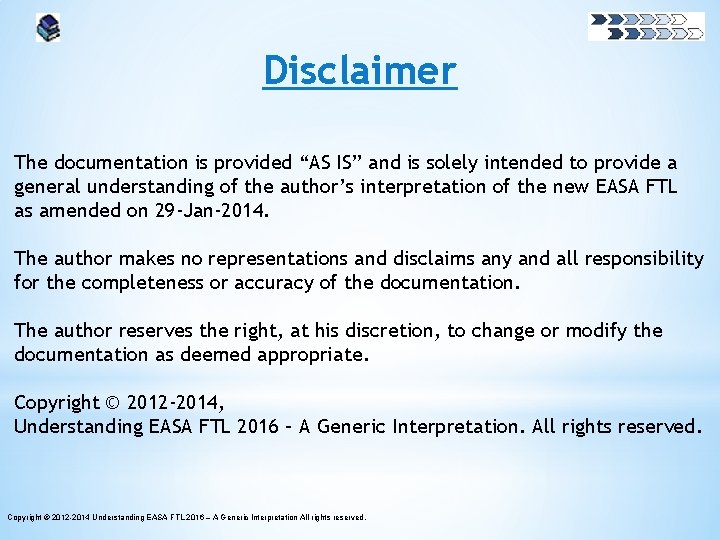

Disclaimer The documentation is provided “AS IS” and is solely intended to provide a

Disclaimer The documentation is provided “AS IS” and is solely intended to provide a general understanding of the author’s interpretation of the new EASA FTL as amended on 29 -Jan-2014. The author makes no representations and disclaims any and all responsibility for the completeness or accuracy of the documentation. The author reserves the right, at his discretion, to change or modify the documentation as deemed appropriate. Copyright © 2012 -2014, Understanding EASA FTL 2016 – A Generic Interpretation. All rights reserved. Copyright © 2012 -2014 Understanding EASA FTL 2016 – A Generic Interpretation All rights reserved.

Module 3: Application of Regulations: Standard Crew Complement Copyright © 2012 -2014 Understanding EASA

Module 3: Application of Regulations: Standard Crew Complement Copyright © 2012 -2014 Understanding EASA FTL 2016 – A Generic Interpretation All rights reserved.

ORO. FTL. 205(b) Scheduled FDP Limits: Standard Crew Compliment: Maximum daily FDP for an

ORO. FTL. 205(b) Scheduled FDP Limits: Standard Crew Compliment: Maximum daily FDP for an Acclimatised crew member shall use the following table: • Use the start time of the FDP (Adjusted to Reference Time Zone) and apply the number of sectors within the FDP. • Should be done for each sector (Leg). Copyright © 2012 -2014 Understanding EASA FTL 2016 – A Generic Interpretation All rights reserved.

ORO. FTL. 205(b) Scheduled FDP Limits: Maximum Scheduled FDP in RED. Copyright © 2012

ORO. FTL. 205(b) Scheduled FDP Limits: Maximum Scheduled FDP in RED. Copyright © 2012 -2014 Understanding EASA FTL 2016 – A Generic Interpretation All rights reserved.

ORO. FTL. 205(b) Scheduled FDP Limits: Maximum daily FDP for a crew member in

ORO. FTL. 205(b) Scheduled FDP Limits: Maximum daily FDP for a crew member in an Unknown State of Acclimatisation shall use the following table: • • • Apply the number of sectors within the FDP. The maximum number of sectors is 8. Should be done for each sector (Leg). Example: Maximum Scheduled FDP in RED. Copyright © 2012 -2014 Understanding EASA FTL 2016 – A Generic Interpretation All rights reserved.

ORO. FTL. 205(b) Scheduled FDP Limits: Maximum daily FDP for a crew member in

ORO. FTL. 205(b) Scheduled FDP Limits: Maximum daily FDP for a crew member in an Unknown State of Acclimatisation under FRM may use the following table: • • • Apply the number of sectors within the FDP. The maximum number of sectors is 8. Should be done for each sector (Leg). Authors Note: It is important to calculate the scheduled FDP limitation with each leg, as this determines when a leg is operating under extended FDP limits. Copyright © 2012 -2014 Understanding EASA FTL 2016 – A Generic Interpretation All rights reserved.

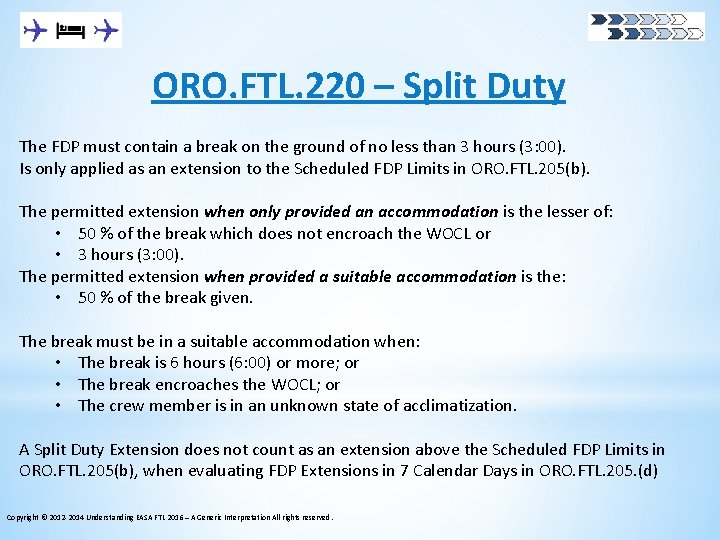

ORO. FTL. 220 – Split Duty The FDP must contain a break on the

ORO. FTL. 220 – Split Duty The FDP must contain a break on the ground of no less than 3 hours (3: 00). Is only applied as an extension to the Scheduled FDP Limits in ORO. FTL. 205(b). The permitted extension when only provided an accommodation is the lesser of: • 50 % of the break which does not encroach the WOCL or • 3 hours (3: 00). The permitted extension when provided a suitable accommodation is the: • 50 % of the break given. The break must be in a suitable accommodation when: • The break is 6 hours (6: 00) or more; or • The break encroaches the WOCL; or • The crew member is in an unknown state of acclimatization. A Split Duty Extension does not count as an extension above the Scheduled FDP Limits in ORO. FTL. 205(b), when evaluating FDP Extensions in 7 Calendar Days in ORO. FTL. 205. (d) Copyright © 2012 -2014 Understanding EASA FTL 2016 – A Generic Interpretation All rights reserved.

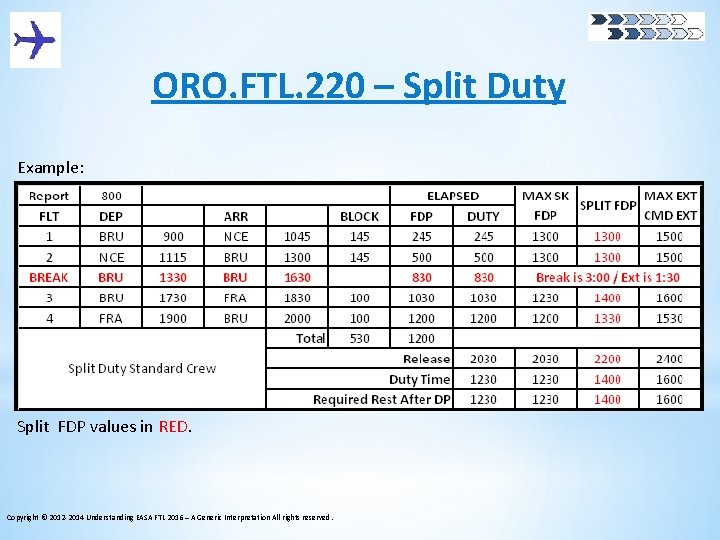

ORO. FTL. 220 – Split Duty Example: Split FDP values in RED. Copyright ©

ORO. FTL. 220 – Split Duty Example: Split FDP values in RED. Copyright © 2012 -2014 Understanding EASA FTL 2016 – A Generic Interpretation All rights reserved.

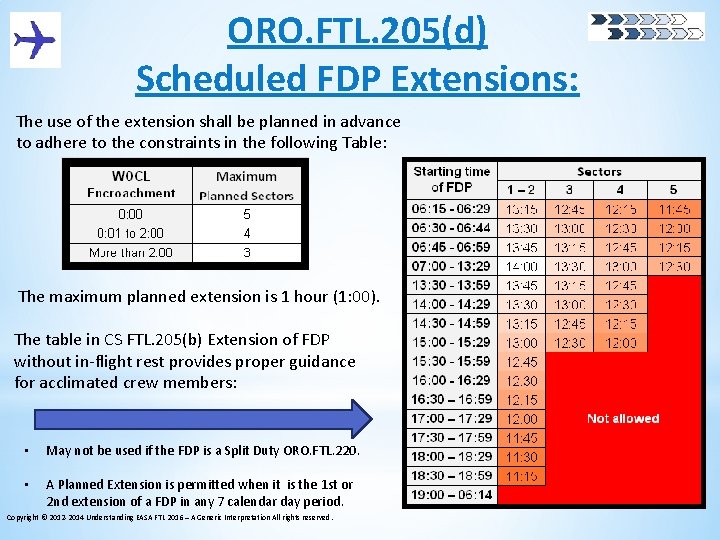

ORO. FTL. 205(d) Scheduled FDP Extensions: The use of the extension shall be planned

ORO. FTL. 205(d) Scheduled FDP Extensions: The use of the extension shall be planned in advance to adhere to the constraints in the following Table: The maximum planned extension is 1 hour (1: 00). The table in CS FTL. 205(b) Extension of FDP without in-flight rest provides proper guidance for acclimated crew members: • May not be used if the FDP is a Split Duty ORO. FTL. 220. • A Planned Extension is permitted when it is the 1 st or 2 nd extension of a FDP in any 7 calendar day period. Copyright © 2012 -2014 Understanding EASA FTL 2016 – A Generic Interpretation All rights reserved.

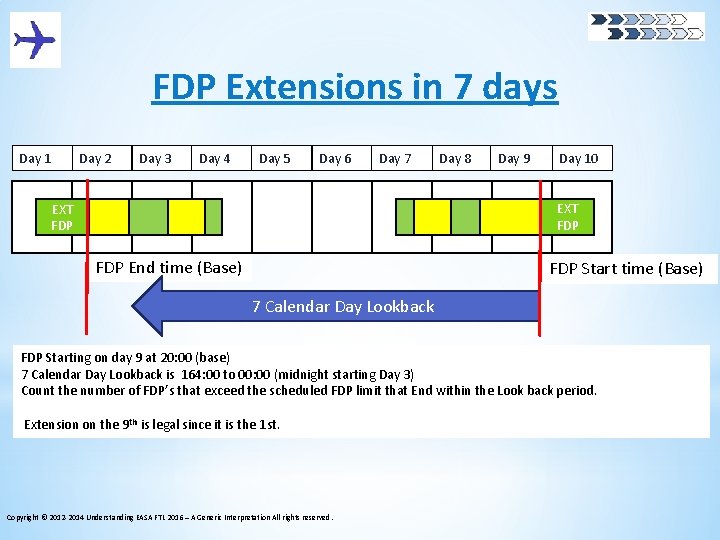

FDP Extensions in 7 days Day 1 Day 2 Day 3 Day 4 Day

FDP Extensions in 7 days Day 1 Day 2 Day 3 Day 4 Day 5 Day 6 Day 7 EXT FDP Day 8 Day 9 Day 10 EXT FDP End time (Base) FDP Start time (Base) 7 Calendar Day Lookback FDP Starting on day 9 at 20: 00 (base) 7 Calendar Day Lookback is 164: 00 to 00: 00 (midnight starting Day 3) Count the number of FDP’s that exceed the scheduled FDP limit that End within the Look back period. Extension on the 9 th is legal since it is the 2 nd. Copyright © 2012 -2014 Understanding EASA FTL 2016 – A Generic Interpretation All rights reserved.

FDP Extensions in 7 days Day 1 Day 2 Day 3 Day 4 Day

FDP Extensions in 7 days Day 1 Day 2 Day 3 Day 4 Day 5 Day 6 Day 7 Day 8 Day 9 Day 10 EXT FDP FDP End time (Base) FDP Start time (Base) 7 Calendar Day Lookback FDP Starting on day 9 at 20: 00 (base) 7 Calendar Day Lookback is 164: 00 to 00: 00 (midnight starting Day 3) Count the number of FDP’s that exceed the scheduled FDP limit that End within the Look back period. Extension on the 9 th is legal since it is the 1 st. Copyright © 2012 -2014 Understanding EASA FTL 2016 – A Generic Interpretation All rights reserved.

FDP Extensions in 7 days Day 1 Day 2 Day 3 Day 4 Day

FDP Extensions in 7 days Day 1 Day 2 Day 3 Day 4 Day 5 Day 6 EXT FDP Day 7 EXT FDP End time (Base) Day 8 Day 9 Day 10 EXT FDP Start time (Base) 7 Calendar Day Lookback FDP Starting on day 9 at 20: 00 (base) 7 Calendar Day Lookback is 164: 00 to 00: 00 (midnight starting Day 3) Count the number of FDP’s that exceed the scheduled FDP limit that End within the Look back period. Extension on the 9 th is illegal because it is the 3 rd in 7 calendar days Copyright © 2012 -2014 Understanding EASA FTL 2016 – A Generic Interpretation All rights reserved.

FDP Extensions in 7 days When a 2 nd Planned extension in 7 calendar

FDP Extensions in 7 days When a 2 nd Planned extension in 7 calendar days additional rest must be given: • the minimum pre-flight and post-flight rest periods shall be increased by 2 hours; or • the post-flight rest period shall be increased by 4 hours. ORO. FTL. 205(d) Scheduled FDP Extensions: In the case where 2 FDP extensions are planned for consecutive FDPs the additional rest must be applied to both FDPs Example: Maximum Planned FDP Extensions in RED. Copyright © 2012 -2014 Understanding EASA FTL 2016 – A Generic Interpretation All rights reserved.

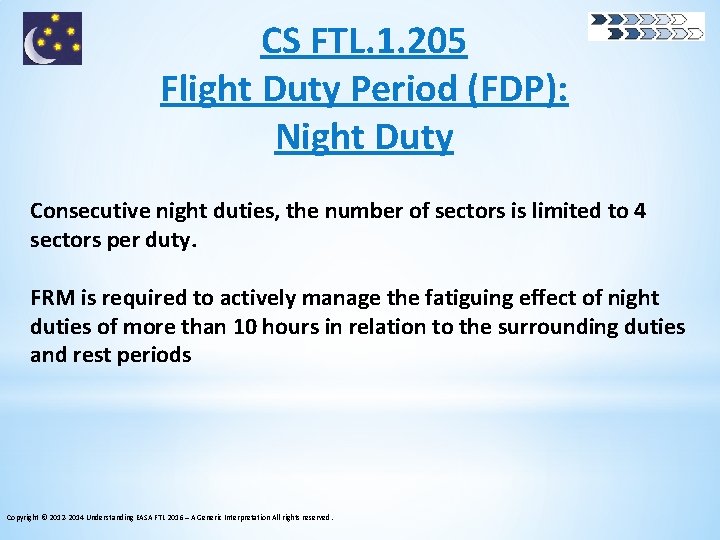

CS FTL. 1. 205 Flight Duty Period (FDP): Night Duty Consecutive night duties, the

CS FTL. 1. 205 Flight Duty Period (FDP): Night Duty Consecutive night duties, the number of sectors is limited to 4 sectors per duty. FRM is required to actively manage the fatiguing effect of night duties of more than 10 hours in relation to the surrounding duties and rest periods Copyright © 2012 -2014 Understanding EASA FTL 2016 – A Generic Interpretation All rights reserved.

EASA FTL 2016 A Generic Interpretation Understanding EASA FTL 2016 Flight and Duty Time

EASA FTL 2016 A Generic Interpretation Understanding EASA FTL 2016 Flight and Duty Time Limitations and Rest Requirements. Version 1. 2 Copyright © 2012 -2014 Understanding EASA FTL 2016 – A Generic Interpretation All rights reserved.
