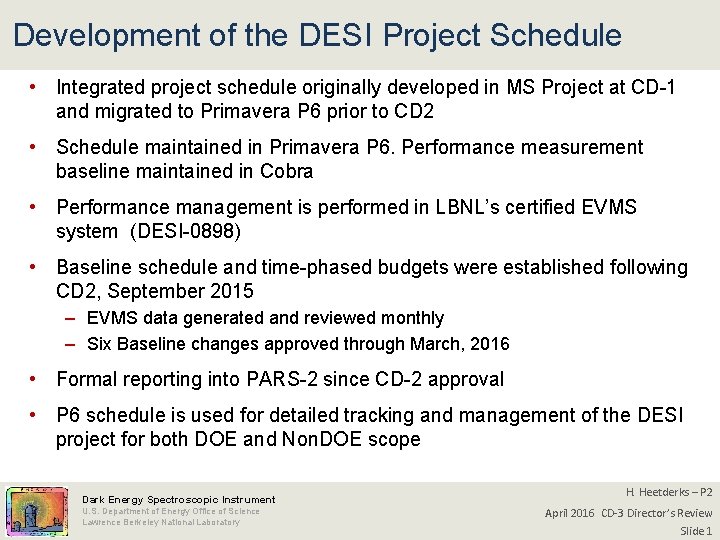

Development of the DESI Project Schedule • Integrated project schedule originally developed in MS

Development of the DESI Project Schedule • Integrated project schedule originally developed in MS Project at CD-1 and migrated to Primavera P 6 prior to CD 2 • Schedule maintained in Primavera P 6. Performance measurement baseline maintained in Cobra • Performance management is performed in LBNL’s certified EVMS system (DESI-0898) • Baseline schedule and time-phased budgets were established following CD 2, September 2015 – EVMS data generated and reviewed monthly – Six Baseline changes approved through March, 2016 • Formal reporting into PARS-2 since CD-2 approval • P 6 schedule is used for detailed tracking and management of the DESI project for both DOE and Non. DOE scope Dark Energy Spectroscopic Instrument U. S. Department of Energy Office of Science Lawrence Berkeley National Laboratory H. Heetderks – P 2 April 2016 CD-3 Director’s Review Slide 1

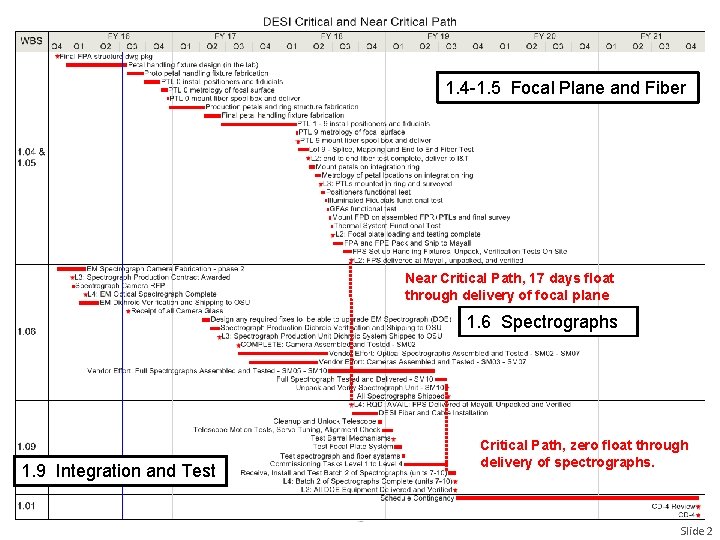

1. 4 -1. 5 Focal Plane and Fiber Near Critical Path, 17 days float

1. 4 -1. 5 Focal Plane and Fiber Near Critical Path, 17 days float through delivery of focal plane 1. 6 Spectrographs 1. 9 Integration and Test Critical Path, zero float through delivery of spectrographs. Slide 2

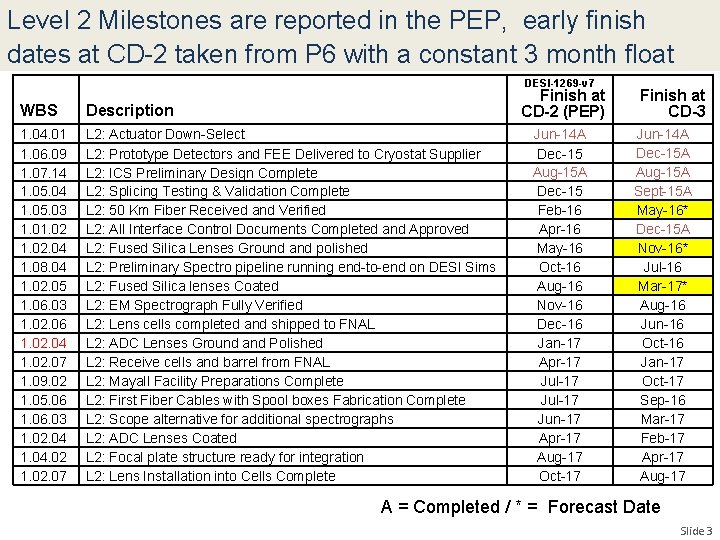

Level 2 Milestones are reported in the PEP, early finish dates at CD-2 taken

Level 2 Milestones are reported in the PEP, early finish dates at CD-2 taken from P 6 with a constant 3 month float DESI-1269 -v 7 Finish at CD-2 (PEP) WBS Description 1. 04. 01 1. 06. 09 1. 07. 14 1. 05. 03 1. 02. 04 1. 08. 04 1. 02. 05 1. 06. 03 1. 02. 06 1. 02. 04 1. 02. 07 1. 09. 02 1. 05. 06 1. 06. 03 1. 02. 04 1. 04. 02 1. 02. 07 L 2: Actuator Down-Select L 2: Prototype Detectors and FEE Delivered to Cryostat Supplier L 2: ICS Preliminary Design Complete L 2: Splicing Testing & Validation Complete L 2: 50 Km Fiber Received and Verified L 2: All Interface Control Documents Completed and Approved L 2: Fused Silica Lenses Ground and polished L 2: Preliminary Spectro pipeline running end-to-end on DESI Sims L 2: Fused Silica lenses Coated L 2: EM Spectrograph Fully Verified L 2: Lens cells completed and shipped to FNAL L 2: ADC Lenses Ground and Polished L 2: Receive cells and barrel from FNAL L 2: Mayall Facility Preparations Complete L 2: First Fiber Cables with Spool boxes Fabrication Complete L 2: Scope alternative for additional spectrographs L 2: ADC Lenses Coated L 2: Focal plate structure ready for integration L 2: Lens Installation into Cells Complete Jun-14 A Dec-15 Aug-15 A Dec-15 Feb-16 Apr-16 May-16 Oct-16 Aug-16 Nov-16 Dec-16 Jan-17 Apr-17 Jul-17 Jun-17 Apr-17 Aug-17 Oct-17 Finish at CD-3 Jun-14 A Dec-15 A Aug-15 A Sept-15 A May-16* Dec-15 A Nov-16* Jul-16 Mar-17* Aug-16 Jun-16 Oct-16 Jan-17 Oct-17 Sep-16 Mar-17 Feb-17 Apr-17 Aug-17 A = Completed / * = Forecast Date Slide 3

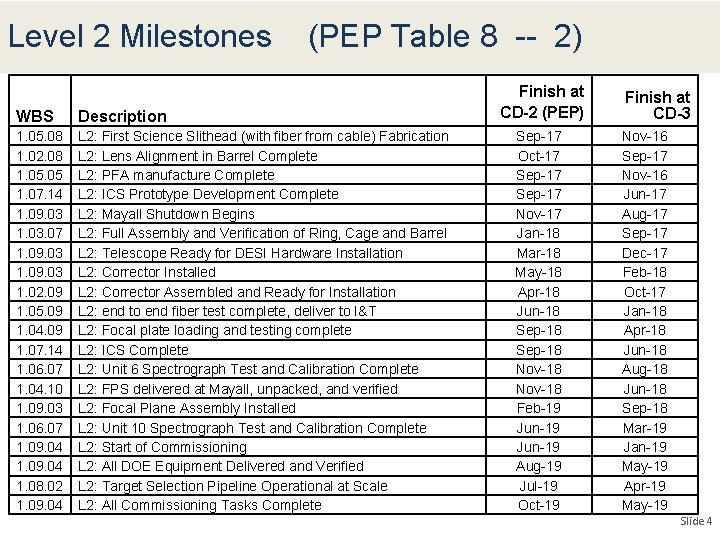

Level 2 Milestones (PEP Table 8 -- 2) WBS Description 1. 05. 08 1.

Level 2 Milestones (PEP Table 8 -- 2) WBS Description 1. 05. 08 1. 02. 08 1. 05 1. 07. 14 1. 09. 03 1. 03. 07 1. 09. 03 1. 02. 09 1. 05. 09 1. 04. 09 1. 07. 14 1. 06. 07 1. 04. 10 1. 09. 03 1. 06. 07 1. 09. 04 1. 08. 02 1. 09. 04 L 2: First Science Slithead (with fiber from cable) Fabrication L 2: Lens Alignment in Barrel Complete L 2: PFA manufacture Complete L 2: ICS Prototype Development Complete L 2: Mayall Shutdown Begins L 2: Full Assembly and Verification of Ring, Cage and Barrel L 2: Telescope Ready for DESI Hardware Installation L 2: Corrector Installed L 2: Corrector Assembled and Ready for Installation L 2: end to end fiber test complete, deliver to I&T L 2: Focal plate loading and testing complete L 2: ICS Complete L 2: Unit 6 Spectrograph Test and Calibration Complete L 2: FPS delivered at Mayall, unpacked, and verified L 2: Focal Plane Assembly Installed L 2: Unit 10 Spectrograph Test and Calibration Complete L 2: Start of Commissioning L 2: All DOE Equipment Delivered and Verified L 2: Target Selection Pipeline Operational at Scale L 2: All Commissioning Tasks Complete Finish at CD-2 (PEP) Sep-17 Oct-17 Sep-17 Nov-17 Jan-18 Mar-18 May-18 Apr-18 Jun-18 Sep-18 Nov-18 Feb-19 Jun-19 Aug-19 Jul-19 Oct-19 Finish at CD-3 Nov-16 Sep-17 Nov-16 Jun-17 Aug-17 Sep-17 Dec-17 Feb-18 Oct-17 Jan-18 Apr-18 Jun-18 Aug-18 Jun-18 Sep-18 Mar-19 Jan-19 May-19 Apr-19 May-19 Slide 4

DOE Project Cost Summary by Fund Type USD $K Dark Energy Spectroscopic Instrument U.

DOE Project Cost Summary by Fund Type USD $K Dark Energy Spectroscopic Instrument U. S. Department of Energy Office of Science Lawrence Berkeley National Laboratory H. Heetderks – P 2 April 2016 CD-3 Director’s Review Slide 5

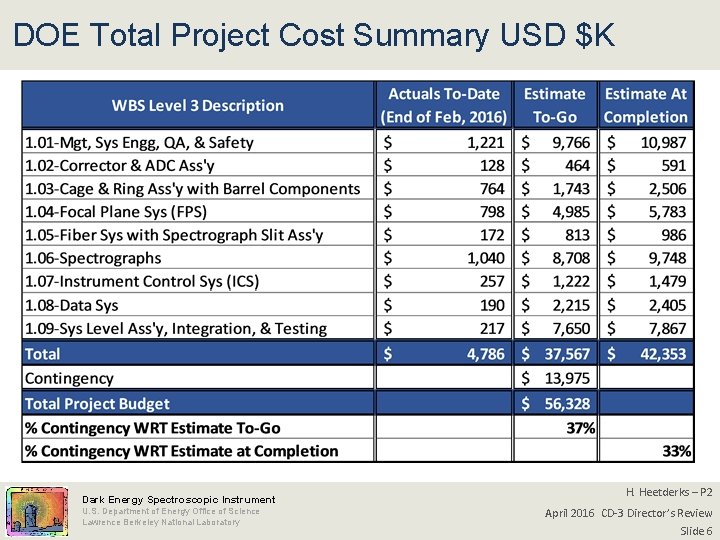

DOE Total Project Cost Summary USD $K Dark Energy Spectroscopic Instrument U. S. Department

DOE Total Project Cost Summary USD $K Dark Energy Spectroscopic Instrument U. S. Department of Energy Office of Science Lawrence Berkeley National Laboratory H. Heetderks – P 2 April 2016 CD-3 Director’s Review Slide 6

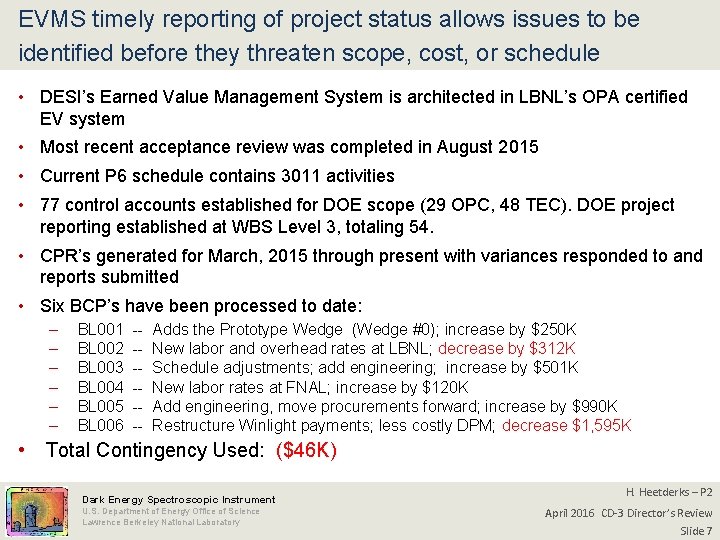

EVMS timely reporting of project status allows issues to be identified before they threaten

EVMS timely reporting of project status allows issues to be identified before they threaten scope, cost, or schedule • DESI’s Earned Value Management System is architected in LBNL’s OPA certified EV system • Most recent acceptance review was completed in August 2015 • Current P 6 schedule contains 3011 activities • 77 control accounts established for DOE scope (29 OPC, 48 TEC). DOE project reporting established at WBS Level 3, totaling 54. • CPR’s generated for March, 2015 through present with variances responded to and reports submitted • Six BCP’s have been processed to date: – – – • BL 001 BL 002 BL 003 BL 004 BL 005 BL 006 ------- Adds the Prototype Wedge (Wedge #0); increase by $250 K New labor and overhead rates at LBNL; decrease by $312 K Schedule adjustments; add engineering; increase by $501 K New labor rates at FNAL; increase by $120 K Add engineering, move procurements forward; increase by $990 K Restructure Winlight payments; less costly DPM; decrease $1, 595 K Total Contingency Used: ($46 K) Dark Energy Spectroscopic Instrument U. S. Department of Energy Office of Science Lawrence Berkeley National Laboratory H. Heetderks – P 2 April 2016 CD-3 Director’s Review Slide 7

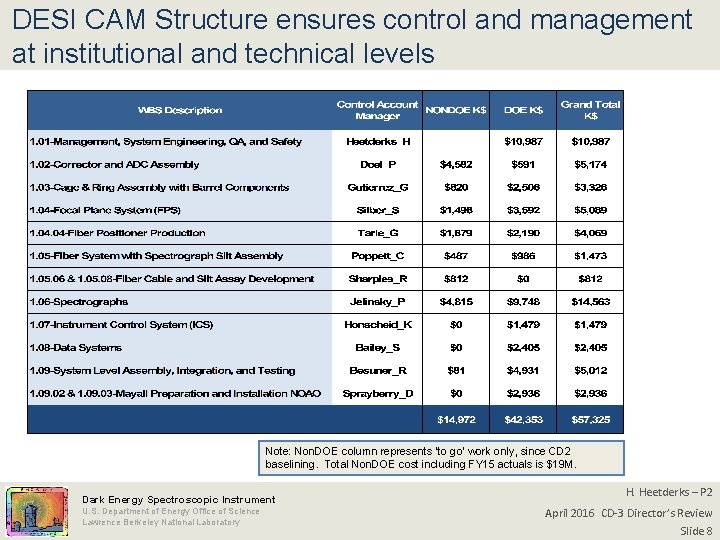

DESI CAM Structure ensures control and management at institutional and technical levels Note: Non.

DESI CAM Structure ensures control and management at institutional and technical levels Note: Non. DOE column represents ‘to go’ work only, since CD 2 baselining. Total Non. DOE cost including FY 15 actuals is $19 M. Dark Energy Spectroscopic Instrument U. S. Department of Energy Office of Science Lawrence Berkeley National Laboratory H. Heetderks – P 2 April 2016 CD-3 Director’s Review Slide 8

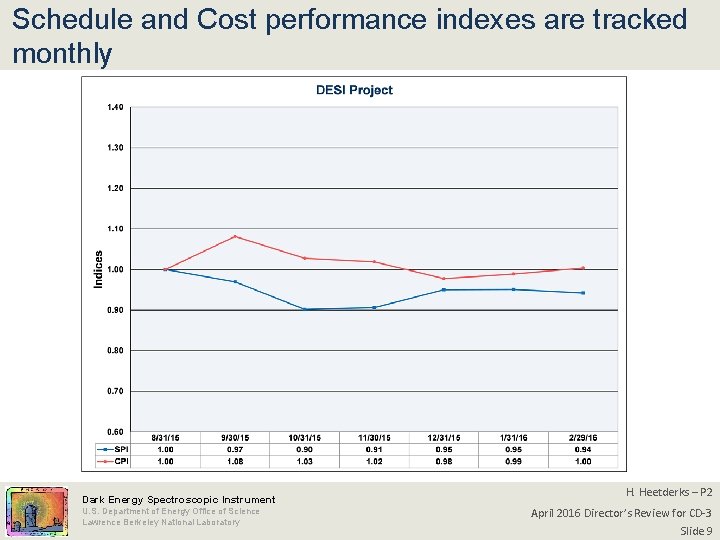

Schedule and Cost performance indexes are tracked monthly Dark Energy Spectroscopic Instrument U. S.

Schedule and Cost performance indexes are tracked monthly Dark Energy Spectroscopic Instrument U. S. Department of Energy Office of Science Lawrence Berkeley National Laboratory H. Heetderks – P 2 April 2016 Director’s Review for CD-3 Slide 9

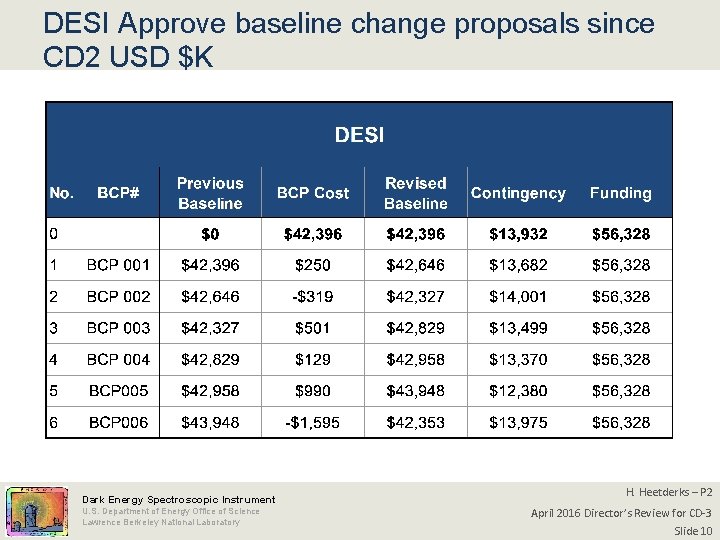

DESI Approve baseline change proposals since CD 2 USD $K Dark Energy Spectroscopic Instrument

DESI Approve baseline change proposals since CD 2 USD $K Dark Energy Spectroscopic Instrument U. S. Department of Energy Office of Science Lawrence Berkeley National Laboratory H. Heetderks – P 2 April 2016 Director’s Review for CD-3 Slide 10

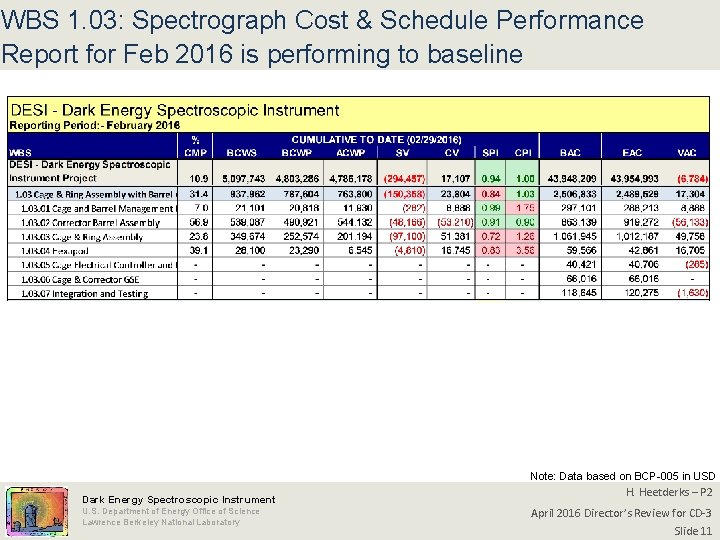

WBS 1. 03: Spectrograph Cost & Schedule Performance Report for Feb 2016 is performing

WBS 1. 03: Spectrograph Cost & Schedule Performance Report for Feb 2016 is performing to baseline Note: Data based on BCP-005 in USD Dark Energy Spectroscopic Instrument U. S. Department of Energy Office of Science Lawrence Berkeley National Laboratory H. Heetderks – P 2 April 2016 Director’s Review for CD-3 Slide 11
