Corporate Communication Center Pharmaceutical Quality System in regard

  • Slides: 14
Download presentation
Corporate Communication Center Pharmaceutical Quality System in regard to Good Engineering Practice Quality Director,

Corporate Communication Center Pharmaceutical Quality System in regard to Good Engineering Practice Quality Director, R-Pharm GC T. M. Vyazmina

Normative documents Ø Council of the Eurasian Economic Commission Resolution as of 03. 11.

Normative documents Ø Council of the Eurasian Economic Commission Resolution as of 03. 11. 2016 No. 77 “Concerning approval of the Good manufacturing practice of EAEU” Ø Order of the Ministry of Industry and Trade of the RF as of 14 June, 2013 No. 916 “On the Approval of Good Manufacturing Practice Rules” Ø ISPE Good Engineering Practice Guidelines Ø GOST R 52896 -2017. National standard of the Russian Federation. Manufacturing of medicinal products. Manufacturing systems and equipment for the production of medicines. General requirements. Ø ISPE Heating, Ventilation and Air Conditioning Guidelines Ø ISPE Process Gases Guidelines Ø ISPE “Pharmaceutical Engineering Guides for New and Renovated Facilities. Oral solid dosage form” Guidelines Ø ISPE “Pharmaceutical Engineering Guides for New and Renovated Facilities. Sterile Product Manufacturing Facilities” Guidelines Ø ISPE “Pharmaceutical Engineering Guides for New and Renovated Facilities. Water and Steam Systems” Guidelines Ø ISPE “Commissioning and Qualification of Pharmaceutical Water and Steam Systems” Guidelines

GEP definition GEP (Good Engineering Practice). 1. Established engineering procedures and standards used throughout

GEP definition GEP (Good Engineering Practice). 1. Established engineering procedures and standards used throughout the whole ‘lifecycle’ of the project for the purpose of getting cost-effective solutions. 2. System used by the qualified personnel for the implementation of individual solutions, and documentary support of the latter, which allows to track the events from customer’s demands to the final project (design). GEP documentation studies the goal, parties responsible, references, suppositions, calculation methods, conclusions and impact on other sides of the project (design). Requirements of Good Engineering Practice take in account industry-driven activities, performance specifications and safety requirements, as well as economic and normative requirements. GEP guarantees that technical (engineering) project satisfies the customer’s requirements, is cost-effective, meets the norms, regulatory requirements and has explicit documentary support. At the same time, philosophy, principles and approaches, engineering methods and standards related to technological equipment, engineering systems, clean rooms are applied throughout the whole lifecycle of the project.

Relation to other ISPE documents ISPE guidelines ISPE GAMP: Validation of process control systems

Relation to other ISPE documents ISPE guidelines ISPE GAMP: Validation of process control systems ISPE Guide: Commissioning and qualification Critical engineering systems ISPE Guide: HVAC systems Good engineering practice ISPE Guide: Maintenance ISPE Guide: Pharmaceutical engineering for new and renovated facilities

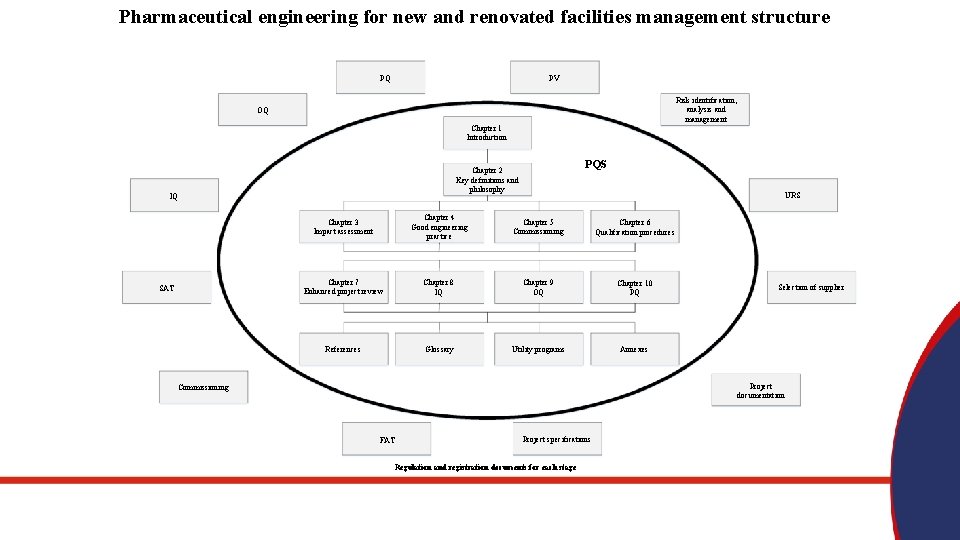

Pharmaceutical engineering for new and renovated facilities management structure PV PQ Risk identification, analysis

Pharmaceutical engineering for new and renovated facilities management structure PV PQ Risk identification, analysis and management OQ Chapter 1 Introduction IQ SAT PQS Chapter 2 Key definitions and philosophy URS Chapter 3 Impact assessment Chapter 4 Good engineering practice Chapter 5 Commissioning Chapter 6 Qualification procedures Chapter 7 Enhanced project review Chapter 8 IQ Chapter 9 OQ Chapter 10 PQ References Glossary Utility programs Annexes Selection of supplier Project documentation Commissioning FAT Project specifications Regulation and registration documents for each stage

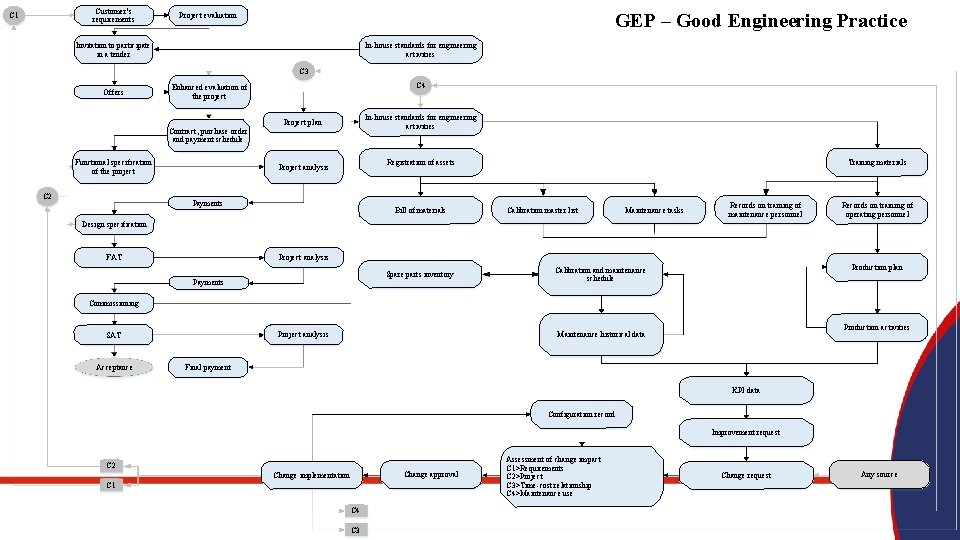

Customer’s requirements С 1 GEP – Good Engineering Practice Project evaluation In-house standards for

Customer’s requirements С 1 GEP – Good Engineering Practice Project evaluation In-house standards for engineering activities Invitation to participate in a tender С 3 Offers С 4 Enhanced evaluation of the project In-house standards for engineering activities Project plan Contract, purchase order and payment schedule Functional specification of the project С 2 Training materials Registration of assets Project analysis Payments Bill of materials Calibration master list Maintenance tasks Records on training of maintenance personnel Records on training of operating personnel Design specification Project analysis FAT Spare parts inventory Payments Production plan Calibration and maintenance schedule Commissioning Acceptance Production activities Maintenance historical data Project analysis SAT Final payment KPI data Configuration record Improvement request С 2 Change approval Change implementation С 1 С 4 С 3 Assessment of change impact С 1>Requirements С 2>Project С 3>Time-cost relationship С 4>Maintenance use Change request Any source

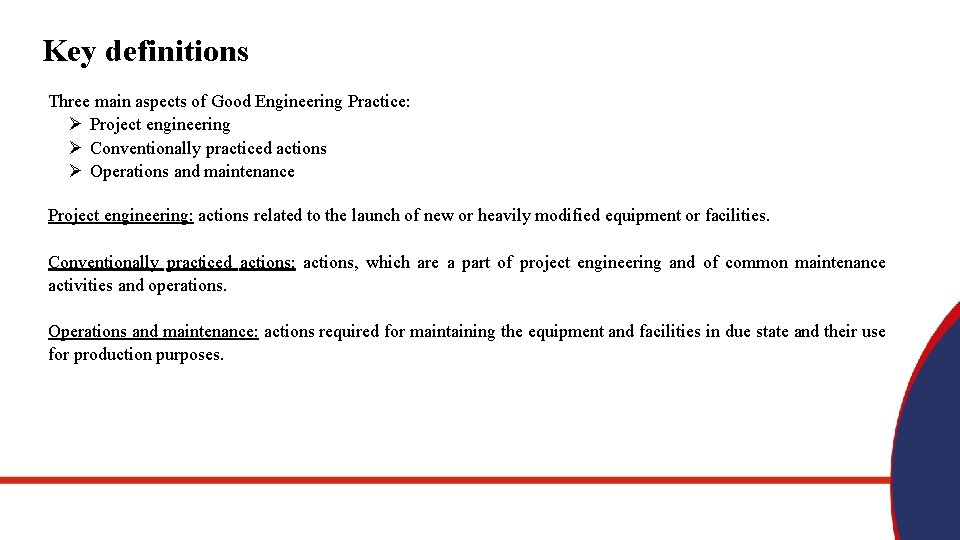

Key definitions Three main aspects of Good Engineering Practice: Ø Project engineering Ø Conventionally

Key definitions Three main aspects of Good Engineering Practice: Ø Project engineering Ø Conventionally practiced actions Ø Operations and maintenance Project engineering: actions related to the launch of new or heavily modified equipment or facilities. Conventionally practiced actions: actions, which are a part of project engineering and of common maintenance activities and operations. Operations and maintenance: actions required for maintaining the equipment and facilities in due state and their use for production purposes.

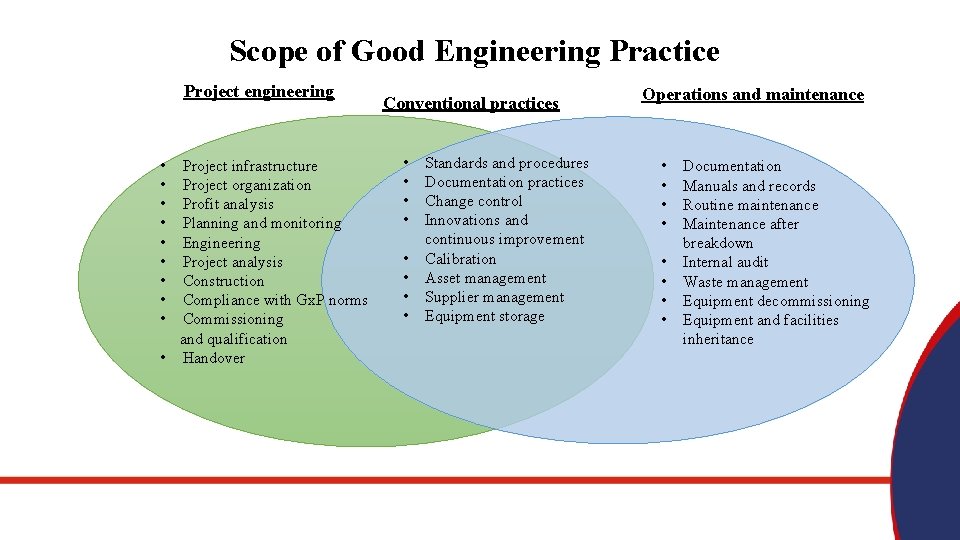

Scope of Good Engineering Practice Project engineering • Project infrastructure • Project organization •

Scope of Good Engineering Practice Project engineering • Project infrastructure • Project organization • Profit analysis • Planning and monitoring • Engineering • Project analysis • Construction • Compliance with Gx. P norms • Commissioning and qualification • Handover Conventional practices • • Standards and procedures Documentation practices Change control Innovations and continuous improvement Calibration Asset management Supplier management Equipment storage Operations and maintenance • • Documentation Manuals and records Routine maintenance Maintenance after breakdown Internal audit Waste management Equipment decommissioning Equipment and facilities inheritance

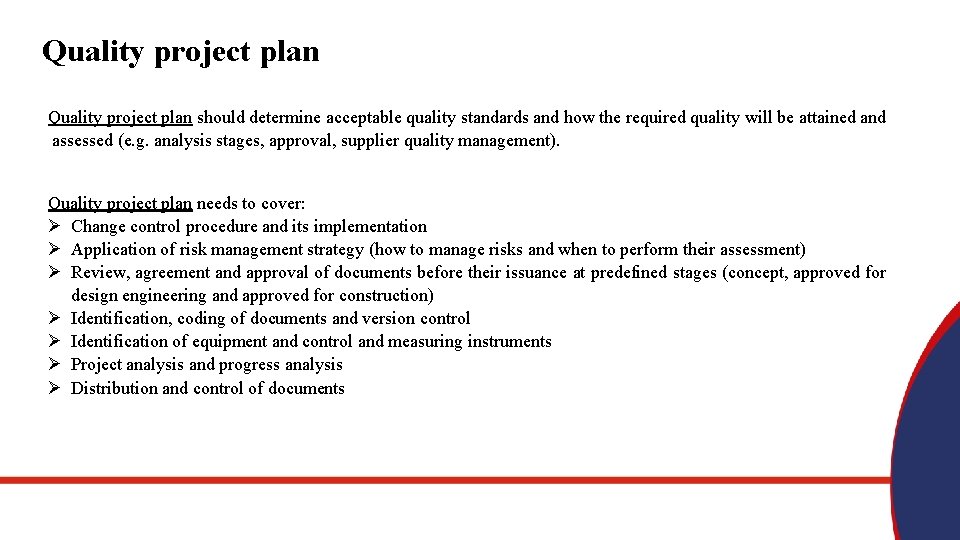

Quality project plan should determine acceptable quality standards and how the required quality will

Quality project plan should determine acceptable quality standards and how the required quality will be attained and assessed (e. g. analysis stages, approval, supplier quality management). Quality project plan needs to cover: Ø Change control procedure and its implementation Ø Application of risk management strategy (how to manage risks and when to perform their assessment) Ø Review, agreement and approval of documents before their issuance at predefined stages (concept, approved for design engineering and approved for construction) Ø Identification, coding of documents and version control Ø Identification of equipment and control and measuring instruments Ø Project analysis and progress analysis Ø Distribution and control of documents

Comparison of non-conformities Non-conformities of all levels Only critical and major non-conformities 1 Construction

Comparison of non-conformities Non-conformities of all levels Only critical and major non-conformities 1 Construction and maintenance of premises Potential contamination (chemical, physical, microbiological) 2 Construction and maintenance of equipment Batch release procedures 3 Production documentation Construction and maintenance of premises 4 Quality system documentation (elements/procedures) Construction and maintenance of equipment 5 Personnel training Sterility assurance 6 Cleaning validation Process validation 7 Process validation Cleaning validation 8 Product quality review Deviation investigation 9 Audit of suppliers and subcontractors Quality system documents (elements/procedures) 10 Calibration of measuring instruments Regulatory requirements (registration dossier)

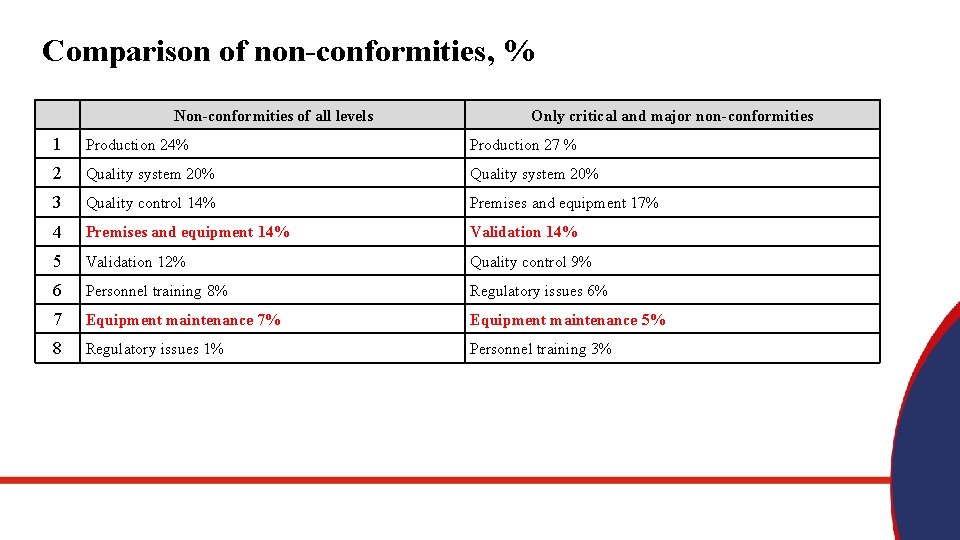

Comparison of non-conformities, % Non-conformities of all levels Only critical and major non-conformities 1

Comparison of non-conformities, % Non-conformities of all levels Only critical and major non-conformities 1 Production 24% Production 27 % 2 Quality system 20% 3 Quality control 14% Premises and equipment 17% 4 Premises and equipment 14% Validation 14% 5 Validation 12% Quality control 9% 6 Personnel training 8% Regulatory issues 6% 7 Equipment maintenance 7% Equipment maintenance 5% 8 Regulatory issues 1% Personnel training 3%

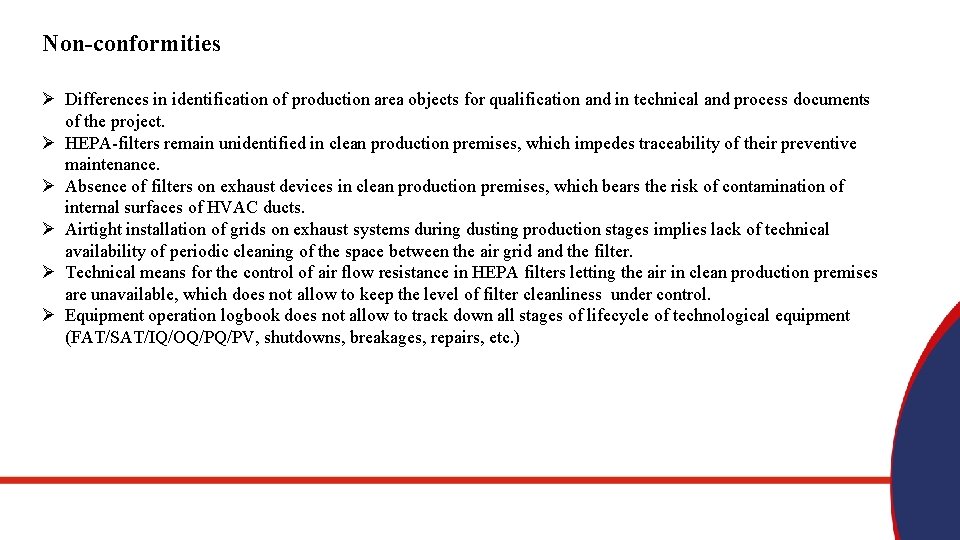

Non-conformities Ø Differences in identification of production area objects for qualification and in technical

Non-conformities Ø Differences in identification of production area objects for qualification and in technical and process documents of the project. Ø HEPA-filters remain unidentified in clean production premises, which impedes traceability of their preventive maintenance. Ø Absence of filters on exhaust devices in clean production premises, which bears the risk of contamination of internal surfaces of HVAC ducts. Ø Airtight installation of grids on exhaust systems during dusting production stages implies lack of technical availability of periodic cleaning of the space between the air grid and the filter. Ø Technical means for the control of air flow resistance in HEPA filters letting the air in clean production premises are unavailable, which does not allow to keep the level of filter cleanliness under control. Ø Equipment operation logbook does not allow to track down all stages of lifecycle of technological equipment (FAT/SAT/IQ/OQ/PQ/PV, shutdowns, breakages, repairs, etc. )

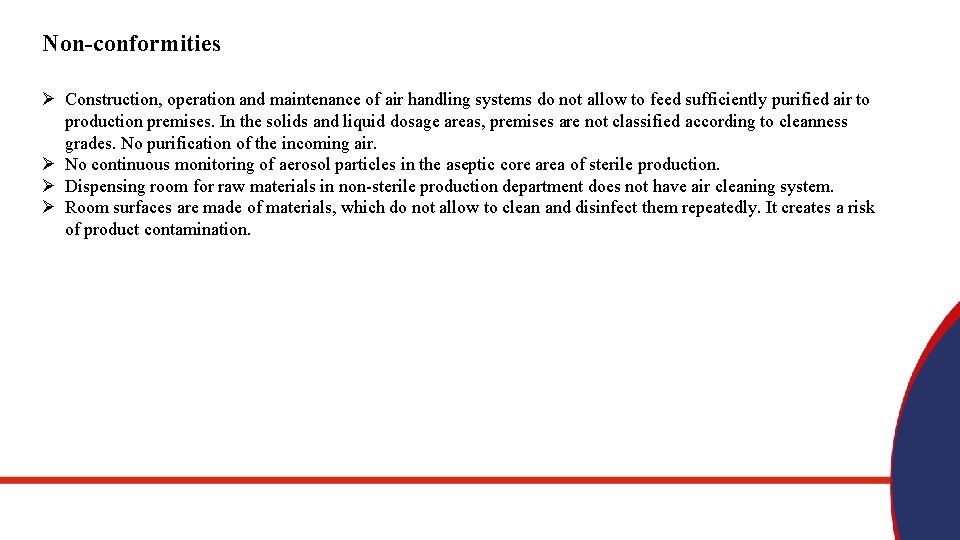

Non-conformities Ø Construction, operation and maintenance of air handling systems do not allow to

Non-conformities Ø Construction, operation and maintenance of air handling systems do not allow to feed sufficiently purified air to production premises. In the solids and liquid dosage areas, premises are not classified according to cleanness grades. No purification of the incoming air. Ø No continuous monitoring of aerosol particles in the aseptic core area of sterile production. Ø Dispensing room for raw materials in non-sterile production department does not have air cleaning system. Ø Room surfaces are made of materials, which do not allow to clean and disinfect them repeatedly. It creates a risk of product contamination.
