CONVENTIONAL FACILITIES STATUS Jess Albino Associate Project Director
CONVENTIONAL FACILITIES STATUS Jess Albino – Associate Project Director for Civil Construction June 9, 2009 Conventional Facilities Status FAC Review – Breakout Session Jess Albino albino@slac. stanford. edu
Agenda – Status of Conventional Construction – Turner Contract – CF Remaining Work – Turner Contract Closeout – Office Space Procurement Conventional Facilities Status FAC Review – Breakout Session 2 2 Jess Albino albino@slac. stanford. edu
Research Yard Conventional Facilities Status FAC Review – Breakout Session 3 3 Jess Albino albino@slac. stanford. edu
Research Yard Conventional Facilities Status FAC Review – Breakout Session 4 4 Jess Albino albino@slac. stanford. edu
Near Experimental Hall Conventional Facilities Status FAC Review – Breakout Session 5 5 Jess Albino albino@slac. stanford. edu
Central Utility Plant Conventional Facilities Status FAC Review – Breakout Session 6 6 Jess Albino albino@slac. stanford. edu
Beam Transport Hall Conventional Facilities Status FAC Review – Breakout Session 7 7 Jess Albino albino@slac. stanford. edu

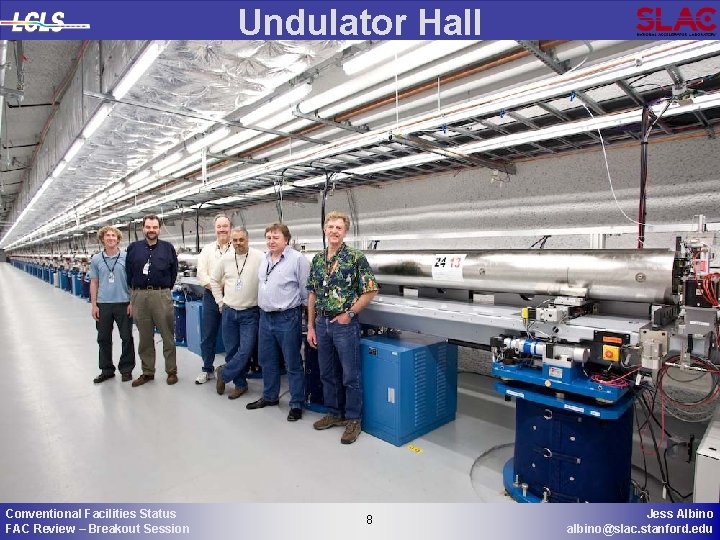

Undulator Hall Conventional Facilities Status FAC Review – Breakout Session 8 8 Jess Albino albino@slac. stanford. edu
Undulator Hall Conventional Facilities Status FAC Review – Breakout Session 9 9 Jess Albino albino@slac. stanford. edu
Undulator Stands Conventional Facilities Status FAC Review – Breakout Session 10 10 Jess Albino albino@slac. stanford. edu
Electron Beam Dump Conventional Facilities Status FAC Review – Breakout Session 11 11 Jess Albino albino@slac. stanford. edu
Electron Beam Dump Conventional Facilities Status FAC Review – Breakout Session 12 12 Jess Albino albino@slac. stanford. edu
Front End Enclosure Conventional Facilities Status FAC Review – Breakout Session 13 13 Jess Albino albino@slac. stanford. edu
Near Experimental Hall – Hutch 1 Conventional Facilities Status FAC Review – Breakout Session 14 14 Jess Albino albino@slac. stanford. edu
Near Experimental Hall Subbasement Conventional Facilities Status FAC Review – Breakout Session 15 15 Jess Albino albino@slac. stanford. edu
Xray Transport and Diagnostic Tunnel Conventional Facilities Status FAC Review – Breakout Session 16 16 Jess Albino albino@slac. stanford. edu
Far Experimental Hall Conventional Facilities Status FAC Review – Breakout Session 17 17 Jess Albino albino@slac. stanford. edu
Substantial Completion Conventional Facilities Status FAC Review – Breakout Session 18 18 Jess Albino albino@slac. stanford. edu
AMO moves into Hutch 1 Conventional Facilities Status FAC Review – Breakout Session 19 19 Jess Albino albino@slac. stanford. edu
LCLS CF Work Remaining • Construct Experimental Hutches in Far Experimental Hall – Structural Steel in fabrication – installation begins in June. – Build-out contract in award stage – NTP in July. • Office Space Alternatives Project – Baseline Change approved – construct new building • Design/Build, Guaranteed Maximum Price contract • Contractor selected – NTP in June Conventional Facilities Status FAC Review – Breakout Session 20 20 Jess Albino albino@slac. stanford. edu

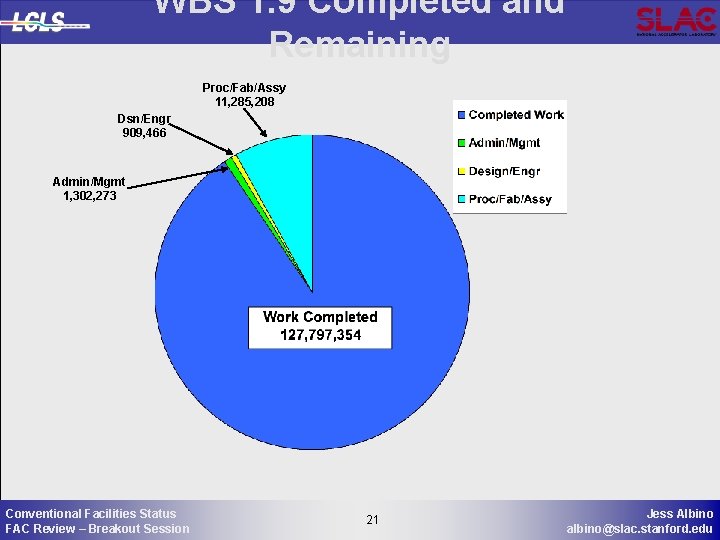

WBS 1. 9 Completed and Remaining Proc/Fab/Assy 11, 285, 208 Dsn/Engr 909, 466 Admin/Mgmt 1, 302, 273 Conventional Facilities Status FAC Review – Breakout Session 21 21 Jess Albino albino@slac. stanford. edu
Turner Contract Closeout Notice of Substantial Completion 11/17/2008 Notice of Completion ~4/24/2009 Remaining Activities Redline mark-ups sent to Jacobs for Record Drawings 23 of 26 trade subcontracts require closeout binders Retention amounts to be released upon closeout Complete Lessons Learned Conventional Facilities Status FAC Review – Breakout Session 22 22 Jess Albino albino@slac. stanford. edu
CF CMGC Stewardship – Lessons Learned • October ’ 06 thru April ’ 07 Ramp Up to Full Production : Procedural Violations – Stand Down of Construction Activities : All Hands Meeting • Review of Work Planning Process for field work – JSA process inadequate – PMT changes – Deficiency Notices • May ’ 07 thru November ’ 07 Full Production : DARTs – Multi-day Stand Down of Construction Activities : Corrective Action Plan • Paperwork ineffectively utilized by CM/GC and trade contractors – – – • December ’ 07 thru April ’ 08 : Some progress, then… – Two DARTs associated with one sub • • • PMT changes Deficiency Notices & Fines Communication with Corporate TCCo Safety Stewardship Committee Established Full time on-site medic (+30 hr OSHA) UTRs added PM removed Work stopped May ’ 08 thru December ’ 08 : No DARTs – – Effective work planning & execution sought Plan for joint observation developed • • • Attendance at daily morning work planning meetings JSA review with workers throughout the day Identification / monitoring of specific trades or tasks for safe work practices Conventional Facilities Status FAC Review – Breakout Session 23 23 Jess Albino albino@slac. stanford. edu
end of presentation Conventional Facilities Status FAC Review – Breakout Session 24 24 Jess Albino albino@slac. stanford. edu
- Slides: 24
