CN Brampton Import Storage 9 February 2006 revised
CN Brampton Import Storage 9 February 2006 (revised 31 March 2006)
Agenda · Backgound · Import storage policy · Off-site storage options · Rail 101 -1 -
Background · The rapid growth in international trade is placing a strain on all components of the supply chain -2 -
Background 26% 27% 17% 35% 30% -3 -
Background wth o r %G 140 -4 -
Background · CN is positioning itself, and thereby positioning its customers, to capitalize on this growth § Expansion of operating hours § Provision of reserved capacity § Terminal expansion · CN’s Brampton storage policy is designed to create the capacity for CN’s customers to continue growing § Brampton is a cross-dock facility § Storage is offerred where land is not required for primary operations · Customers are better served by ensuring their costs are related to the infrastructure they consume -5 -
Import Storage Policy · Import storage – one free day, thereafter $200/day or part thereof § Day of availability § Day after availability § 07: 00 the next day Day 0 Day 1 Day 2 Day 3 07: 00 Import Available Day of Availability Free Day $200 -6 - $400

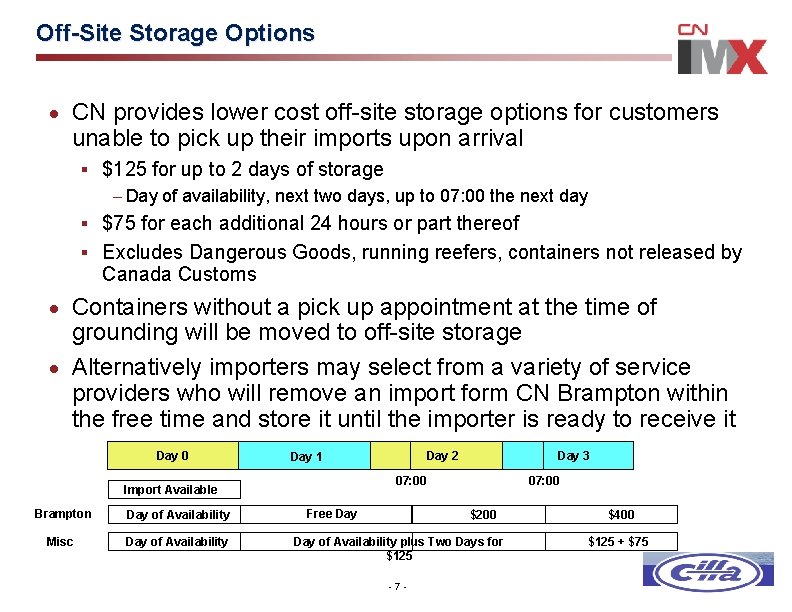

Off-Site Storage Options · CN provides lower cost off-site storage options for customers unable to pick up their imports upon arrival § $125 for up to 2 days of storage – Day of availability, next two days, up to 07: 00 the next day § $75 for each additional 24 hours or part thereof § Excludes Dangerous Goods, running reefers, containers not released by Canada Customs · Containers without a pick up appointment at the time of grounding will be moved to off-site storage · Alternatively importers may select from a variety of service providers who will remove an import form CN Brampton within the free time and store it until the importer is ready to receive it Day 0 Misc Day of Availability Day 3 07: 00 Import Available Brampton Day 2 Day 1 Free Day 07: 00 $200 Day of Availability plus Two Days for $125 -7 - $400 $125 + $75
Rail 101 · Import trains: § Halifax – daily departure 20: 05 Atlantic, arrival 02: 30 day 2 (30 h transit), pad 03: 45 § Montreal – daily departure 07: 15 Eastern, arrival 17: 35 (10 h transit), pad 02: 30 day 1 § Deltaport – daily departure 03: 00 Pacific, arrival 03: 20 day 4 (93 h transit), variable pad § Vancouver waterfront – daily dearture 20: 00 Pacific, arrival 09: 30 day 5 (106 h transit), pad 16: 00 day 5 · Port loading patterns, ETA availability · Booking appointments § Import must have a published availability – Loaded moving TD Vancouvervs Waterfront TA Brampton § Appointment system must be open Sunday Monday Wednesday Tuesday Appointment system opens for Friday -8 - TD Halifax Thursday Import Available Brampton Friday TA Brampton Import Available Brampton
Rail 101 · Pad Availability § To assist the importer with planning their pick up CN will update its systems with an anticipated “pad availability” by noon the day before scheduled placement – This will enable an importer to arrange/comfirm their pick up with the importer -9 -

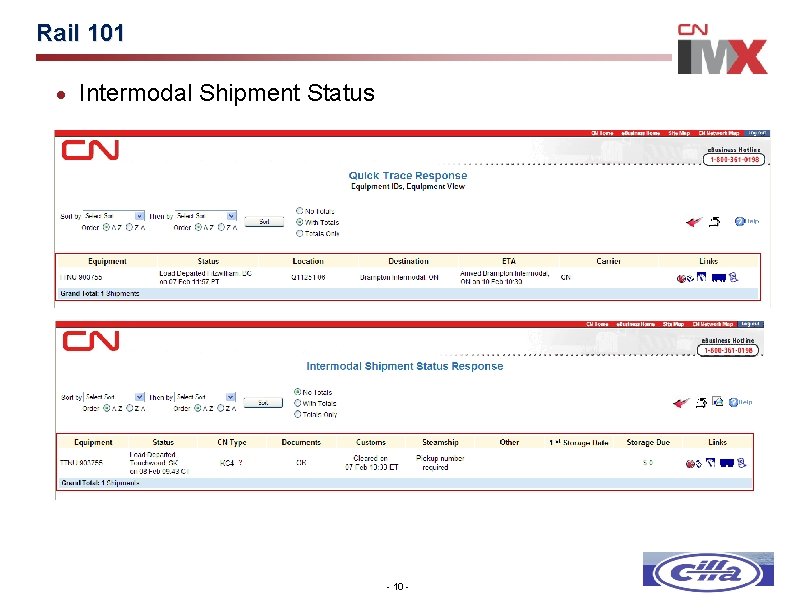

Rail 101 · Intermodal Shipment Status - 10 -
Rail 101 · Points to Note: § Scheduled placement is generally conservative – Designed to ensure availability by listed time § If no appointment is made prior to grounding the import will be moved off -site – To ensure import remains at Brampton do not wait until day of placement to make appointment § Appointment may be made when import dispays ETA – Reconfirm after pad availability is displayed – An alert will be sent to the registered email address if pad availability precludes appointment from being fulfilled § Certain circumstances may prevent an import being available immediately at scheduled pad placement. To prevent a dead run: – Monitor actual pad availability when scheduling tight – Plan pick up for the free day - 11 -
Rail 101 · Considerations: § If CN has not provided a scheduled pad availability by noon the day before, the import will continue to have two free days § Storage clock will begin with the later of scheduled pad availability or actual availability § If an appointment cannot be fulfilled due to rescheduling/late pad placement the import will continue to have two free days - 12 -
Rail 101 · Storage: § Any party that will guarantee storage should be set up to do so on line § At the present time, storage may only be guaranteed once the container grounds - 13 -
