CMS WGM 297 SP Team Report Joel Butler
CMS WGM 297 SP Team Report Joel Butler, 16. 02. 2017
Outline § § § The LHC status and schedule Brief Status Report on Detectors and Operations Computing Campaigns Preparations for the LHCC New applications for membership in CMS and new Appointments, endorsements, etc § Initiatives starting up § ECo. M 17 § Machine Learning § Initiatives still ahead of us § Sustainability § Approach to physics discoveries 16/02/17 WGM 297 2
LHC Status and Schedule (all preliminary from LMC of Feb. 15) 16/02/17 WGM 297 3
So far, so good Ready for closure the 6 th Feb. Quality Assurance team § All is good so far (no non-conformities) § Main next steps § Cool-down (6 weeks) with P 18 -P 2 reconfiguration § El. QA @cold (2 weeks) § Recommissionning (3 weeks) 16/02/17 WGM 297 4
Draft LHC Schedule 2017 – Q 1 Now • Presently in EYETS mode • Start of powering tests, scheduled for 31/03 16/02/17 WGM 297 5
Draft LHC Schedule 2017 – Q 2 § § § The complete LHC will be handed over to OP by April 14 th, Wk 15 Wk 18 – 22: re-commissioning with beam and intensity ramp up Initial e-cloud scrubbing run in Wk 23 followed by luminosity production Special Physics run time is indicative and details remain to be defined MD 1 block was moved forward from Wk 29 16/02/17 WGM 297 6

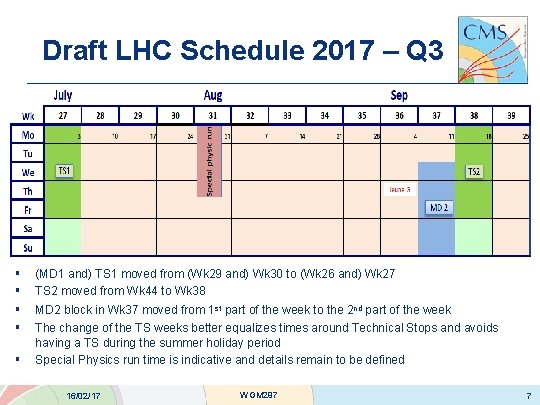

Draft LHC Schedule 2017 – Q 3 § § (MD 1 and) TS 1 moved from (Wk 29 and) Wk 30 to (Wk 26 and) Wk 27 TS 2 moved from Wk 44 to Wk 38 § § MD 2 block in Wk 37 moved from 1 st part of the week to the 2 nd part of the week The change of the TS weeks better equalizes times around Technical Stops and avoids having a TS during the summer holiday period Special Physics run time is indicative and details remain to be defined § 16/02/17 WGM 297 7
Draft LHC Schedule 2017 – Q 4 § LHC stops Monday December 11 th one week earlier than the injectors, to secure liquid helium inventory, as decided in Chamonix § MD 3 block in Wk 43 moved from 2 nd part of the week to the 1 st part of the week § The 5 Te. V pp reference run is under discussion and remains to be confirmed and is therefore not (yet) indicated 16/02/17 WGM 297 8
Draft Summary Table 2017 - v 0. 6 Phase Days Commissioning & Intensity ramp up Ratio to total beam time 35 15% 7 3% 25 ns Proton Physics 145 65% Special Physics Runs 8 4% Machine Developments (MD) 15 7% Technical Stops (TS 1 & TS 2) 10 4% 4 2% 224 100% Scrubbing Technical Stop Recovery Total 16/02/17 WGM 297 9

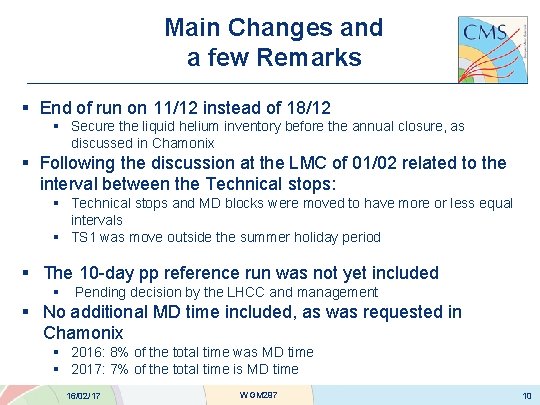

Main Changes and a few Remarks § End of run on 11/12 instead of 18/12 § Secure the liquid helium inventory before the annual closure, as discussed in Chamonix § Following the discussion at the LMC of 01/02 related to the interval between the Technical stops: § Technical stops and MD blocks were moved to have more or less equal intervals § TS 1 was move outside the summer holiday period § The 10 -day pp reference run was not yet included § Pending decision by the LHCC and management § No additional MD time included, as was requested in Chamonix § 2016: 8% of the total time was MD time § 2017: 7% of the total time is MD time 16/02/17 WGM 297 10
Brief Status Report on Detector 16/02/17 WGM 297 11
Pixels § § § Barrel Pixels have arrived. All pixel detectors are at CERN!!! Challenge is to have a working, physics-ready detector that can be incorporated into the HLT as quickly as possible Installation plan: BPIX: 27/28 Feb; FPIX: 7 and 9 March. Problems appeared with FUSES in DC-DC converters, observed first on FPIX § Root cause is known and mitigations have been developed Final Cold Test of BPIX at P 5 is underway § Some problems have surfaced – investigations ongoing § Affects 1/8 of ¼ of the BPIX (two outer layers) § § Last services near the detector are being installed Run Coordination is preparing for pixel alignment and calibration running as soon as device is ready Software is well along but optimization and fine tuning in next two months Readout can now operate at ~100 KHz with pileup ~70. Improvements will still be undertaken to gain headroom We will lose some luminosity at the beginning of the run since some commissioning must be done with collisions. We expect to “effectively” recover it through higher efficiency, better resolution, and lower fake rate. We will work to minimize this loss. 16/02/17 WGM 297 12

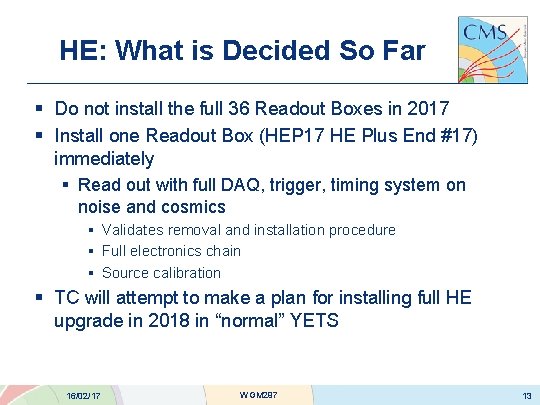

HE: What is Decided So Far § Do not install the full 36 Readout Boxes in 2017 § Install one Readout Box (HEP 17 HE Plus End #17) immediately § Read out with full DAQ, trigger, timing system on noise and cosmics § Validates removal and installation procedure § Full electronics chain § Source calibration § TC will attempt to make a plan for installing full HE upgrade in 2018 in “normal” YETS 16/02/17 WGM 297 13
HE: What is not decided § Whether to leave HEP 17 in for data taking § Many issues related to reconstruction software, simulation, triggering, physics objects (JETMET) § Whether it can be calibrated and operated at a level consistent with the performance goals of the HE § Physics Coordination has set specific targets § Whether to do the full HE upgrade in YETS in 2018 § An acceptable schedule may not be possible § Other more serious problems might need to be dealt with § The risks of a new detector that will be in for only one year may not be worth the rewards, especially if the radiation damage is less than expected § However, the experience in operation HE might reveal something for the barrel whose upgrade will be with us until the end of CMS § See detailed discussion in the talk “Wrap up on EYETS Status” from the last day of CMS week The story continues! 16/02/17 WGM 297 14
Plan 1 Proposed Timeline - I § Perform HEP 17 Co-60 calibration/check with Phase 0 (HPD+QIE 8) on Feb 4 (or Feb 11) weekends § Removal of HPD/QIE 8 and backplane on Feb 6 (or Feb 13) after sourcing § Allow measurement of HPD PDE spectra § Phase 0 Readout Modules will remain intact § Installation of HEP 17 Phase 1 (Si. PM/QIE 11) § The day after the above § Commissioning and operational experience for about 3 weeks § Including Co-60 calibration of HEP 17 Phase 1 § All set of local runs (PED, LASER) § Test full trigger primitive generation chain (front-end to L 1) § Participation in global running § In parallel, the implementation of the offline software Plan 1 workflow is in progress § MC studies of the impacts of Plan 1 on Jet. MET and trigger performance should provide some of the critical answers by the end of February 16/02/17 WGM 297 15
Plan 1 Proposed Timeline - II § CMS decision to be made at the beginning of March on a) keeping HEP 17 Phase 1 in, additional weeks of operational experience with HEP 17 phase 1 prior to CMS closing (still sufficient time to revert to phase 0 in case of late issues) b) revert HEP 17 to Phase 0 in early March, leaving abundant time to restore, re-commission (including another Co-60 calibration) and re-operate HEP 17 Phase 0 prior to CMS closing Ø Going through the Phase 1 installation, commissioning and operations exercise is still considered important/worthwhile 16/02/17 WGM 297 16
Run Coordination: Preparation for the Startup § Lots of details in Plenary Run Coordination talks at CMS Week Plenary Session (https: //indico. cern. ch/event/602633/timetable/ ) § The LHC Performance Workshop, a. k. a. the Chamonix meeting (https: //indico. cern. ch/event/580313/) took place from Jan 23 -27. § Commissioning Plans are being developed § Midweek Global Runs have started § MWGR#1 took place last week § commissioning plans for upgraded HE RBX 16/02/17 WGM 297 17

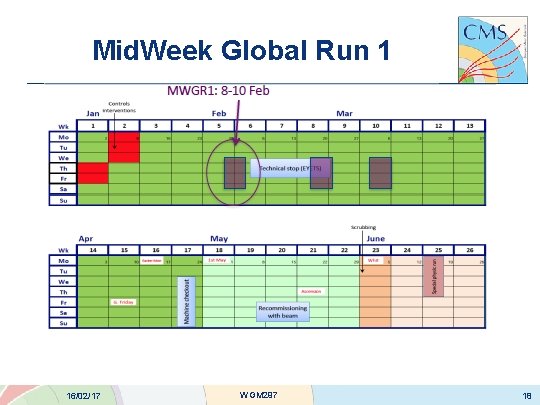

Mid. Week Global Run 1 16/02/17 WGM 297 18
MWGR 1 § Central goals for MWGR 1: • • • Trigger and run overnight with as many subsystems as available; Confirm rates as expected for cosmics (i. e. as expected according to actual availability of muon systems to join); • Confirm readout timing is the same as 2016; Start commissioning of upgraded HE RBX (HEP 17) if available to join global § Main achievements: • • Run with strips sending fake events. All the chain worked fine Run in the night with available detectors in: (parts of) ES, CSC, DT, HO, HB, HE and trigger • Initial assessment: rates and r/o timing OK (more analysis coming) • HEP 17 included in global Friday night 16/02/17 WGM 297 19
Commissioning HEP 17 § Arranging for week of Feb 20 th dedicated to HEP 17 commissioning § DAQ and L 1 trigger resources will be available for this effort § Then participate in MWGR 2 (1 -3 March) § § Main items are stress of the system and commissioning of § read out chain § trigger primitives § full trigger chain (up to HLT depending on code availability) Many concerns about trigger, reconstruction software, calibration, databases, and object performance § Different longitudinal segmentation § Have software for 32 HPDs or 32 Si. PM-based sectors but nothing for 35 HPDs + 1 Si. PM sector § Causing uncertainty in 2017 Monte Carlo production 16/02/17 WGM 297 20
Computing Campaigns 16/02/17 WGM 297 21
Phase-I (2017) preparation § Producing samples with CMSSW 81 X for POG development and Trigger studies § Good progress in production § TSG sample will need to be reproduced with new HE configuration (plan 0/plan 1) 16/02/17 WGM 297 22
Mini. AOD reprocessing § address at Mini. AOD level some issues of our data § E/gamma: ECAL local reco problems with gain switch § Muon, MET: poorly reconstructed muons, partly due to tracking mitigation for Si. Strip dynamic inef § Re-Mini. AOD injected on top of last re-reco, ~done § more then 100 datasets VALID in DAS (03 Feb 2016) § In the meanwhile POGs finalizing scale factors and analysis level corrections 16/02/17 WGM 297 23

Phase-II (2026) production § Production for Phase 2 Tracker TDR § High pileup (PU 200) samples are showing up 16/02/17 WGM 297 24
2017 Production Activities 16/02/17 WGM 297 25
The Next Five Weeks 16/02/17 WGM 297 26
Preparations for the LHCC 16/02/17 WGM 297 27
LHCC: Feb 21 -23, 2017 § CMS Meeting with Referees, on Tue, Feb 21, 15: 30 § the general LHCC agenda can be found here, https: //indico. cern. ch/event/609156/otherview? view=standard § the draft agenda for the CMS-LHCC meeting on Tue, Feb 21, is available at https: //indico. cern. ch/event/611600/. § Open Session, Wed 22 Feb: (see also http: //indico. cern. ch/event/609813/) § Sudan Paramesvaran will give the CMS presentation – § Note: Sudan is also invited to the XEBs from now to the LHCC meeting and to the MB on Feb 13 16/02/17 WGM 297 28
More LHCC § Several other events § Tour of Point 5 by LHCC, morning Feb. 20 § UCG meeting Feb 21, 14: 15 -15: 15 § TOTEM and CT-PPS meeting with LHCC referees – Feb 21, 12: 00 – 14: 30 § CT-PPS and CMS-TOTEM issues (90 m running) will be first § WLCG meeting with referees, Feb 21, 13: 30 -15: 00 § LHCC Poster session, Feb 22, 17: 00 -19: 00, Pas Perdu § Definitely worthwhile – please attend if you are at CERN § CMS closed session, Feb 23, 9: 35 -10: 50 16/02/17 WGM 297 29
New Applications for Membership in CMS 16/02/17 WGM 297 30
Actions on new Institutions in CMS from MB 202 § Sevilla and LAU– Associate members – case will be reviewed in next MB on March 27 and decision wil be made whether to invite to present their cse to the CB on April 7. § University of Crna. Gora, Montenegro will be invited to make a presentation on their candidacy for full membership at the April 7 CB. We will get a sttus report at the March 27 MB. 16/02/17 WGM 297 31
Expressions of interest in CMS membership § Interest in eventual full CERN membership has been expressed by the following institutes: Ø COMSAT Institute of Information Technology, Islamabad, Pakistan Ø Tsinghua University, Beijing, China (already Associate member of CMS) 16/02/17 WGM 297 32
Appointments, Endorsements, etc 16/02/17 WGM 297 33
Offline and Computing Organization Chart 16/02/17 WGM 297 34
Appointments in Offline and Computing § Workload and Data Management: Jean-Roch Vlimant § Upgrade Software: Kevin Pedro § Web Services and Security: Mine Altunay § User Support: Marguerite Tonjes 16/02/17 WGM 297 35
Nomination Processes Underway § § § Co-Coordinators (Sept. 1, 2017 – Aug 31, 2019) § Physics Co-Coordinator § Run Co-Coordinator § Trigger Co-Coordinator § Offline & Computing Co-Coordinator § Physics Performance and Dataset Co-Coordinator § Upgrades Coordinator § Nominations closed Feb 8, 2017 L 2 PAG/POG Co-Conveners (Sept 1, 2017 - Aug. 31, 2019) § POGs: EGM, MUO, TRK, JME, BTV, LUM, GEN(joint with Offline & Computing), TAU(2 needed); § PAGs: BPH, B 2 G, EXO, FSQ, HIG, HIN, SMP, SUS, TOP. § Nominations closed Feb 8, 2017 PPD Acting L 2 conveners to be confirmed § DQM group convener § Pdm. V group convener Endorsement at MB 203, March 27, 2017 Final Approvals at CB meeting on April 7, 2017 16/02/17 WGM 297 36
Initiatives starting up 16/02/17 WGM 297 37

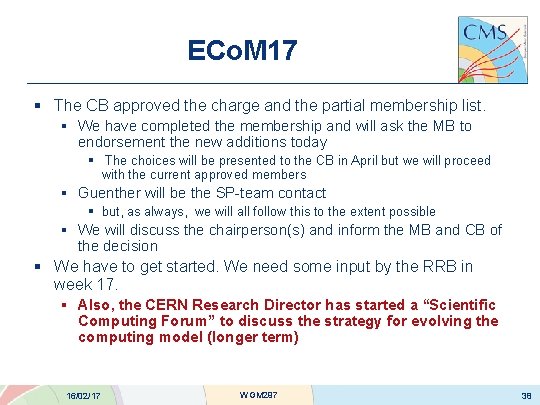

ECo. M 17 § The CB approved the charge and the partial membership list. § We have completed the membership and will ask the MB to endorsement the new additions today § The choices will be presented to the CB in April but we will proceed with the current approved members § Guenther will be the SP-team contact § but, as always, we will all follow this to the extent possible § We will discuss the chairperson(s) and inform the MB and CB of the decision § We have to get started. We need some input by the RRB in week 17. § Also, the CERN Research Director has started a “Scientific Computing Forum” to discuss the strategy for evolving the computing model (longer term) 16/02/17 WGM 297 38
ECo. M 17 Membership § § § M. Klute (MIT) L. Silvestris (Bari) D. Olivito (UCSD) F. Pantaleo (CERN) M. Pierini (CERN) S. Rahatlou (Rome) T. Boccali (Pisa) H. Newman (Caltech) F. Wuerthwein (UCSD) I. Park (Seoul) G. Petrucciani (CERN) C. Wissing (DESY) 16/02/17 WGM 297 D. Bonacorsi (Bologna) E. Sexton_Kennedy (FNAL) C. Shepherd (RAL) L. Apanasevich (University of Illinois, Chicago) Chairpersons (or designees) of the CRB, CB, and FB will be ex officio members. Guenther Dissertori will represent the SP-team. 39
Machine Learning Forum § This will be a discussion FORUM § Not a working group or task force § A possible outcome is that it eventually “suggests” whether/how CMS might proceed in this area § Will be open to all § A preliminary “definition” is attached to the agenda of this meeting § There will soon be a call for nominations for two conveners § Will work with conveners and others to refine the definition § Target is to get started right after conveners are in place (hopefully two weeks after the call) 16/02/17 WGM 297 40
Initiatives still ahead of us 16/02/17 WGM 297 41
Initiatives on the Horizon § Sustainability Issue – ability of CMS to continue to run until 2035 § Main issues § Loss of knowledge (retirements etc. , departures, change of assignments within CMS) § Poor or missing documentation § Technological obsolescence § Start after we are taking data smoothly § Upgrade Coordination after TDRs are approved § Need to start working on this in the late spring to smoothly connect to end of TDRs § The preferred method is to create a “project office” to make the transition to a new arrangement, which will be a plan that is developed by the SP and Upgrade Coordinator and requires MB endorsement and CB approval § From the CMS Constitution: “A Project Office may be set up to assist the Coordinator. Its membership must be endorsed by the Management Board and approved by the Collaboration Board. 16/02/17 WGM 297 42
Publications, Conferences 16/02/17 WGM 297 43
Publications status Activity since previous WGM: Papers Accepted (the date is that of acceptance) § HIG-16 -016, Searches for invisible decays of the Higgs boson in pp collisions at s = 7, 8, and 13 Te. V, JHEP (07 -Feb-2017) § EXO-15 -005, Search for narrow resonances in dilepton mass spectra in proton collisions at s = 13 Te. V and combination with 8 Te. V data, JHEP (07 -Feb 2017) § SUS-14 -006, Search for top squark pair production in compressed-mass-spectrum scenarios in proton-proton collisions at s = 8 Te. V using the a. T variable, PLB (07 Feb-2017) § SMP-14 -012, Measurement of the transverse momentum spectra of weak vector bosons produced in proton-proton collisions at s = 8 Te. V, JHEP (09 -Feb-2017) Papers submitted: (the date is that of submission) § SMP-14 -018, Measurement of the cross section for electroweak production of Zg in association with two jets and constraints on anomalous quartic gauge couplings in proton-proton collisions at s = 8 Te. V, PLB (10 -Feb-2017) 16/02/17 WGM 297 44

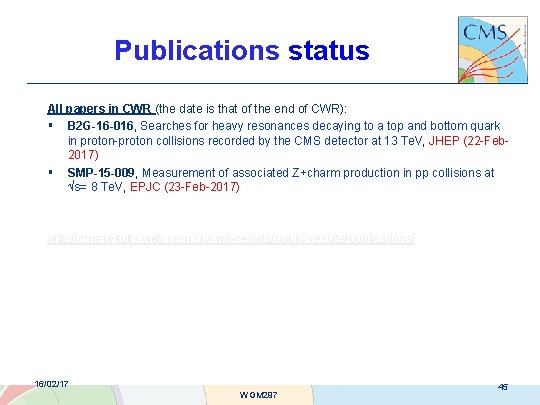

Publications status All papers in CWR (the date is that of the end of CWR): § B 2 G-16 -016, Searches for heavy resonances decaying to a top and bottom quark in proton-proton collisions recorded by the CMS detector at 13 Te. V, JHEP (22 -Feb 2017) § SMP-15 -009, Measurement of associated Z+charm production in pp collisions at s= 8 Te. V, EPJC (23 -Feb-2017) http: //cms-results. web. cern. ch/cms-results/publications/ 16/02/17 WGM 297 45
Conference Speaker Status Last call for the following talks/conferences without nominations: – TRENTO WS 2017, QCD Challenges in pp, p. A and AA Collisions, Feb. 27 – Mar. 3, Trento (IT) 4 overview talks (HIN, FSQ) planned for CMS, but zero candidates! – IHEP-T 2 E, Intern. Conf. on High Energy Physics – Theory to Experiment, Feb. 27 – Mar. 1, Kuala Lumpur (MY) Keynote presentation on CMS, and up to 3 contributed talks Next in line: – DIS 2017, 25 th International Workshop on DIS and Related Topics, Apr. 3 – 7, Birmingham (UK) ~7 talks without nominations, many with only one nomination, more talks waiting for confirmation – DM@LHC 2017, Dark Matter at the Large Hadron Collider, Apr. 3 – 5, Irvine, CA (US) 3 talks without nominations: mono-V, resonances, BSM Higgs For details/nominations as well as many other interesting future conferences and talks, please check: https: //cms-mgt-conferences. web. cern. ch/cms-mgt-conferences/conf_listing. aspx https: //hypernews. cern. ch/Hyper. News/CMS/get/conf. Announce. html (please subscribe!) 16/02/17 WGM 297 46
Other news, announcements and reminders 16/02/17 WGM 297 47
Partial List of Recent and Upcoming Events § Jan 30 – Feb 3: CMS week § Feb 13: MB § Feb 21 -23: LHCC § Sudan will give the CMS talk at the open session § Mar 6 -10: Tracker Phase-II week § Mar 20 -Apr 1: Moriond EW+QCD § Mar 27: MB § Apr 3 -7: CMS Week 16/02/17 WGM 297 48
Upcoming workshops § Trigger (L 1+TSG) Workshop § Feb 22 - 24 in Bristol § Muon Phase-II Workshop § Mar 22 - 24 § ALCA/DB workshop § Feb 27 – Mar 1 § Workshop to look at failure scenarios at P 5 and the effect on data quality. § End-Feb/beg-Mar § Tracker Phase-II week § Mar 6 - 10 16/02/17 WGM 297 49
Thank you for your attention! 16/02/17 WGM 297 50
Backup Slides 16/02/17 WGM 297 51
CMS Management Board 2017 Advisors Ex-SP: T. Camporesi Ex-TC: A. Hervé L. A. T. Bauerdick , H. Chen, I. Golutvin, V. O'Dell, A. Santoro, A. Sharma, F. Sikler , G. Tonelli, B. Wyslouch Upgrade Coordination D. Contardo A. Dabrowski CTPPS J. Varela Endcap Calorimeter T. Virdee M. Mannelli J. Butler W. Zeuner E. Perez DAQ F. Meijers Tracker A. Venturi F. Hartmann Muons J. Hauser A. Colaleo ECAL D. Petyt F. Cavallari HCAL P. Rumerio J. Dittmann Physics Coordination J. Alcaraz Maestre S. Rahatlou Trigger A. Bocci S. Gennai Publications B. Gary Communication A. Petrilli PPD G. Cerminara M. Klute Conferences A. Meyer Offline & Computing D. Bonacorsi E. Sexton-Kennedy MB Secretary Q. Ingram Run G. Rakness S. Goy-Lopez S. Choi (Deputy) N. Hadley (secretary) U. S. A G. Snow Italy R. Tenchini Germany T. Müller RDMS V. Matveev U. K. D. Newbold France Y. Sirois Switzerland F. Canelli CERN T. Camporesi Non-MS K. Mazumdar Other MS P. Sphicas Regional Representatives L. Silvestris Detector systems Collaboration Board CB Chair J. D’Hondt Resources Manager A. Charkiewicz Electronics Coord. M. Hansen GLIMOS N. Dupont L 1 Trigger A. Tapper Engagement Office K. Borras R. Carlin, G. Dissertori Technical Coordination A. Ball L. Malgeri, J. Spalding BRIL D. Stickland Spokesperson Coordinations September 2016 Version 0 52
