CLIC Schedule K Foraz CLIC 10 Workshop 18

  • Slides: 14
Download presentation
CLIC Schedule K. Foraz CLIC 10 Workshop 18 -22 October 2009

CLIC Schedule K. Foraz CLIC 10 Workshop 18 -22 October 2009

Outline • Main LINAC – Schedule – Installation versus Module production – Resources •

Outline • Main LINAC – Schedule – Installation versus Module production – Resources • Injectors – Method – Schedules – Resources • Global – Schedule – Rough estimation of resources October, 20 th 2010 K. Foraz, International Workshop on Linear Colliders 2010

Main LINAC – Construction & installation Schedule Site installation Shaft construction Tunnel excavation Tunnel

Main LINAC – Construction & installation Schedule Site installation Shaft construction Tunnel excavation Tunnel construction Survey CLIC 500 Ge. V 11 -9 9 -7 7 -5 5 -3 3 -1 1 -2 2 -4 4 -6 6 -8 El. Gen. services Piping Cabling Machine transport Machine inst. 8 -10 1 1 2 2 3 3 4 4 5 5 6 6 Commissioning @ 500 Ge. V 7 Comm. 8 Comm. 9 9 Commissioning @ 3. Te. V 10 October, 20 th 2010 10 K. Foraz, International Workshop on Linear Colliders 2010

Main LINAC – Installation vs. Production Modules production and installation Contracts signed when the

Main LINAC – Installation vs. Production Modules production and installation Contracts signed when the civil engineering starts 20000 Nb of modules 15000 Stock 10000 Production Installation (1. 5 years) 5000 0 0 To+3 years October, 20 th 2010 6 12 18 24 30 Months 36 42 48 54 K. Foraz, International Workshop on Linear Colliders 2010

Nb of worksites/ contracts Main LINAC - resources 5 4 3 2 1 0

Nb of worksites/ contracts Main LINAC - resources 5 4 3 2 1 0 Y 1 Y 2 Civil Eng. Contracts October, 20 th 2010 Y 3 Piping Y 4 Cabling Y 5 EL General services K. Foraz, International Workshop on Linear Colliders 2010

Injectors - Method Schedules drawn with the experience on other machines, especially LINAC 4

Injectors - Method Schedules drawn with the experience on other machines, especially LINAC 4 installation, which is just starting October, 20 th 2010 K. Foraz, International Workshop on Linear Colliders 2010

Injectors – Damping Rings October, 20 th 2010 K. Foraz, International Workshop on Linear

Injectors – Damping Rings October, 20 th 2010 K. Foraz, International Workshop on Linear Colliders 2010

Injectors: Main Beam (1/2) • Klystron hall – Divided in 6 splices of ~150

Injectors: Main Beam (1/2) • Klystron hall – Divided in 6 splices of ~150 m – Resources doubled : 26 months October, 20 th 2010 K. Foraz, International Workshop on Linear Colliders 2010

Injectors – Main Beam (2/2) • Main Beam Tunnel – Effort doubled ► 30

Injectors – Main Beam (2/2) • Main Beam Tunnel – Effort doubled ► 30 months October, 20 th 2010 K. Foraz, International Workshop on Linear Colliders 2010

Injectors – Drive Beam • Same strategy than for the Main Beam…but 2140 m

Injectors – Drive Beam • Same strategy than for the Main Beam…but 2140 m !!! – Surface building splitted into 12 splices ( 3 * 4) – Tunnel: 2 entries Ø 35 months October, 20 th 2010 K. Foraz, International Workshop on Linear Colliders 2010

Injectors – Summary schedule DB CR ▼ DR Civil Eng. 1 2 Civil Eng.

Injectors – Summary schedule DB CR ▼ DR Civil Eng. 1 2 Civil Eng. Installation Inst. 5 6 October, 20 th 2010 Com. 1 2 Installation Civil Eng. 3 4 MB Com. 3 4 5 6 7 7 8 8 9 9 10 10 K. Foraz, International Workshop on Linear Colliders 2010

Nb of worksites/ contracts Injectors - Resources 10 9 8 7 6 5 4

Nb of worksites/ contracts Injectors - Resources 10 9 8 7 6 5 4 3 2 1 0 Y 1 Civil Eng. Contracts October, 20 th 2010 Y 2 Y 3 Ventilation worksites Y 4 Piping Y 5 EL General services K. Foraz, International Workshop on Linear Colliders 2010 Cabling

General schedule CLIC 500 Ge. V 11 -9 9 -7 7 -5 5 -3

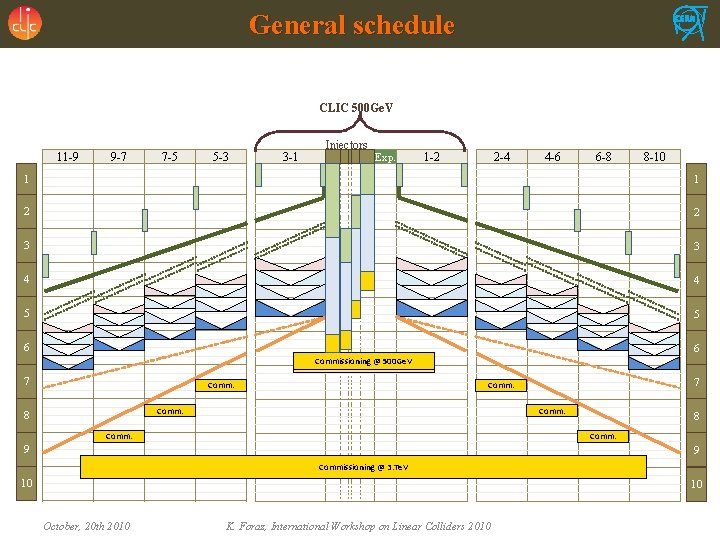

General schedule CLIC 500 Ge. V 11 -9 9 -7 7 -5 5 -3 3 -1 Injectors Exp. 1 -2 2 -4 4 -6 6 -8 8 -10 1 1 2 2 3 3 4 4 5 5 6 6 Commissioning @ 500 Ge. V 7 Comm. 8 Comm. 9 9 Commissioning @ 3. Te. V 10 10 October, 20 th 2010 K. Foraz, International Workshop on Linear Colliders 2010

Rough estimate of resources Nb of worksites/ contracts 14 12 10 8 6 4

Rough estimate of resources Nb of worksites/ contracts 14 12 10 8 6 4 2 0 Civil Eng. Contracts Y 1 October, 20 th 2010 Ventilation worksites Y 2 Y 3 Piping EL Gseneral services Y 4 K. Foraz, International Workshop on Linear Colliders 2010 Y 5 Cabling
