CHAPTER NINE Reducing Project Duration Mc GrawHillIrwin Copyright

  • Slides: 19
Download presentation
CHAPTER NINE Reducing Project Duration Mc. Graw-Hill/Irwin Copyright © 2011 by The Mc. Graw-Hill

CHAPTER NINE Reducing Project Duration Mc. Graw-Hill/Irwin Copyright © 2011 by The Mc. Graw-Hill Companies, Inc. All rights reserved.

Where We Are Now 9– 2

Where We Are Now 9– 2

Rationale for Reducing Project Duration • Time Is Money: Cost-Time Tradeoffs – Reducing the

Rationale for Reducing Project Duration • Time Is Money: Cost-Time Tradeoffs – Reducing the time of a critical activity usually incurs additional direct costs. • Cost-time solutions focus on reducing (crashing) activities on the critical path to shorten overall duration of the project. – Reasons for imposed project duration dates: • Time-to-market pressures • Unforeseen delays • Incentive contracts (bonuses for early completion) • Imposed deadlines and contract commitments • Overhead and public goodwill costs • Pressure to move resources to other projects 9– 3

Options for Accelerating Project Completion • Resources Not Constrained • Resources Constrained – Adding

Options for Accelerating Project Completion • Resources Not Constrained • Resources Constrained – Adding resources – Fast-tracking – Outsourcing project work – Critical-chain – Scheduling overtime – Compromise quality – Reducing project scope – Establishing a core project team – Do it twice—fast and then correctly 9– 4

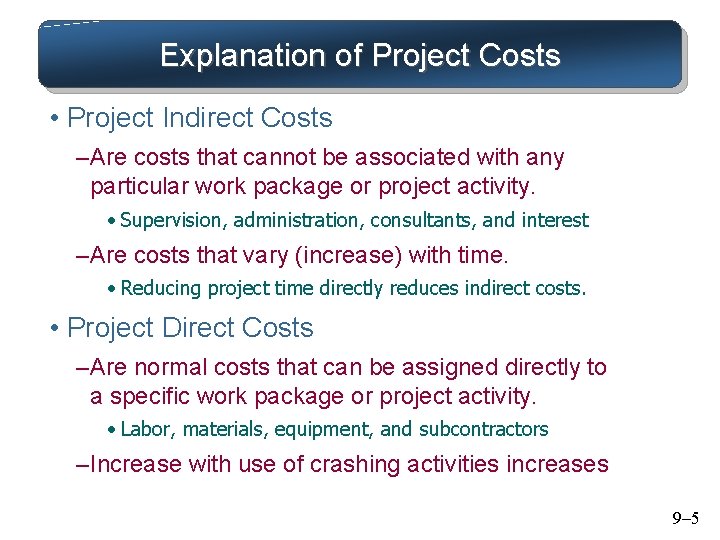

Explanation of Project Costs • Project Indirect Costs – Are costs that cannot be

Explanation of Project Costs • Project Indirect Costs – Are costs that cannot be associated with any particular work package or project activity. • Supervision, administration, consultants, and interest – Are costs that vary (increase) with time. • Reducing project time directly reduces indirect costs. • Project Direct Costs – Are normal costs that can be assigned directly to a specific work package or project activity. • Labor, materials, equipment, and subcontractors – Increase with use of crashing activities increases 9– 5

Seeking Optimal Project Duration to Minimize Project Cost Identifying direct costs to reduce project

Seeking Optimal Project Duration to Minimize Project Cost Identifying direct costs to reduce project time Gather information about direct and indirect costs of each specific project duration. Search critical activities of lowest direct-cost increase to shorten project duration. Compute total costs for each specific duration and evaluate the tradeoff between project cost and duration. 9– 6

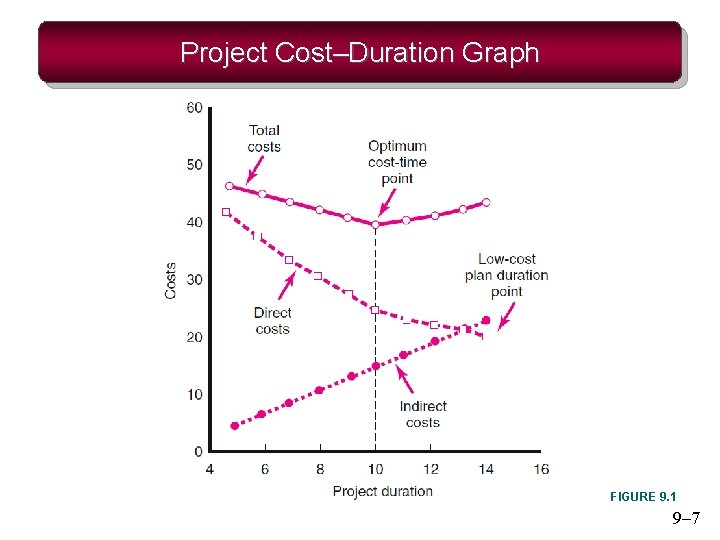

Project Cost–Duration Graph FIGURE 9. 1 9– 7

Project Cost–Duration Graph FIGURE 9. 1 9– 7

Constructing a Project Cost–Duration Graph • Find total direct costs for selected project durations.

Constructing a Project Cost–Duration Graph • Find total direct costs for selected project durations. • Find total indirect costs for selected project durations. • Sum direct and indirect costs for these selected project durations. • Compare additional cost alternatives for benefits. 9– 8

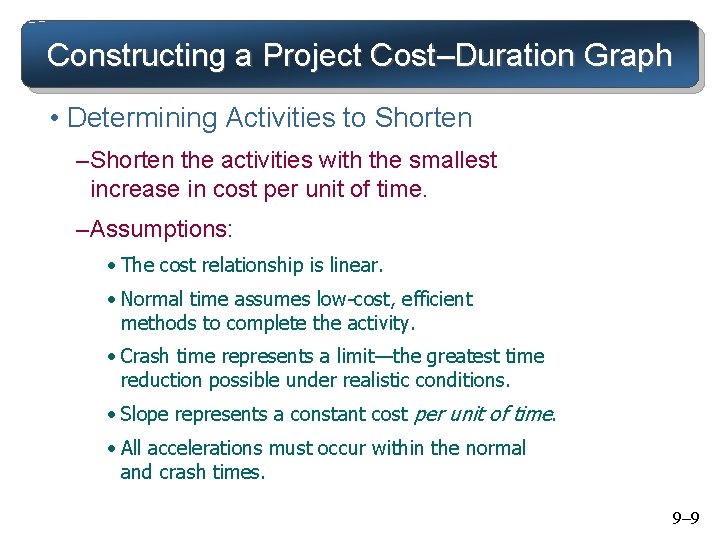

Constructing a Project Cost–Duration Graph • Determining Activities to Shorten – Shorten the activities

Constructing a Project Cost–Duration Graph • Determining Activities to Shorten – Shorten the activities with the smallest increase in cost per unit of time. – Assumptions: • The cost relationship is linear. • Normal time assumes low-cost, efficient methods to complete the activity. • Crash time represents a limit—the greatest time reduction possible under realistic conditions. • Slope represents a constant cost per unit of time. • All accelerations must occur within the normal and crash times. 9– 9

Activity Graph FIGURE 9. 2 9– 10

Activity Graph FIGURE 9. 2 9– 10

Cost–Duration Trade-off Example FIGURE 9. 3 9– 11

Cost–Duration Trade-off Example FIGURE 9. 3 9– 11

Cost–Duration Trade-off Example (cont’d) FIGURE 9. 3 (cont’d) 9– 12

Cost–Duration Trade-off Example (cont’d) FIGURE 9. 3 (cont’d) 9– 12

Cost–Duration Trade-off Example (cont’d) FIGURE 9. 4 9– 13

Cost–Duration Trade-off Example (cont’d) FIGURE 9. 4 9– 13

Cost–Duration Trade-off Example (cont’d) FIGURE 9. 4 (cont’d) 9– 14

Cost–Duration Trade-off Example (cont’d) FIGURE 9. 4 (cont’d) 9– 14

Summary Costs by Duration FIGURE 9. 5 9– 15

Summary Costs by Duration FIGURE 9. 5 9– 15

Project Cost–Duration Graph FIGURE 9. 6 9– 16

Project Cost–Duration Graph FIGURE 9. 6 9– 16

Practical Considerations • Using the Project Cost–Duration Graph – For cost-duration tradeoff decision •

Practical Considerations • Using the Project Cost–Duration Graph – For cost-duration tradeoff decision • Crash Times – It is more difficult to estimate than normal time and cost • Linearity Assumption – However, usually crashing is “all or none. ” It is not as practical to do partial crashing of an activity. • Choice of Activities to Crash Revisited – In addition to choosing the cheapest crashing method, other factors such as risk and resource availability (at the time of need) should be considered as well. • Time Reduction Decisions and Sensitivity – A project is sensitive if it has several critical or near-critical paths. – Compression of projects with several near critical paths reduces scheduling flexibility and increases the risk of delaying the project. 9– 17

What if Cost, Not Time Is the Issue? • Commonly Used Options for Cutting

What if Cost, Not Time Is the Issue? • Commonly Used Options for Cutting Costs – Reduce project scope – Have owner take on more responsibility – Outsourcing project activities or even the entire project – Brainstorming cost savings options 9– 18

Key Terms Crashing Crash point Crash time Direct costs Fast-tracking Indirect costs Outsourcing Project

Key Terms Crashing Crash point Crash time Direct costs Fast-tracking Indirect costs Outsourcing Project cost–duration graph 9– 19
