Bunker Critical Design Review Welcome Charge Shane Kennedy
Bunker Critical Design Review Welcome & Charge Shane Kennedy NSS Project Leader www. europeanspallationsource. se Bunker CDR#2, Medicon Village, 15 th October 2018
NSS Project scope: 15 neutron instruments + test beamline + support labs + NMX D 08 + BEER C-SPEC BIFROST E 04 MIRACLES MAGIC ODIN T-REX DREAM D 07 E 03 Nuclear Physics Institute HEIMDAL Test Beam Line VESPA SKADI + ESS Instrument Layout (September 2017) FREIA LOKI ESTIA D 04 ESS Lead Partners for instrument construction ESS In-Kind Partners also collaborate on sample environment, data management, lab fitout (D 04, D 08, E 03 & E 04) etc.

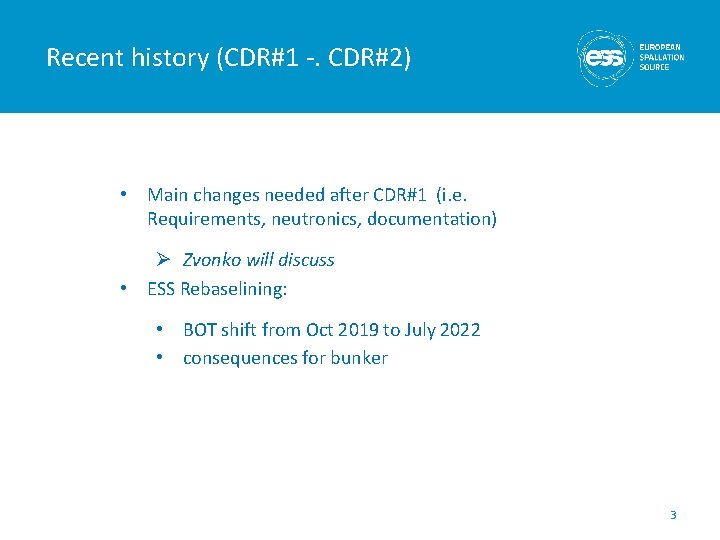

Recent history (CDR#1 -. CDR#2) • Main changes needed after CDR#1 (i. e. Requirements, neutronics, documentation) Ø Zvonko will discuss • ESS Rebaselining: • BOT shift from Oct 2019 to July 2022 • consequences for bunker 3
Rebaseline schedule for Neutron Beam Instruments (V 4. 0, 11 th May 2018) from Installation workshop with teams building First firstaccess 8 Instruments (8 th Start May) User Preliminary Design BOT & start HC of NBI* Current to NSS bldgs (E 01) date Detailed Design Manufacturing & Procurement 8 NBI* in User Program (3 NBI*) Program Installation & Integration Hot Commissioning/Early science Operation Safest instrument choices to West be Ready for SOUP in West sector (BEER, CSPEC, BIFROST sector & MAGIC) & East (ESTIA) Most desirable instrument choices for early science highlights are in the South and North (ODIN, DREAM & LOKI). Selection of first NBI for SOUP in March 2023 Knock-on delays to NBI: 9 – 15 of ~ 1 yr and 16 – 22 of ~ 1 ½ yr * NBI = Neutron Beam Instrument North sector East and South sectors 2016 2017 2018 2019 2020 2021 2022 2023 2024 2025 2026 4
CDR committee members External members: Internal (ESS) Members: • Phil Ferguson (chair), SNS • Tim Broome, STFC • Romuald Hanslik, FZ-Jülich • Masa Arai, Technical Coordinator • François Javier, ESH & Q • Rikard Linander, Target Division 5
Charge for this review meeting Purpose: to assess whether bunker design satisfies all stated design requirements and whether it is defined at a level of detail consistent with release for engineering detailing and manufacturing, according to the procurement/production plan for the project: Specific questions: 1. Are system requirements and interface requirements properly defined and complete? 2. Have safety and hazards been properly considered and addressed? 3. Do the System Design Description documents and related drawings adequately describe the design to the degree needed for fabrication or procurement; as per the project plan? 4. Does the design satisfy the functional and performance requirements? 5. Are the Manufacturing Plan, the Installation Plan, and System Analysis Reports finalized and do they support the stated design? 6
Agenda for CDR (1/3) 7
Agenda for CDR (2/3) 8
Agenda for CDR (3/3) 9
