Biomass Cogeneration Facility Savannah River Site Aiken SC
Biomass Cogeneration Facility Savannah River Site Aiken, SC November 2015 SC Biomass Council Quarterly Meeting
Savannah River Site Project Overview Clean●Green● Sustainable●Steam • • • Project Background & Drivers Project Scope Project Benefits Program Status Construction & Start of Operation • Summary of Operation • Phase 2
Project Background • The existing D-Area Powerhouse was built in 1953 and provides steam to nuclear and industrial activities in F-, H-, and S-Areas. It is a co-generation facility and provides approximately one half (20 MW) of the Site’s electrical demand. 3

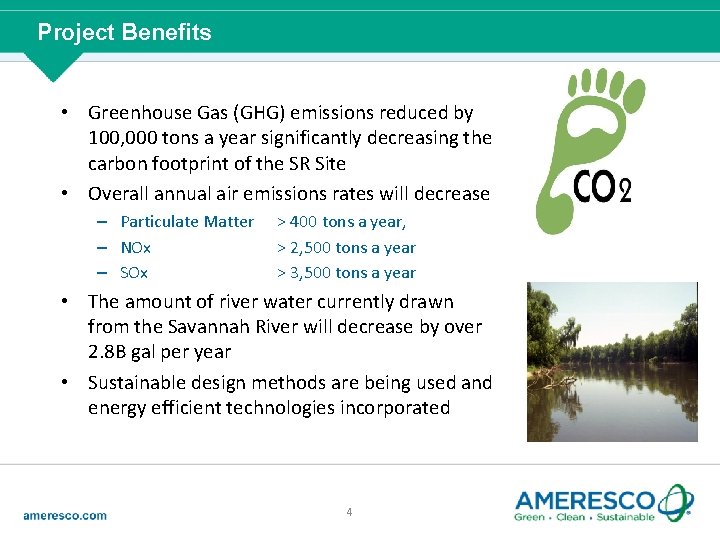

Project Benefits • Greenhouse Gas (GHG) emissions reduced by 100, 000 tons a year significantly decreasing the carbon footprint of the SR Site • Overall annual air emissions rates will decrease – Particulate Matter – NOx – SOx > 400 tons a year, > 2, 500 tons a year > 3, 500 tons a year • The amount of river water currently drawn from the Savannah River will decrease by over 2. 8 B gal per year • Sustainable design methods are being used and energy efficient technologies incorporated 4
September 14, 2009 to January 2012 5
Integrated Project Team • IPT formed in September 2009 • Included CO, FPM, representatives of FRs, Permits, SRNS, technical representatives as required • Held meetings every week for the two-year construction period • Provided input to the IMRT which has met every quarter 6
Truck Off Loading Pad • First footer poured in June 2010 • Three off-loading pads • Dump time is 6 -10 minutes • The hopper holds two loads (80 T wood chips) • 50 trucks per day is about 1 truck load every 15 minutes 7
Stacker Reclaimer • First footer poured in May 2010 • Receives chips from the transfer tower • Holds about 800 truck of wood chips (32 K Tons) • About a 30 day supply at 1 KT per day 8

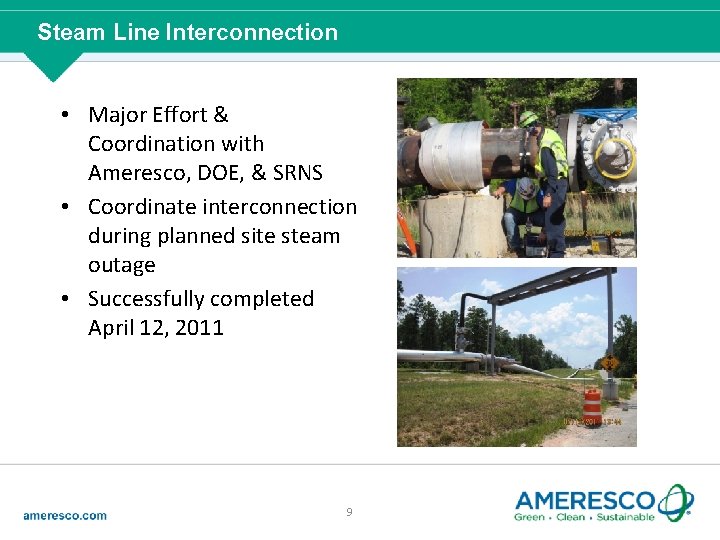

Steam Line Interconnection • Major Effort & Coordination with Ameresco, DOE, & SRNS • Coordinate interconnection during planned site steam outage • Successfully completed April 12, 2011 9

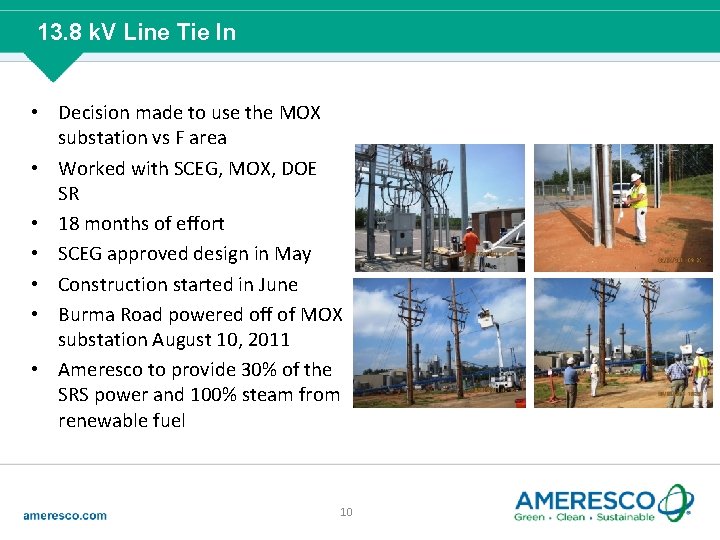

13. 8 k. V Line Tie In • Decision made to use the MOX substation vs F area • Worked with SCEG, MOX, DOE SR • 18 months of effort • SCEG approved design in May • Construction started in June • Burma Road powered off of MOX substation August 10, 2011 • Ameresco to provide 30% of the SRS power and 100% steam from renewable fuel 10

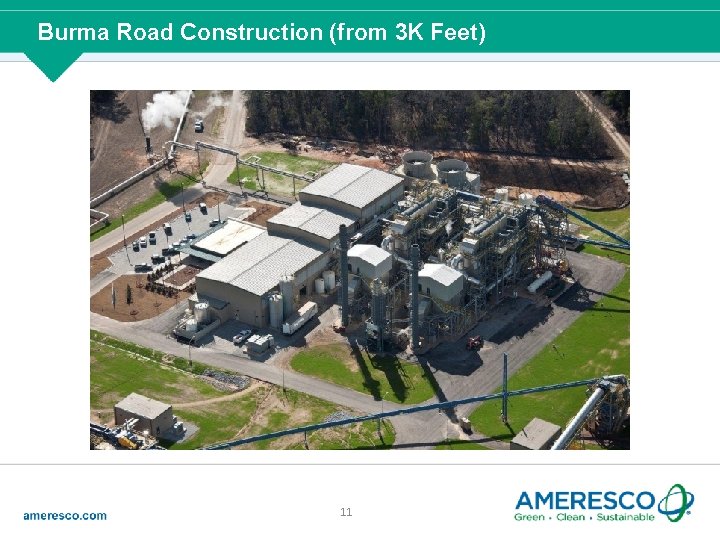

Burma Road Construction (from 3 K Feet) 11
Burma Road Construction Safety 12
Steps of Commissioning & Startup • • 13 Steps of Commissioning & Startup Ameresco System Commissioning of 30 systems Ameresco Equipment Performance Testing DOE–SR Team Readiness Assessment
Project Successes • Construction Status – Over 600, 000 safe manhours – 38 acres of site clearing, 150 K CY of fill, 13, 000 cubic yards of concrete, 812 tons of steel, 42, 000 linear feet of pipe – 750, 000 ft (142 miles) of cable – 200 motors installed – 45 pieces of major equipment procured & installed – 1, 900 instrumentation I/O loops – 150 workers (daily average on site during construction) – Started Operations 2 months ahead of original baseline schedule • Ameresco to provide 30% of the SRS power and 100% steam from renewable fuel by February 2012 • Great Team Effort – Ameresco ● DOE ● SRNS 14
Summary of First 3 Years of Operation • The heating plants were commissioned in October 2010 and went into operation in November 2010 • The main facility was commissioned in 2011 and went into commercial operation in January 2012 • After the first year of operation – main facility has provided 1. 7 billion pounds of steam – 600 million pounds of steam exported to SRS – 97, 000 megawatts of green energy generated to the site electrical grid • After the first three years of operation – the main facility has provided 5. 2 billion pounds of steam – 1. 3 billion pounds of steam exported to SRS – 299, 400 megawatts of green energy generated to the site electrical grid ($23. 9 M) • This program is a great example of private industry and the federal government forming a partnership and working together for success 15
Phase 2 • Getting started 16
Phase 2 Starting site prep – package boiler moved by Dec and biomass by June 2016 17
Advantages of Phase 2 Advantages of the Phase 2 Project • • • Independent source of steam Optimize Power “Hospital start” capability of package boiler Independent source of electrical for phase 2 Package and biomass boilers enclosed inside building Capability to run condensate through the package boiler to help keep in warm stand by 18
Thank you for your time! Nicole Bulgarino Vice President Ken Chacey Ameresco Site Program Manager Doug Bush Operations and Maintenance Manager Clinton (Sandy) Sandmel Safety Manager
