Bim pxp Part deux BIM Project execution plan
Bim pxp Part deux

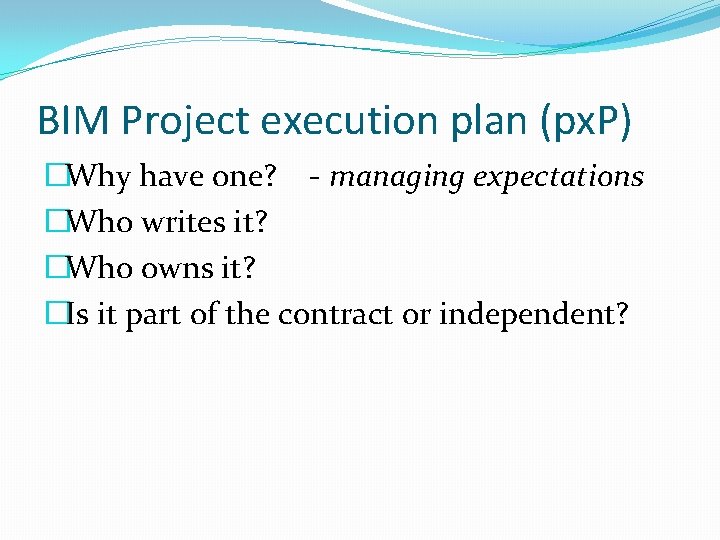

BIM Project execution plan (px. P) �Why have one? - managing expectations �Who writes it? �Who owns it? �Is it part of the contract or independent?

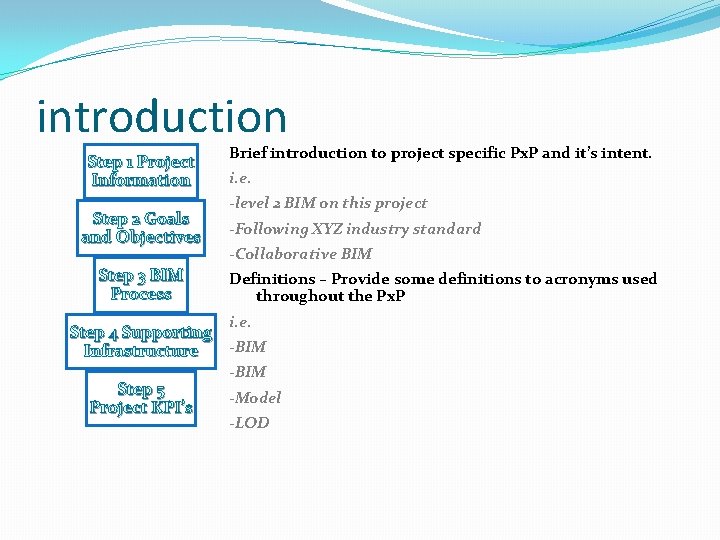

introduction Step 1 Project Information Step 2 Goals and Objectives Step 3 BIM Process Brief introduction to project specific Px. P and it’s intent. i. e. -level 2 BIM on this project -Following XYZ industry standard -Collaborative BIM Definitions – Provide some definitions to acronyms used throughout the Px. P i. e. Step 4 Supporting -BIM Infrastructure Step 5 Project KPI’s -BIM -Model -LOD
Project information Step 1 Project Information Step 2 Goals and Objectives Step 3 BIM Process Step 4 Supporting Infrastructure Step 5 Project KPI’s
Project information BIM Leadership Step 1 Project Information Step 2 Goals and Objectives Step 3 BIM Process Step 4 Supporting Infrastructure Step 5 Project KPI’s

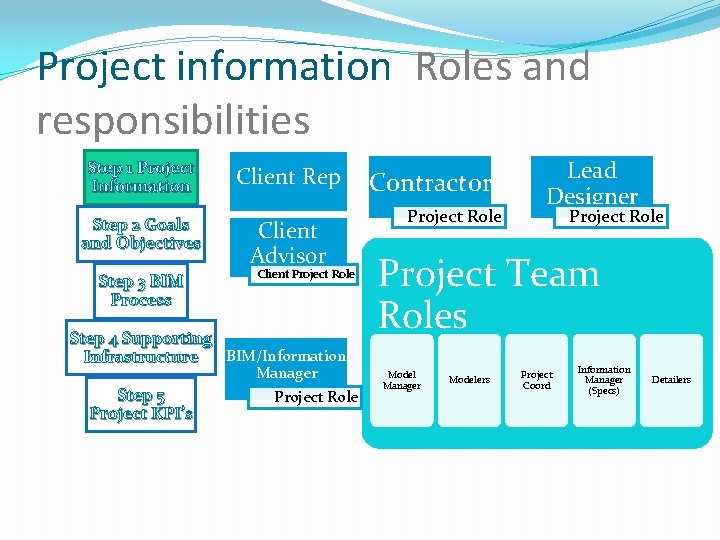

Project information Roles and responsibilities Step 1 Project Information Step 2 Goals and Objectives Step 3 BIM Process Client Rep Client Advisor Client Project Role Step 4 Supporting BIM/Information Infrastructure Manager Step 5 Project KPI’s Project Role Contractor Project Role Lead Designer Project Role Project Team Roles Model Manager Modelers Project Coord Information Manager (Specs) Detailers

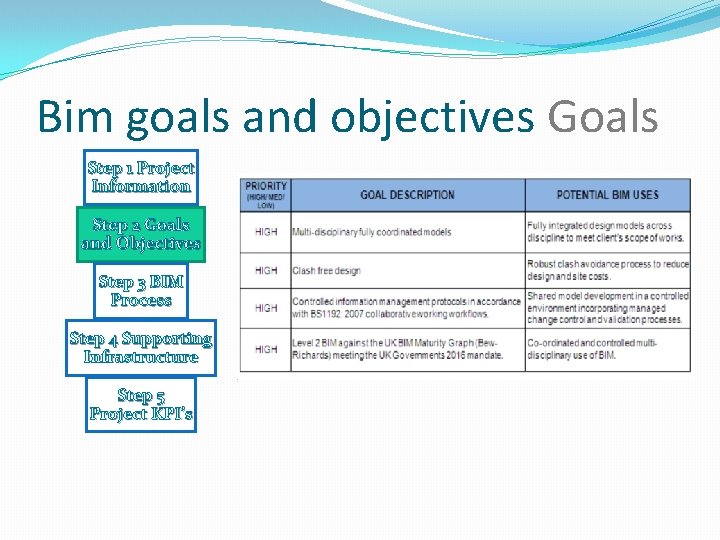

Bim goals and objectives Goals Step 1 Project Information Step 2 Goals and Objectives Step 3 BIM Process Step 4 Supporting Infrastructure Step 5 Project KPI’s

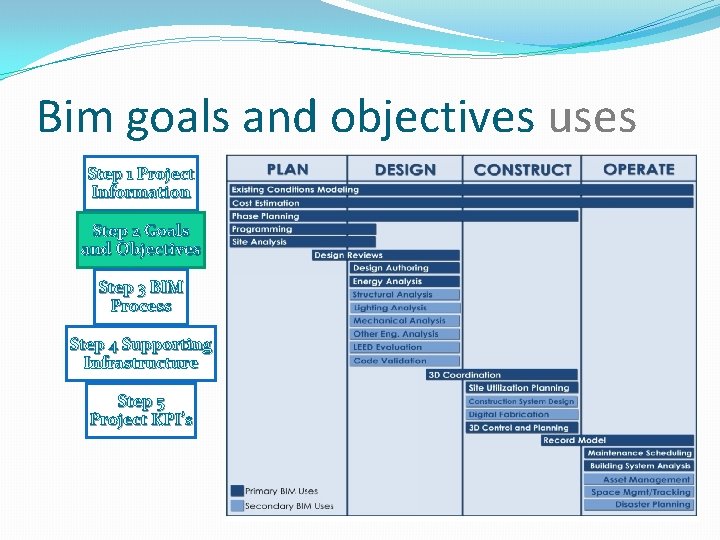

Bim goals and objectives uses Step 1 Project Information Step 2 Goals and Objectives Step 3 BIM Process Step 4 Supporting Infrastructure Step 5 Project KPI’s
Bim goals and objectives phases Step 1 Project Information Step 2 Goals and Objectives Step 3 BIM Process Step 4 Supporting Infrastructure Step 5 Project KPI’s

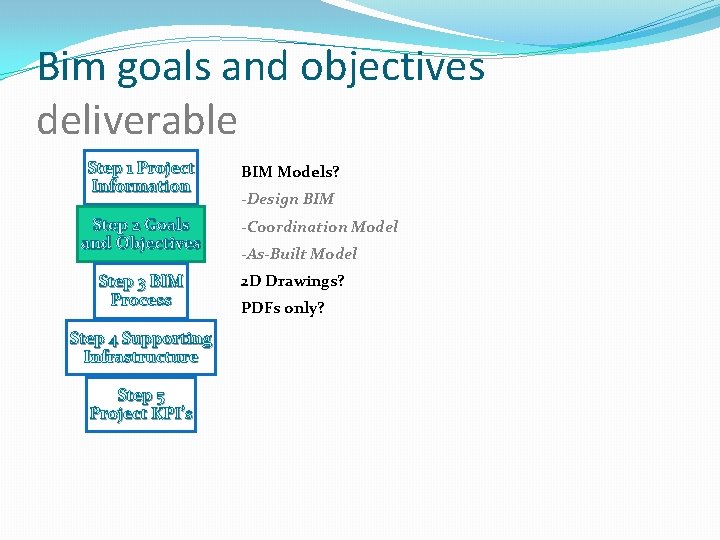

Bim goals and objectives deliverable Step 1 Project Information Step 2 Goals and Objectives Step 3 BIM Process Step 4 Supporting Infrastructure Step 5 Project KPI’s BIM Models? -Design BIM -Coordination Model -As-Built Model 2 D Drawings? PDFs only?

Bim process Step 1 Project Information Step 2 Goals and Objectives Step 3 BIM Process Step 4 Supporting Infrastructure Step 5 Project KPI’s
Bim process Step 1 Project Information Step 2 Goals and Objectives Step 3 BIM Process Step 4 Supporting Infrastructure Step 5 Project KPI’s

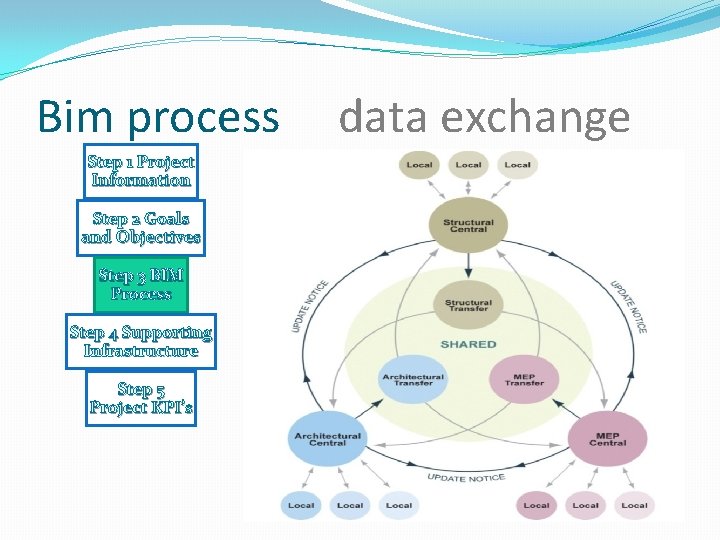

Bim process Step 1 Project Information Step 2 Goals and Objectives Step 3 BIM Process Step 4 Supporting Infrastructure Step 5 Project KPI’s data exchange
Bim process origin Step 1 Project Information Step 2 Goals and Objectives Step 3 BIM Process Step 4 Supporting Infrastructure Step 5 Project KPI’s Project units and Units Project units to be used by all disciplines Origin
Bim process Step 1 Project Information Step 2 Goals and Objectives Step 3 BIM Process Step 4 Supporting Infrastructure Step 5 Project KPI’s model breakdown

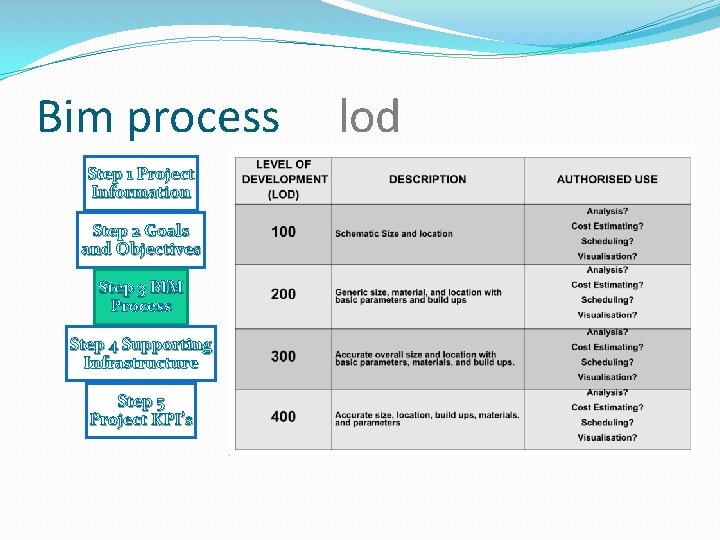

Bim process Step 1 Project Information Step 2 Goals and Objectives Step 3 BIM Process Step 4 Supporting Infrastructure Step 5 Project KPI’s lod

Bim process lod and responsibility matrix Step 1 Project Information Step 2 Goals and Objectives Step 3 BIM Process Step 4 Supporting Infrastructure Step 5 Project KPI’s

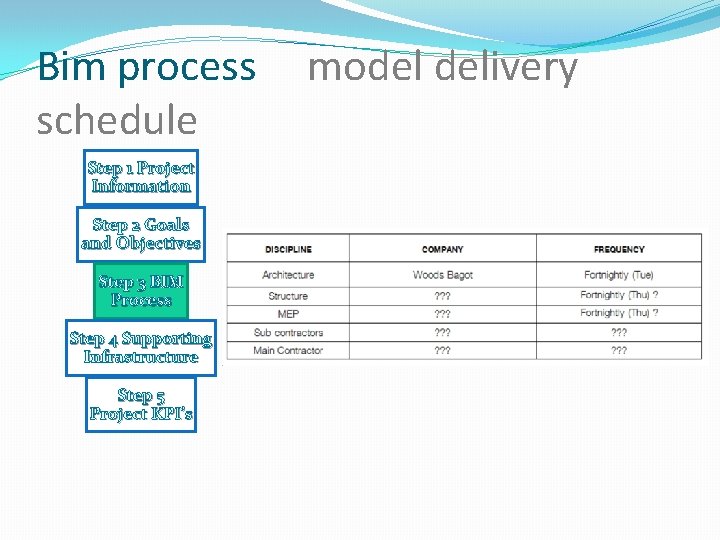

Bim process schedule Step 1 Project Information Step 2 Goals and Objectives Step 3 BIM Process Step 4 Supporting Infrastructure Step 5 Project KPI’s model delivery
Bim process Step 1 Project Information Step 2 Goals and Objectives Step 3 BIM Process Step 4 Supporting Infrastructure Step 5 Project KPI’s meetings
Bim process Step 1 Project Information Step 2 Goals and Objectives Step 3 BIM Process Step 4 Supporting Infrastructure Step 5 Project KPI’s coordination 3 D BIM to 3 D BIM Link using shared coordinates 2 D DWG to 3 D BIM Link using shared coordinates Clash Detection How? When? Using Navis/Revit Visual/Manual or Automatic Clash Reporting How? Email? Via web? Word/Excel?
Bim process Step 1 Project Information Step 2 Goals and Objectives Step 3 BIM Process Step 4 Supporting Infrastructure Step 5 Project KPI’s model management Project Model Manager Initial Responsibilities i. e. -Establish model origin/orientation/units -Establish LOD/modelling protocol On-going Responsibilities i. e. -Collect incoming models -Validate files are compliant and usable -Release to team
Bim process validation Step 1 Project Information Step 2 Goals and Objectives Step 3 BIM Process Step 4 Supporting Infrastructure Step 5 Project KPI’s qa check – model
Bim process validation Step 1 Project Information Step 2 Goals and Objectives Step 3 BIM Process Step 4 Supporting Infrastructure Step 5 Project KPI’s qa check – model • Ensure model aligns spatially • Model does not contain other discipline design information • Remove any unused links or attachments • Purge out all relevant unwanted items • Compact/compress files • Audit using software auditing tools • CAD Standards check • Model file naming conforms to project protocols
Bim process software specific bim protocol Step 1 Project Information Step 2 Goals and Objectives Step 3 BIM Process Step 4 Supporting Infrastructure Step 5 Project KPI’s • Establish standard worksets in discipline models • Establish 3 D DWG Export - shared coordinates • Establish 2 D DWG Export – Export from plan views and shared coordinates • Elevation/Sections/Details from SHEETS

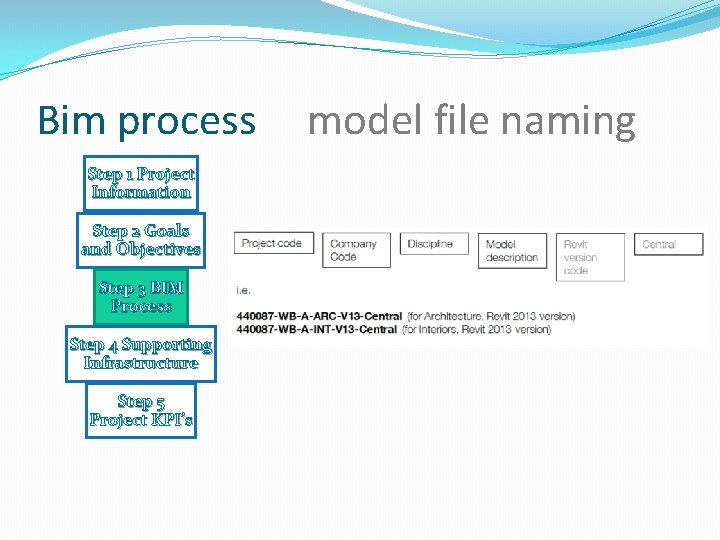

Bim process Step 1 Project Information Step 2 Goals and Objectives Step 3 BIM Process Step 4 Supporting Infrastructure Step 5 Project KPI’s model file naming

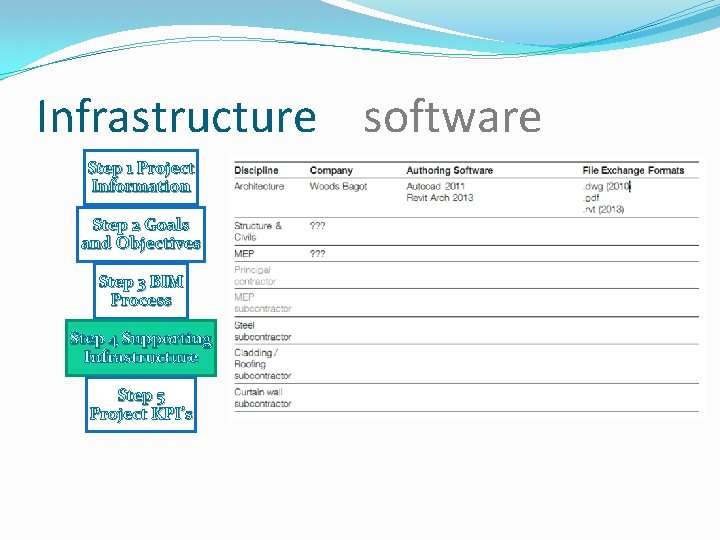

Infrastructure software Step 1 Project Information Step 2 Goals and Objectives Step 3 BIM Process Step 4 Supporting Infrastructure Step 5 Project KPI’s

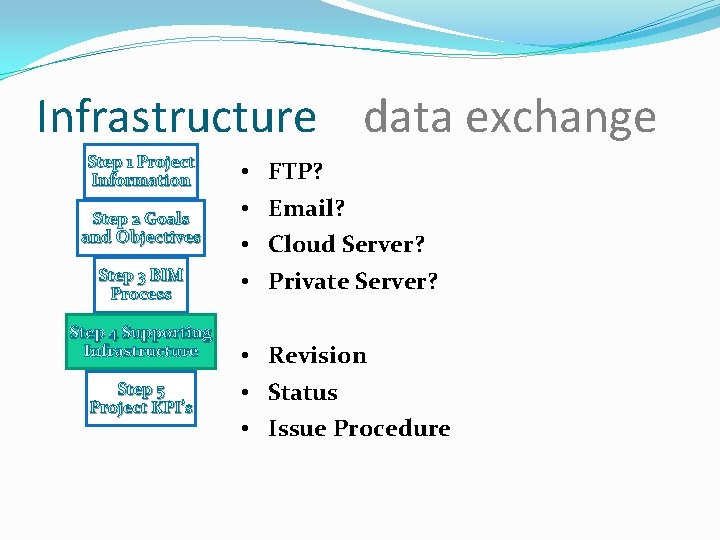

Infrastructure data exchange Step 1 Project Information Step 2 Goals and Objectives Step 3 BIM Process Step 4 Supporting Infrastructure Step 5 Project KPI’s • FTP? • Email? • Cloud Server? • Private Server? • Revision • Status • Issue Procedure
Infrastructure communication Step 1 Project Information Step 2 Goals and Objectives Step 3 BIM Process Step 4 Supporting Infrastructure Step 5 Project KPI’s Define general communication protocols i. e. Email? Webex? Project Management Software? Skype?

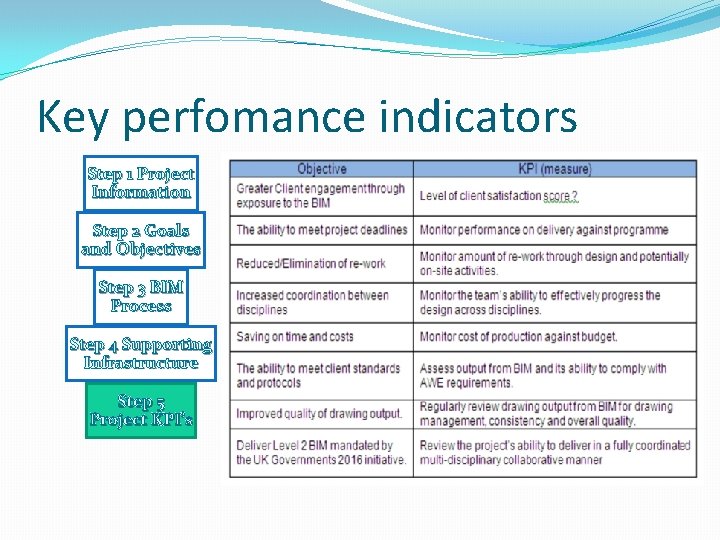

Key perfomance indicators Step 1 Project Information Step 2 Goals and Objectives Step 3 BIM Process Step 4 Supporting Infrastructure Step 5 Project KPI’s

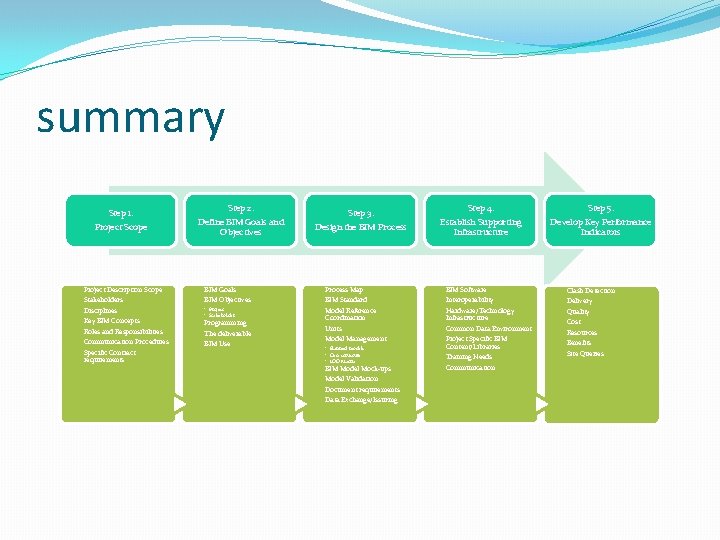

summary Step 1. Project Scope Step 2. Define BIM Goals and Objectives Step 3. Design the BIM Process Step 4. Establish Supporting Infrastructure Step 5. Develop Key Performance Indicators Project Description Scope BIM Goals Process Map BIM Software Clash Detection Stakeholders BIM Objectives BIM Standard Interoperability Delivery Disciplines Key BIM Concepts Roles and Responsibilities Communication Procedures • Project • Stakeholder Model Reference Coordination Units Model Management Hardware/Technology Infrastructure Common Data Environment Project Specific BIM Content/Libraries Training Needs Communication Quality Cost Resources Benefits Specific Contract requirements Programming The deliverable BIM Use • Planned models • Data structure • LOD Matrix BIM Model Mock-ups Model Validation Document requirements Data Exchange/Issuring Site Queries
