Beam dump activities during LS 2 Point 1
Beam dump activities during LS 2 Point 1 and Point 5 J. MEIGNAN EN-ACE-OSS 17/10/2018

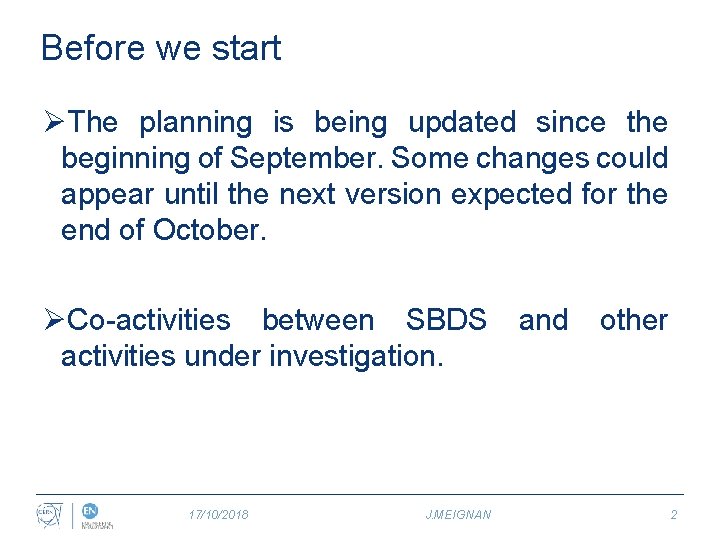

Before we start ØThe planning is being updated since the beginning of September. Some changes could appear until the next version expected for the end of October. ØCo-activities between SBDS activities under investigation. 17/10/2018 J. MEIGNAN and other 2

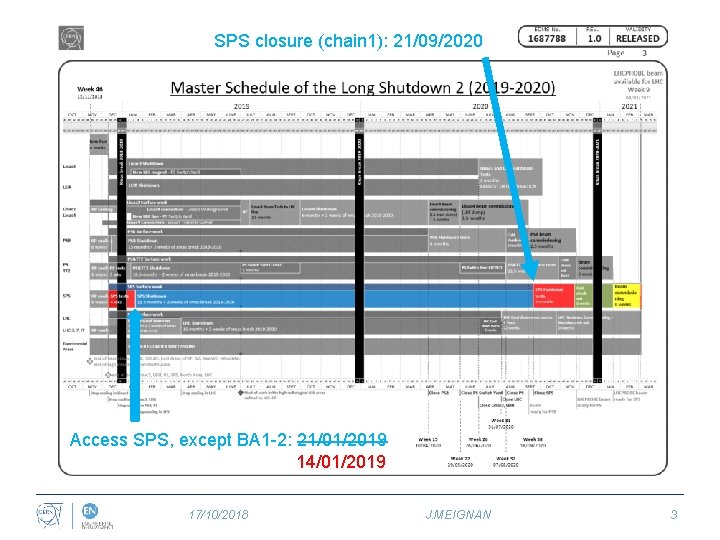

SPS closure (chain 1): 21/09/2020 Access SPS, except BA 1 -2: 21/01/2019 14/01/2019 17/10/2018 J. MEIGNAN 3

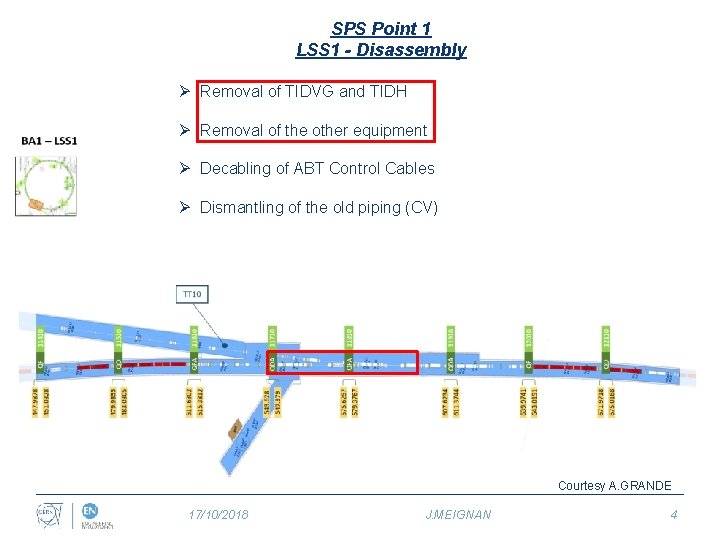

SPS Point 1 LSS 1 - Disassembly Ø Removal of TIDVG and TIDH Ø Removal of the other equipment Ø Decabling of ABT Control Cables Ø Dismantling of the old piping (CV) Courtesy A. GRANDE 17/10/2018 J. MEIGNAN 4

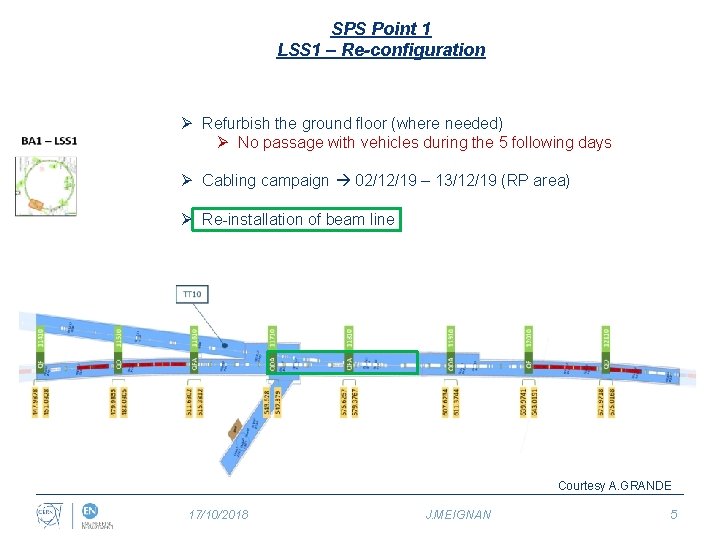

SPS Point 1 LSS 1 – Re-configuration Ø Refurbish the ground floor (where needed) Ø No passage with vehicles during the 5 following days Ø Cabling campaign 02/12/19 – 13/12/19 (RP area) Ø Re-installation of beam line Courtesy A. GRANDE 17/10/2018 J. MEIGNAN 5

SPS Point 1 Summary • No co-activity in the same area 17/10/2018 J. MEIGNAN 6

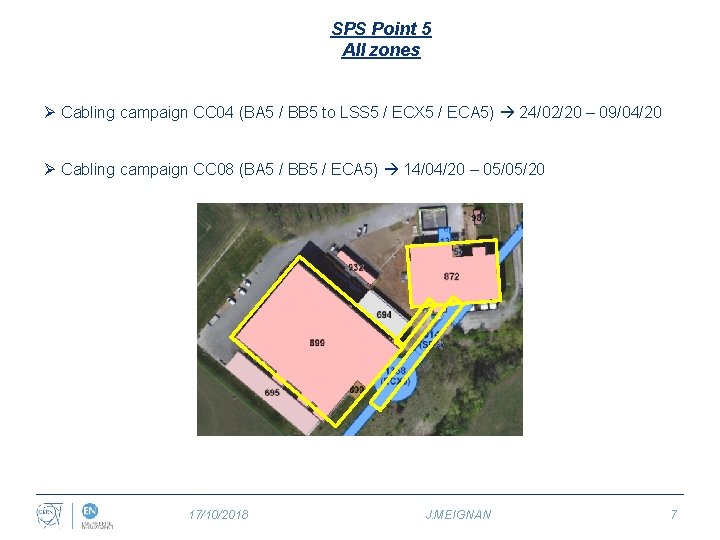

SPS Point 5 All zones Ø Cabling campaign CC 04 (BA 5 / BB 5 to LSS 5 / ECX 5 / ECA 5) 24/02/20 – 09/04/20 Ø Cabling campaign CC 08 (BA 5 / BB 5 / ECA 5) 14/04/20 – 05/05/20 17/10/2018 J. MEIGNAN 7

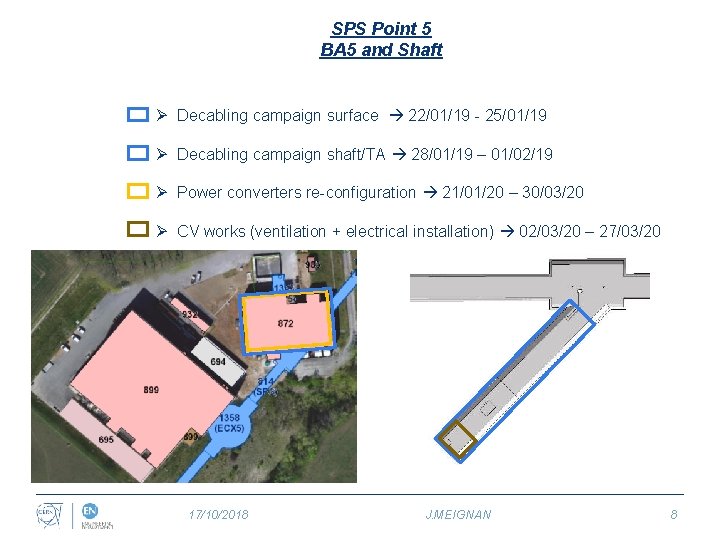

SPS Point 5 BA 5 and Shaft Ø Decabling campaign surface 22/01/19 - 25/01/19 Ø Decabling campaign shaft/TA 28/01/19 – 01/02/19 Ø Power converters re-configuration 21/01/20 – 30/03/20 Ø CV works (ventilation + electrical installation) 02/03/20 – 27/03/20 17/10/2018 J. MEIGNAN 8

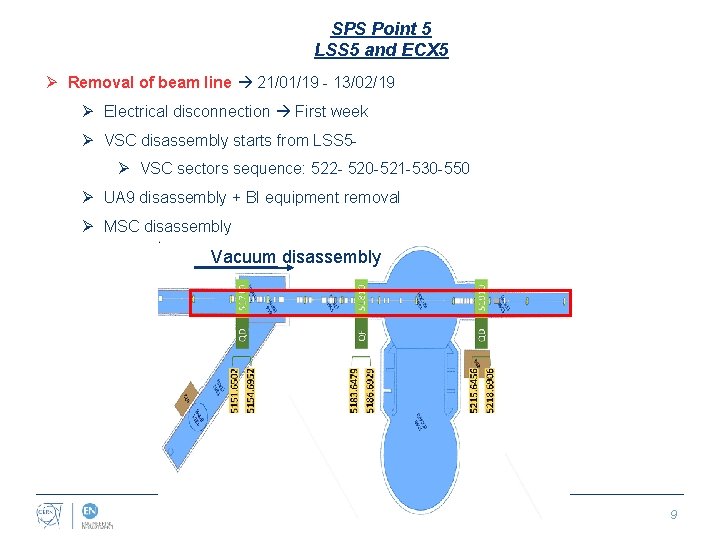

SPS Point 5 LSS 5 and ECX 5 Ø Removal of beam line 21/01/19 - 13/02/19 Ø Electrical disconnection First week Ø VSC disassembly starts from LSS 5Ø VSC sectors sequence: 522 - 520 -521 -530 -550 Ø UA 9 disassembly + BI equipment removal Ø MSC disassembly Vacuum disassembly 17/10/2018 J. MEIGNAN 9

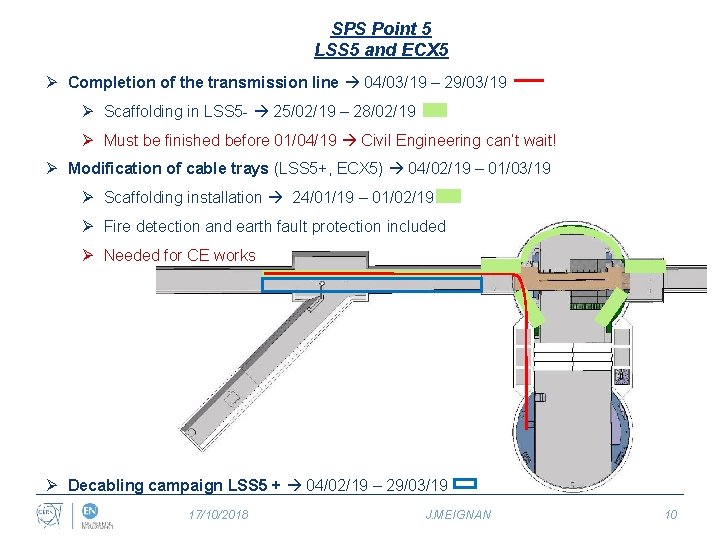

SPS Point 5 LSS 5 and ECX 5 Ø Completion of the transmission line 04/03/19 – 29/03/19 Ø Scaffolding in LSS 5 - 25/02/19 – 28/02/19 Ø Must be finished before 01/04/19 Civil Engineering can’t wait! Ø Modification of cable trays (LSS 5+, ECX 5) 04/02/19 – 01/03/19 Ø Scaffolding installation 24/01/19 – 01/02/19 Ø Fire detection and earth fault protection included Ø Needed for CE works Ø Decabling campaign LSS 5 + 04/02/19 – 29/03/19 17/10/2018 J. MEIGNAN 10

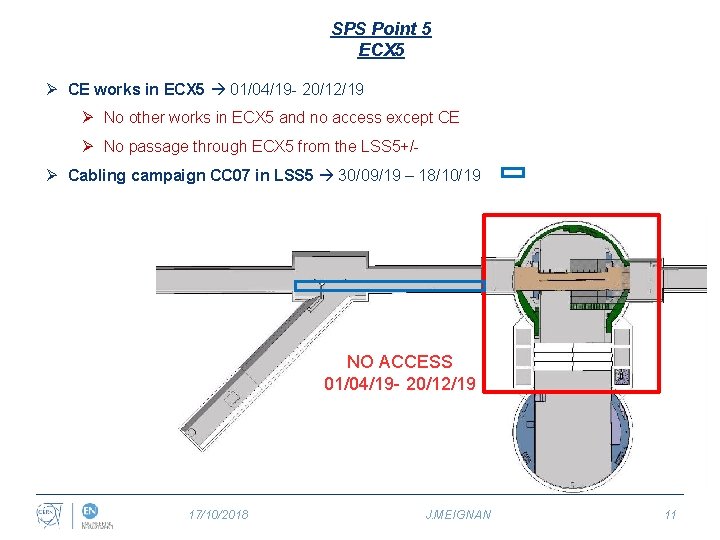

SPS Point 5 ECX 5 Ø CE works in ECX 5 01/04/19 - 20/12/19 Ø No other works in ECX 5 and no access except CE Ø No passage through ECX 5 from the LSS 5+/Ø Cabling campaign CC 07 in LSS 5 30/09/19 – 18/10/19 NO ACCESS 01/04/19 - 20/12/19 17/10/2018 J. MEIGNAN 11

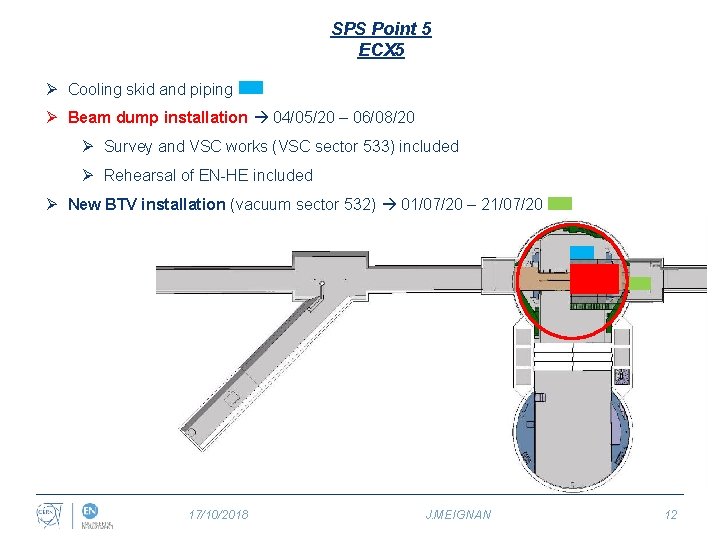

SPS Point 5 ECX 5 Ø Cooling skid and piping Ø Beam dump installation 04/05/20 – 06/08/20 Ø Survey and VSC works (VSC sector 533) included Ø Rehearsal of EN-HE included Ø New BTV installation (vacuum sector 532) 01/07/20 – 21/07/20 17/10/2018 J. MEIGNAN 12

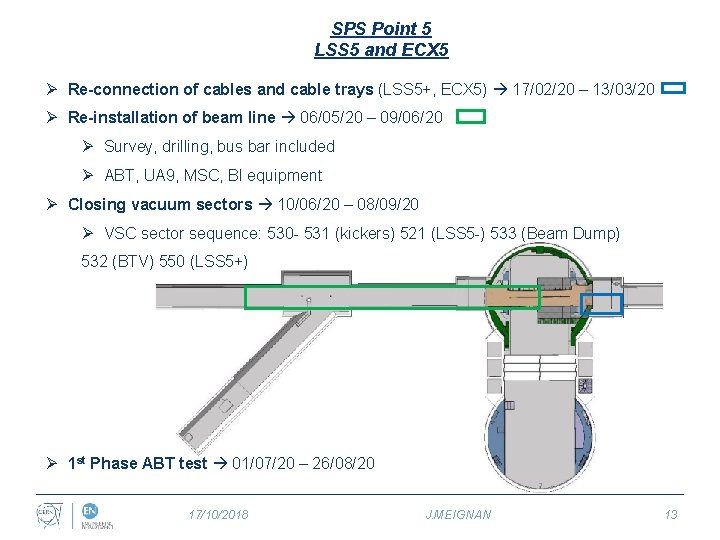

SPS Point 5 LSS 5 and ECX 5 Ø Re-connection of cables and cable trays (LSS 5+, ECX 5) 17/02/20 – 13/03/20 Ø Re-installation of beam line 06/05/20 – 09/06/20 Ø Survey, drilling, bus bar included Ø ABT, UA 9, MSC, BI equipment Ø Closing vacuum sectors 10/06/20 – 08/09/20 Ø VSC sector sequence: 530 - 531 (kickers) 521 (LSS 5 -) 533 (Beam Dump) 532 (BTV) 550 (LSS 5+) Ø 1 st Phase ABT test 01/07/20 – 26/08/20 17/10/2018 J. MEIGNAN 13

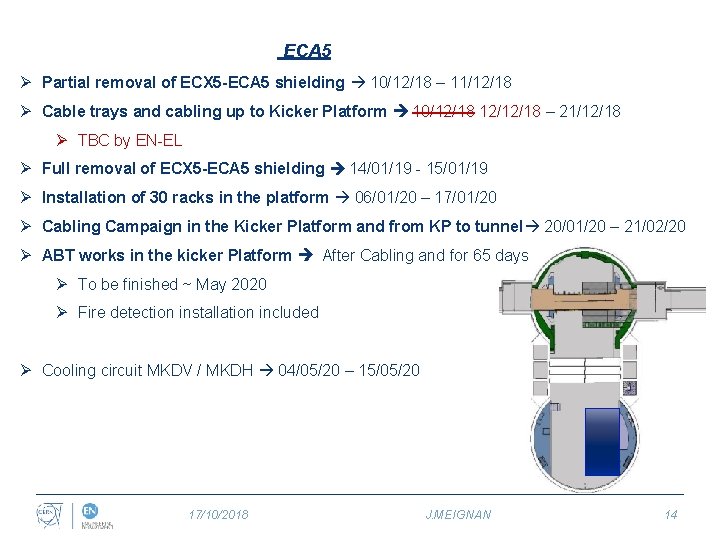

ECA 5 Ø Partial removal of ECX 5 -ECA 5 shielding 10/12/18 – 11/12/18 Ø Cable trays and cabling up to Kicker Platform 10/12/18 12/12/18 – 21/12/18 Ø TBC by EN-EL Ø Full removal of ECX 5 -ECA 5 shielding 14/01/19 - 15/01/19 Ø Installation of 30 racks in the platform 06/01/20 – 17/01/20 Ø Cabling Campaign in the Kicker Platform and from KP to tunnel 20/01/20 – 21/02/20 Ø ABT works in the kicker Platform After Cabling and for 65 days Ø To be finished ~ May 2020 Ø Fire detection installation included Ø Cooling circuit MKDV / MKDH 04/05/20 – 15/05/20 17/10/2018 J. MEIGNAN 14

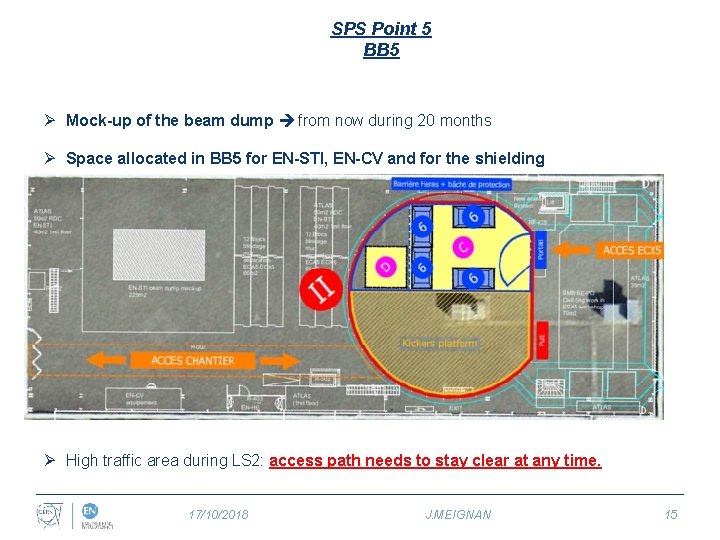

SPS Point 5 BB 5 Ø Mock-up of the beam dump from now during 20 months Ø Space allocated in BB 5 for EN-STI, EN-CV and for the shielding Ø High traffic area during LS 2: access path needs to stay clear at any time. 17/10/2018 J. MEIGNAN 15

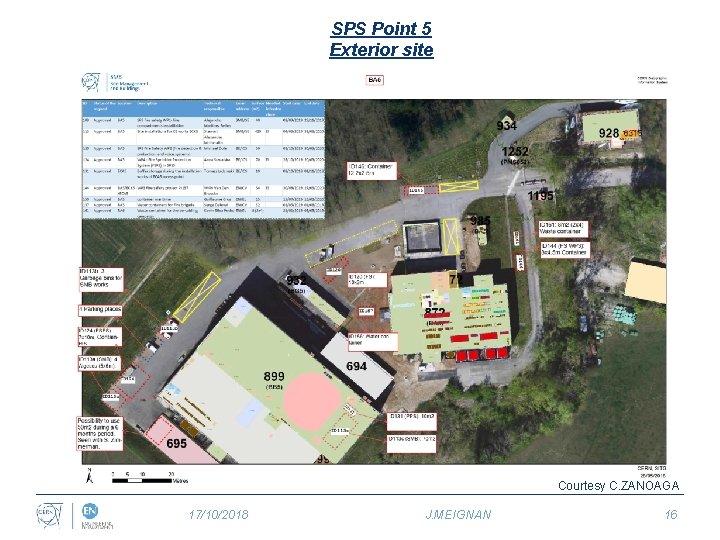

SPS Point 5 Exterior site Courtesy C. ZANOAGA 17/10/2018 J. MEIGNAN 16

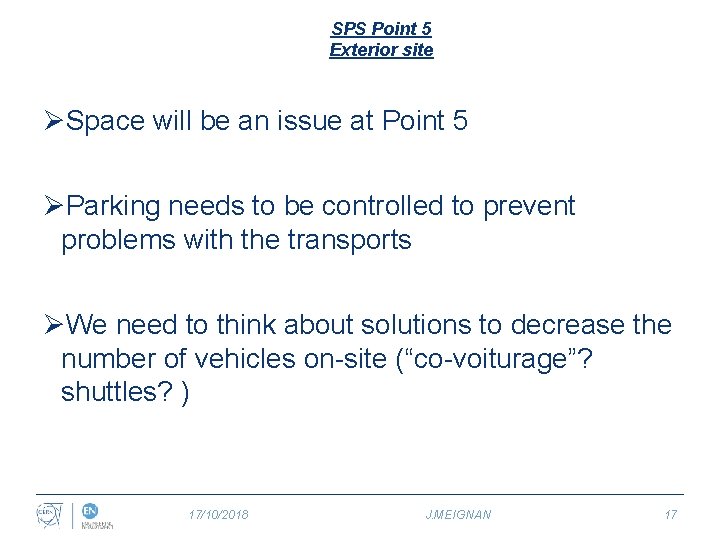

SPS Point 5 Exterior site ØSpace will be an issue at Point 5 ØParking needs to be controlled to prevent problems with the transports ØWe need to think about solutions to decrease the number of vehicles on-site (“co-voiturage”? shuttles? ) 17/10/2018 J. MEIGNAN 17

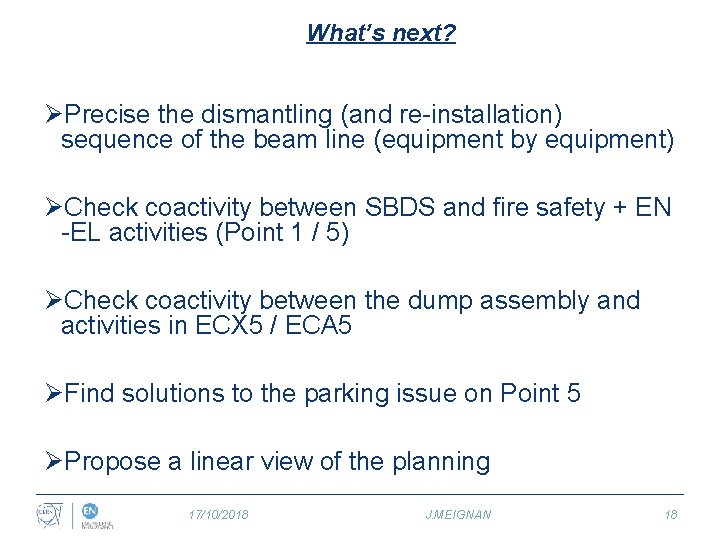

What’s next? ØPrecise the dismantling (and re-installation) sequence of the beam line (equipment by equipment) ØCheck coactivity between SBDS and fire safety + EN -EL activities (Point 1 / 5) ØCheck coactivity between the dump assembly and activities in ECX 5 / ECA 5 ØFind solutions to the parking issue on Point 5 ØPropose a linear view of the planning 17/10/2018 J. MEIGNAN 18

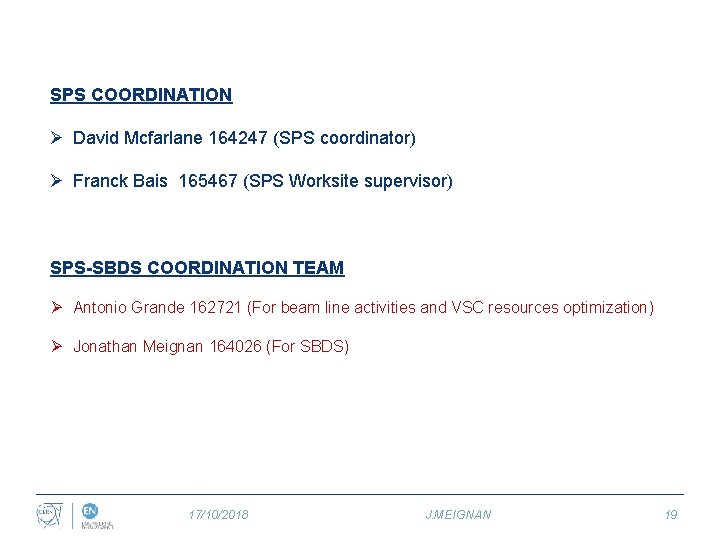

SPS COORDINATION Ø David Mcfarlane 164247 (SPS coordinator) Ø Franck Bais 165467 (SPS Worksite supervisor) SPS-SBDS COORDINATION TEAM Ø Antonio Grande 162721 (For beam line activities and VSC resources optimization) Ø Jonathan Meignan 164026 (For SBDS) 17/10/2018 J. MEIGNAN 19
Thanks for your attention! Any questions?
