Applying Management Tools to a Project Work Breakdown
Applying Management Tools to a Project Work Breakdown Structure

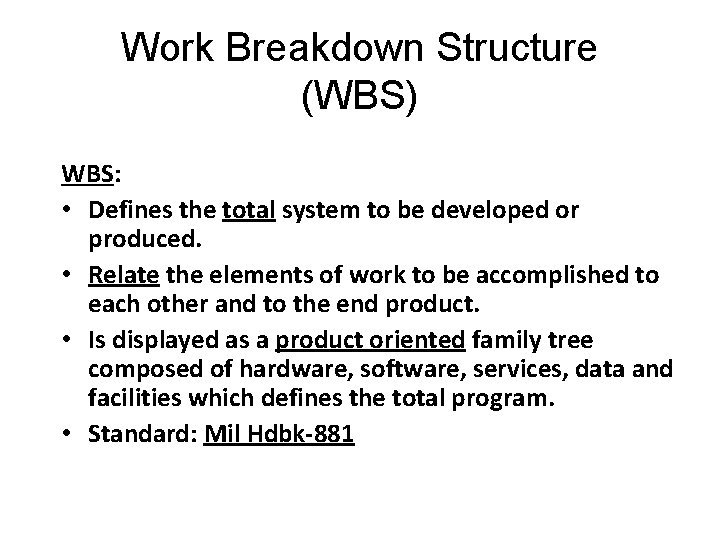

Work Breakdown Structure (WBS) WBS: • Defines the total system to be developed or produced. • Relate the elements of work to be accomplished to each other and to the end product. • Is displayed as a product oriented family tree composed of hardware, software, services, data and facilities which defines the total program. • Standard: Mil Hdbk-881

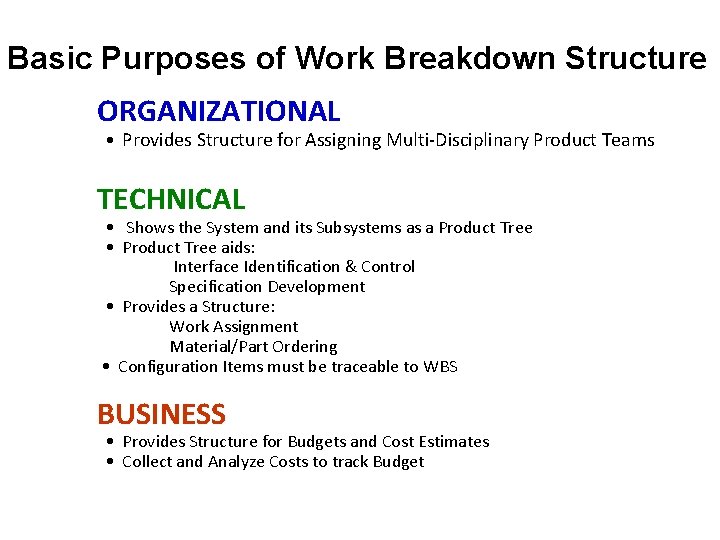

Basic Purposes of Work Breakdown Structure ORGANIZATIONAL • Provides Structure for Assigning Multi-Disciplinary Product Teams TECHNICAL • Shows the System and its Subsystems as a Product Tree • Product Tree aids: Interface Identification & Control Specification Development • Provides a Structure: Work Assignment Material/Part Ordering • Configuration Items must be traceable to WBS BUSINESS • Provides Structure for Budgets and Cost Estimates • Collect and Analyze Costs to track Budget

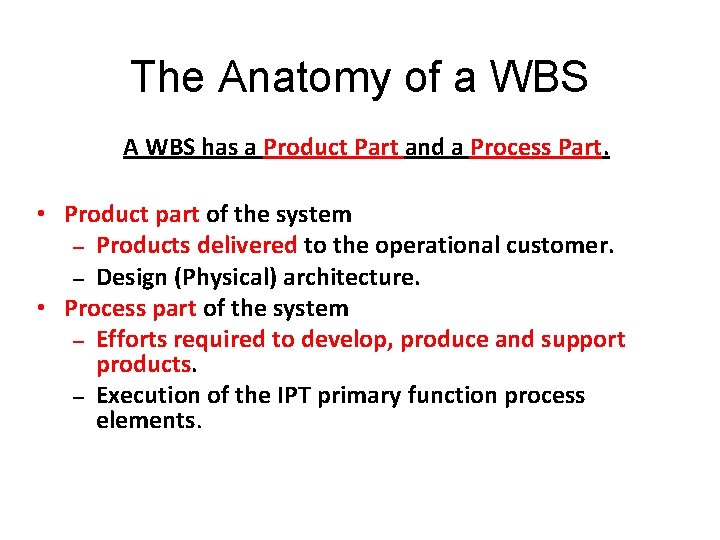

The Anatomy of a WBS A WBS has a Product Part and a Process Part. • Product part of the system – Products delivered to the operational customer. – Design (Physical) architecture. • Process part of the system – Efforts required to develop, produce and support products. – Execution of the IPT primary function process elements.

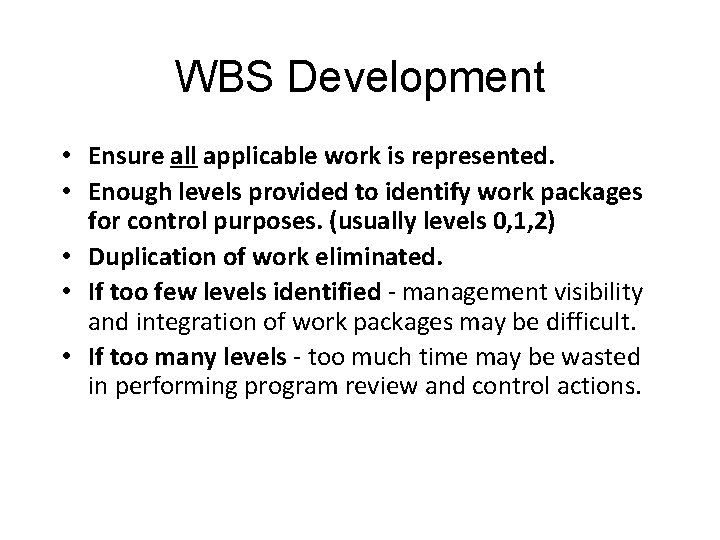

WBS Development • Ensure all applicable work is represented. • Enough levels provided to identify work packages for control purposes. (usually levels 0, 1, 2) • Duplication of work eliminated. • If too few levels identified - management visibility and integration of work packages may be difficult. • If too many levels - too much time may be wasted in performing program review and control actions.

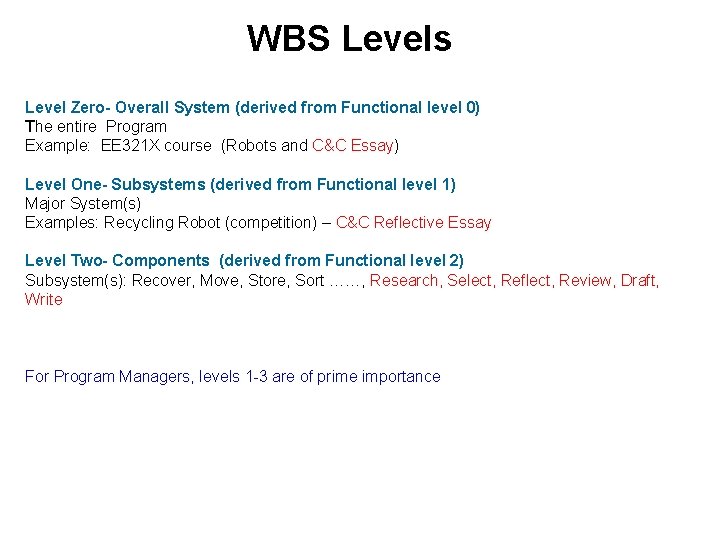

WBS Levels Level Zero- Overall System (derived from Functional level 0) The entire Program Example: EE 321 X course (Robots and C&C Essay) Level One- Subsystems (derived from Functional level 1) Major System(s) Examples: Recycling Robot (competition) – C&C Reflective Essay Level Two- Components (derived from Functional level 2) Subsystem(s): Recover, Move, Store, Sort ……, Research, Select, Reflect, Review, Draft, Write For Program Managers, levels 1 -3 are of prime importance

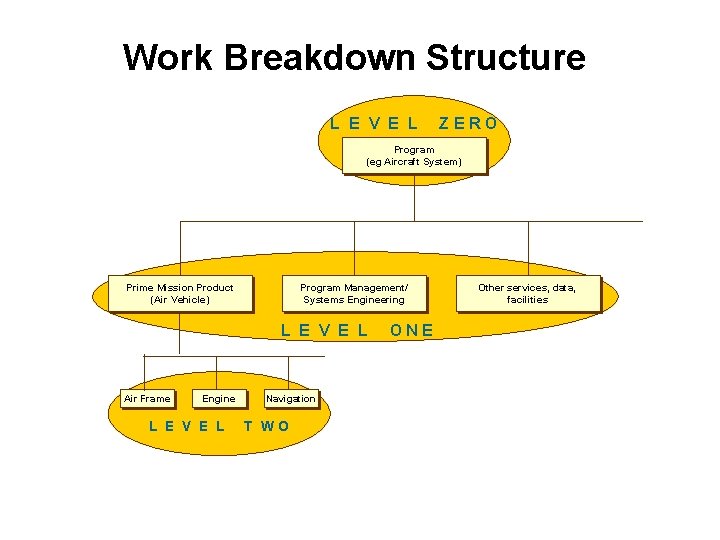

Work Breakdown Structure L E V E L ZERO Program (eg Aircraft System) Prime Mission Product (Air Vehicle) Program Management/ Systems Engineering L E V E L Air Frame Engine L E V E L Navigation T WO ONE Other services, data, facilities

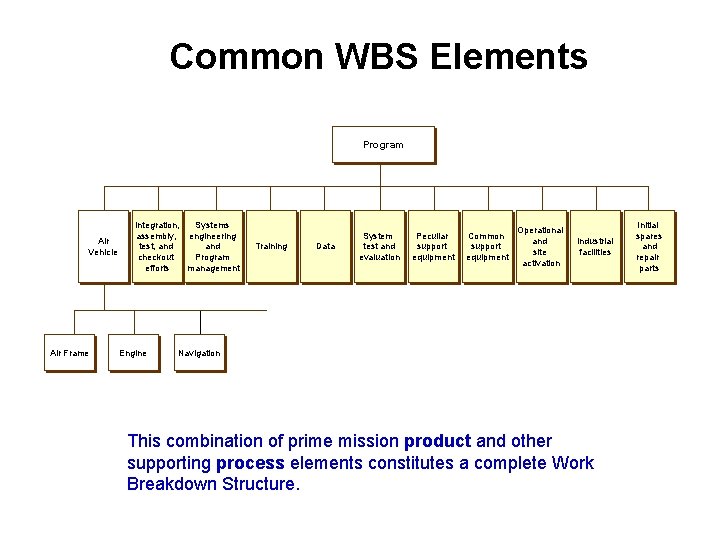

Common WBS Elements Program Air Vehicle Air Frame Integration, Systems assembly, engineering test, and checkout Program efforts management Engine Training Data System test and evaluation Peculiar support equipment Common support equipment Operational and site activation Industrial facilities Navigation This combination of prime mission product and other supporting process elements constitutes a complete Work Breakdown Structure. Initial spares and repair parts

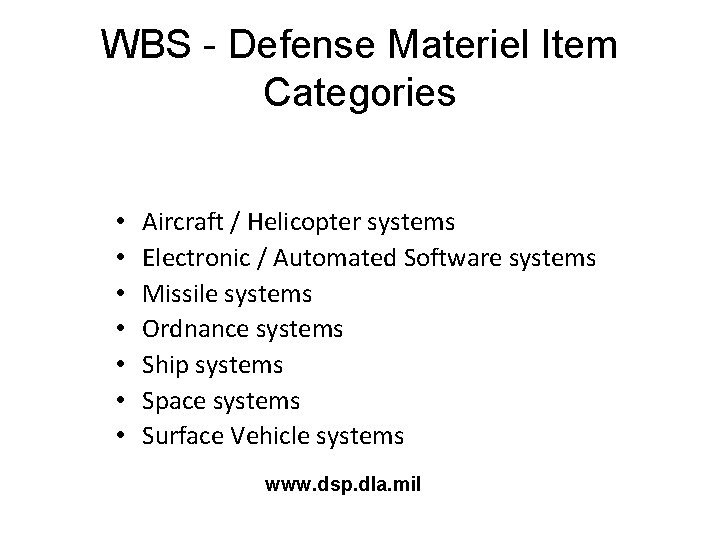

WBS - Defense Materiel Item Categories • • Aircraft / Helicopter systems Electronic / Automated Software systems Missile systems Ordnance systems Ship systems Space systems Surface Vehicle systems www. dsp. dla. mil

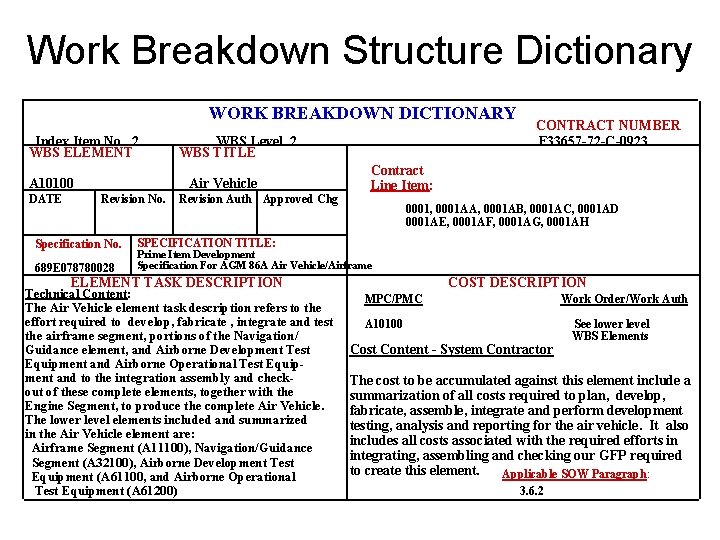

Work Breakdown Structure Dictionary WORK BREAKDOWN DICTIONARY Index Item No. 2 WBS ELEMENT A 10100 DATE WBS Level 2 WBS TITLE Air Vehicle Revision No. Specification No. 689 E 078780028 Revision Auth Approved Chg CONTRACT NUMBER F 33657 -72 -C-0923 Contract Line Item: 0001, 0001 AA, 0001 AB, 0001 AC, 0001 AD 0001 AE, 0001 AF, 0001 AG, 0001 AH SPECIFICATION TITLE: Prime Item Development Specification For AGM 86 A Air Vehicle/Airframe ELEMENT TASK DESCRIPTION Technical Content: The Air Vehicle element task description refers to the effort required to develop, fabricate , integrate and test the airframe segment, portions of the Navigation/ Guidance element, and Airborne Development Test Equipment and Airborne Operational Test Equipment and to the integration assembly and checkout of these complete elements, together with the Engine Segment, to produce the complete Air Vehicle. The lower level elements included and summarized in the Air Vehicle element are: Airframe Segment (A 11100), Navigation/Guidance Segment (A 32100), Airborne Development Test Equipment (A 61100, and Airborne Operational Test Equipment (A 61200) COST DESCRIPTION MPC/PMC Work Order/Work Auth A 10100 Cost Content - System Contractor See lower level WBS Elements The cost to be accumulated against this element include a summarization of all costs required to plan, develop, fabricate, assemble, integrate and perform development testing, analysis and reporting for the air vehicle. It also includes all costs associated with the required efforts in integrating, assembling and checking our GFP required to create this element. Applicable SOW Paragraph: 3. 6. 2

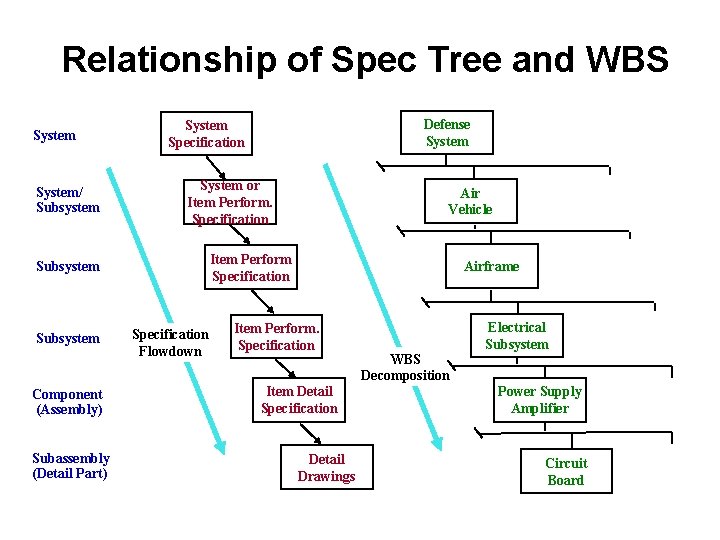

Relationship of Spec Tree and WBS System/ Subsystem System or Item Perform. Specification Component (Assembly) Subassembly (Detail Part) Air Vehicle Item Perform Specification Subsystem Defense System Specification Flowdown Airframe Item Perform. Specification Item Detail Specification Detail Drawings WBS Decomposition Electrical Subsystem Power Supply Amplifier Circuit Board

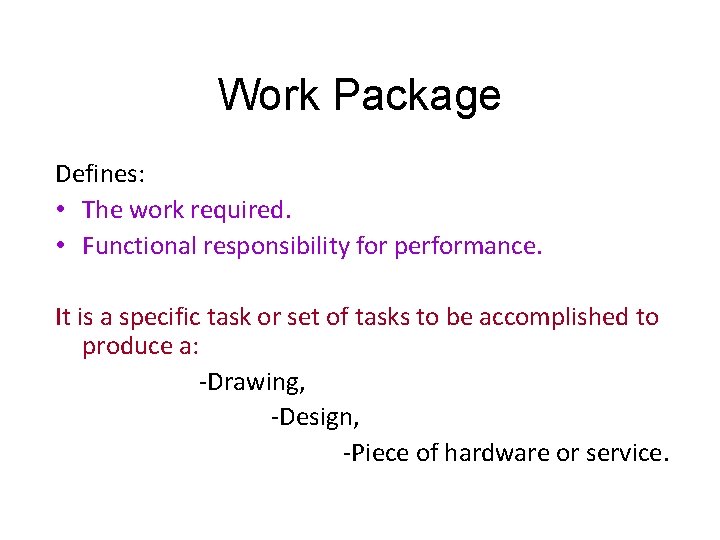

Work Package Defines: • The work required. • Functional responsibility for performance. It is a specific task or set of tasks to be accomplished to produce a: -Drawing, -Design, -Piece of hardware or service.

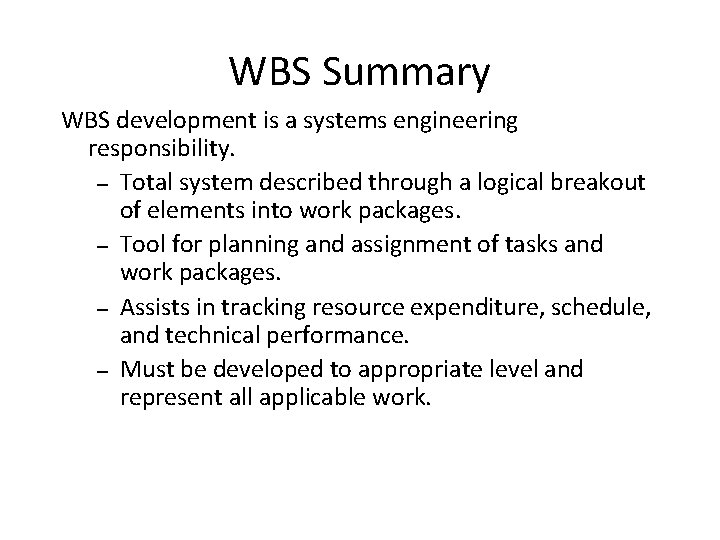

WBS Summary WBS development is a systems engineering responsibility. – Total system described through a logical breakout of elements into work packages. – Tool for planning and assignment of tasks and work packages. – Assists in tracking resource expenditure, schedule, and technical performance. – Must be developed to appropriate level and represent all applicable work.

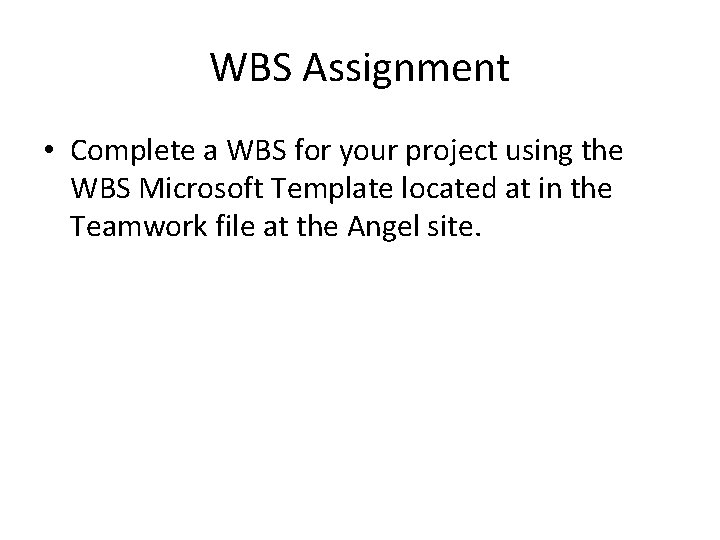

WBS Assignment • Complete a WBS for your project using the WBS Microsoft Template located at in the Teamwork file at the Angel site.

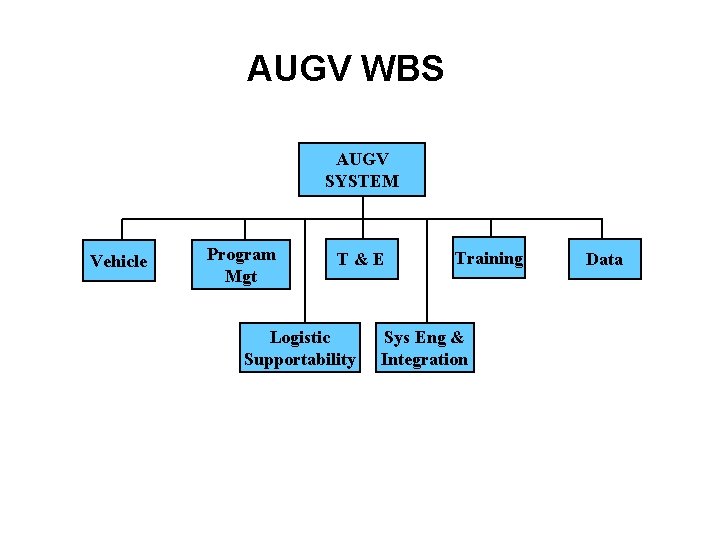

AUGV WBS AUGV SYSTEM Vehicle Program Mgt T&E Logistic Supportability Training Sys Eng & Integration Data

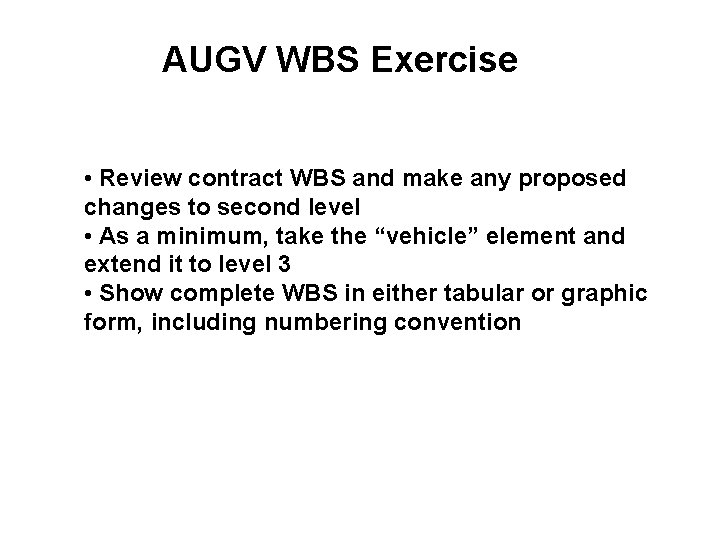

AUGV WBS Exercise • Review contract WBS and make any proposed changes to second level • As a minimum, take the “vehicle” element and extend it to level 3 • Show complete WBS in either tabular or graphic form, including numbering convention
