AN-NAJAH NATIONAL UNIVERSITY FUCULTY OF ENGINEERING CIVIL ENGINEERING DEPARTMENT GRADUATION PROJECT CONSTRUCTION PROJECT MANAGEMENT

AN-NAJAH NATIONAL UNIVERSITY FUCULTY OF ENGINEERING CIVIL ENGINEERING DEPARTMENT GRADUATION PROJECT CONSTRUCTION PROJECT MANAGEMENT (Value Engineering) By: Raya Abu- Ra’ed Lama Thawabeh Sabrin Salem. Supervisor: Eng. Hussein Abu Znt

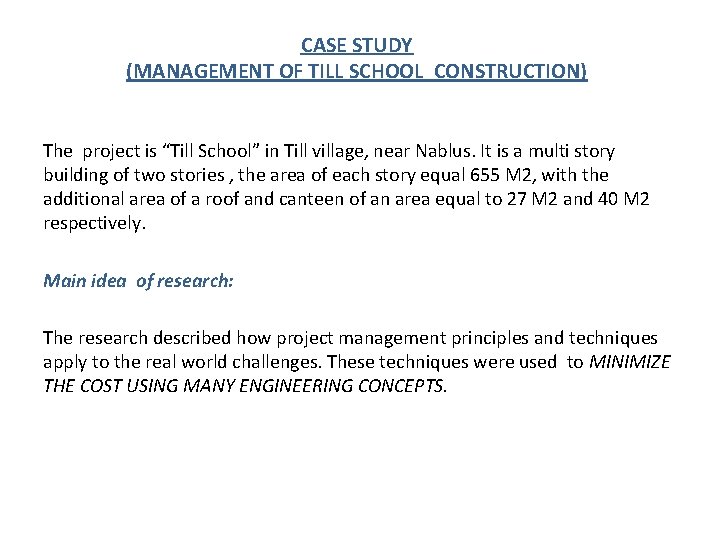

CASE STUDY (MANAGEMENT OF TILL SCHOOL CONSTRUCTION) The project is “Till School” in Till

CASE STUDY (MANAGEMENT OF TILL SCHOOL CONSTRUCTION) The project is “Till School” in Till village, near Nablus. It is a multi story building of two stories , the area of each story equal 655 M 2, with the additional area of a roof and canteen of an area equal to 27 M 2 and 40 M 2 respectively. Main idea of research: The research described how project management principles and techniques apply to the real world challenges. These techniques were used to MINIMIZE THE COST USING MANY ENGINEERING CONCEPTS.

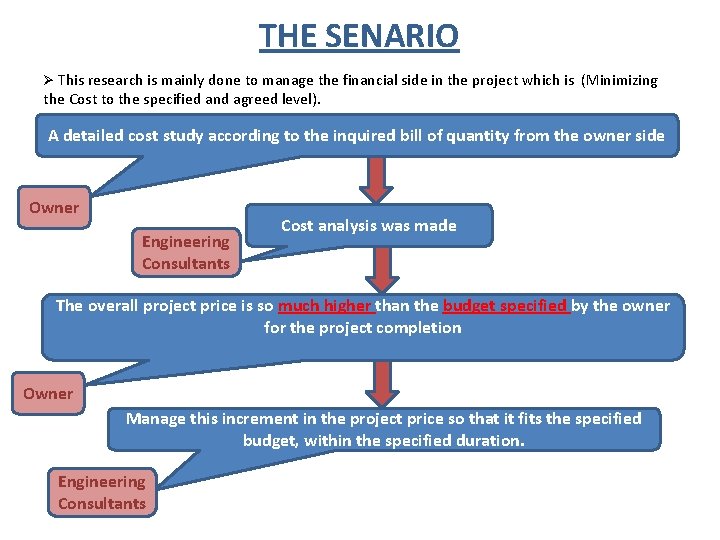

THE SENARIO Ø This research is mainly done to manage the financial side in

THE SENARIO Ø This research is mainly done to manage the financial side in the project which is (Minimizing the Cost to the specified and agreed level). A detailed cost study according to the inquired bill of quantity from the owner side Owner Engineering Consultants Cost analysis was made The overall project price is so much higher than the budget specified by the owner for the project completion Owner Manage this increment in the project price so that it fits the specified budget, within the specified duration. Engineering Consultants

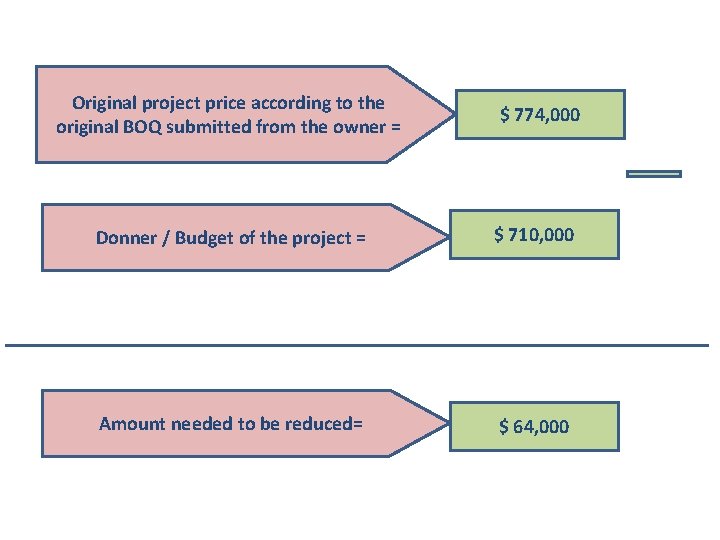

Original project price according to the original BOQ submitted from the owner = $

Original project price according to the original BOQ submitted from the owner = $ 774, 000 Donner / Budget of the project = $ 710, 000 Amount needed to be reduced= $ 64, 000

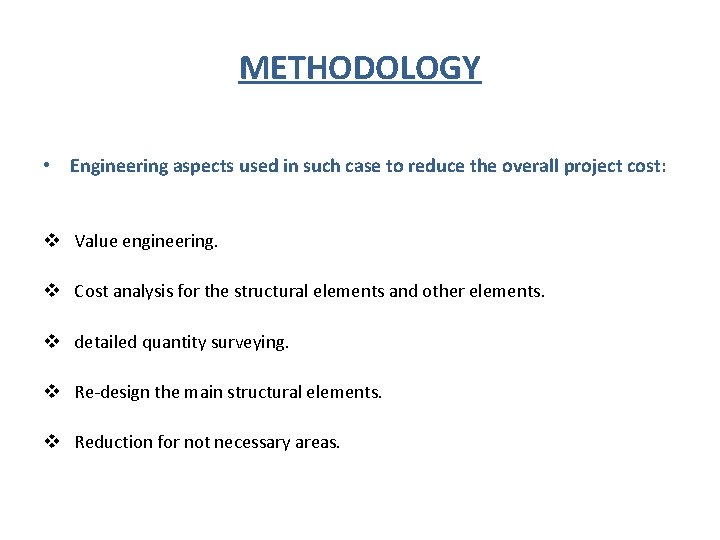

METHODOLOGY • Engineering aspects used in such case to reduce the overall project cost:

METHODOLOGY • Engineering aspects used in such case to reduce the overall project cost: v Value engineering. v Cost analysis for the structural elements and other elements. v detailed quantity surveying. v Re-design the main structural elements. v Reduction for not necessary areas.

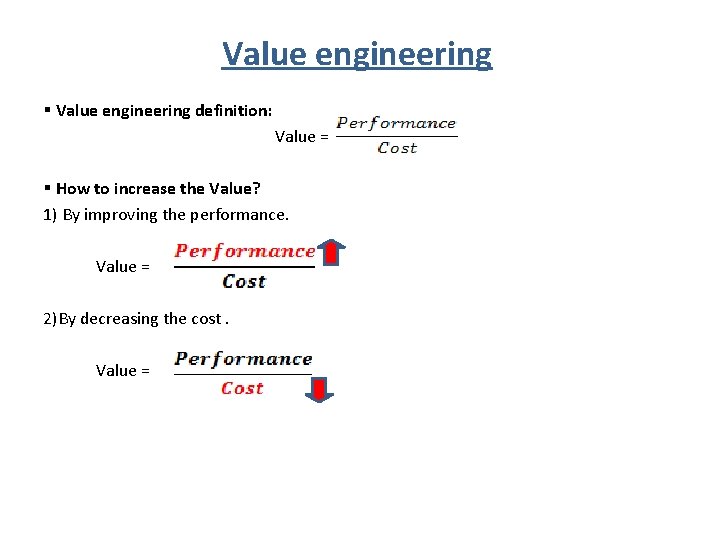

Value engineering § Value engineering definition: Value = § How to increase the Value?

Value engineering § Value engineering definition: Value = § How to increase the Value? 1) By improving the performance. Value = 2)By decreasing the cost. Value =

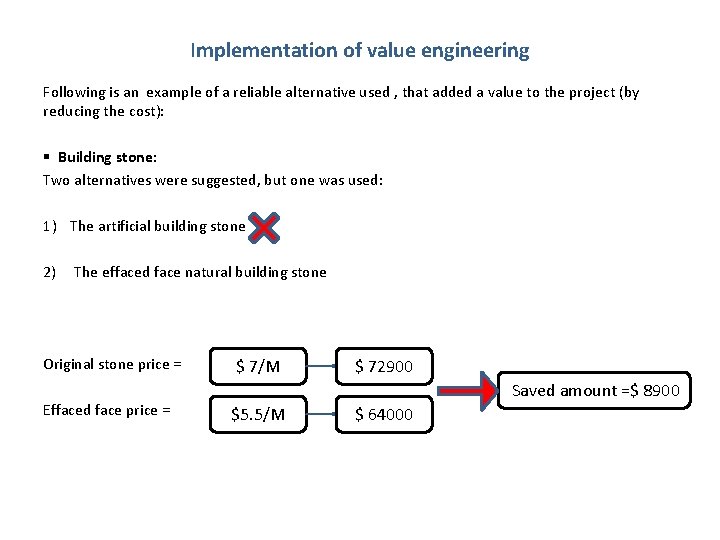

Implementation of value engineering Following is an example of a reliable alternative used ,

Implementation of value engineering Following is an example of a reliable alternative used , that added a value to the project (by reducing the cost): § Building stone: Two alternatives were suggested, but one was used: 1) The artificial building stone 2) The effaced face natural building stone Original stone price = Effaced face price = $ 7/M $ 72900 Saved amount =$ 8900 $5. 5/M $ 64000

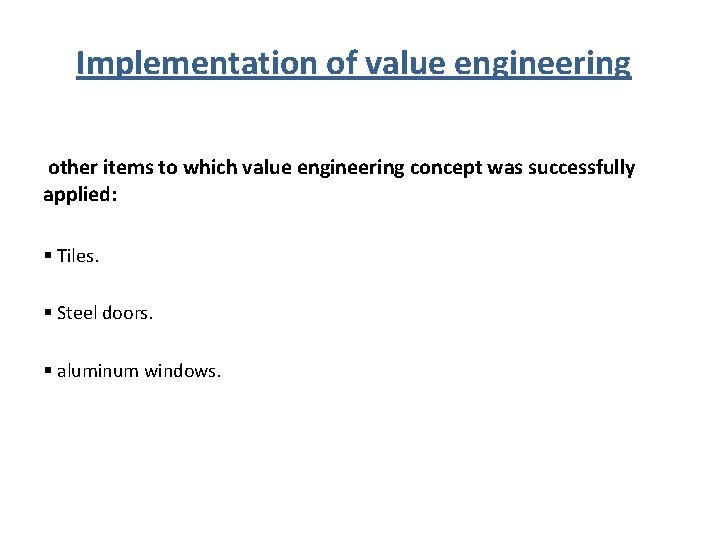

Implementation of value engineering other items to which value engineering concept was successfully applied:

Implementation of value engineering other items to which value engineering concept was successfully applied: § Tiles. § Steel doors. § aluminum windows.

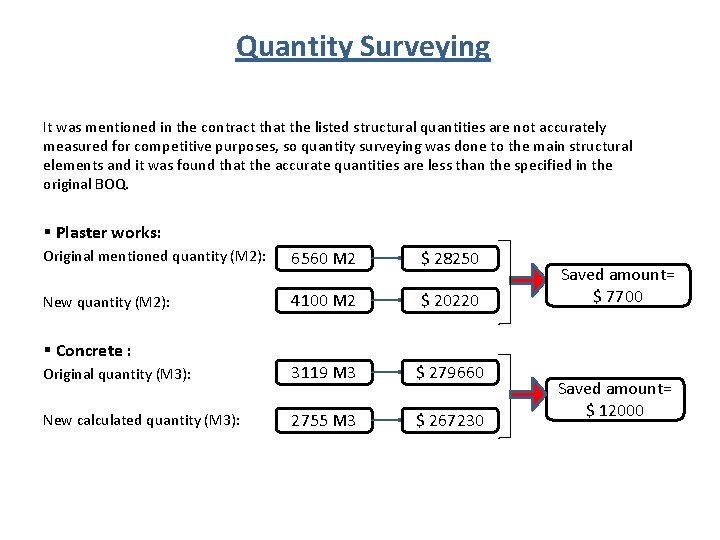

Quantity Surveying It was mentioned in the contract that the listed structural quantities are

Quantity Surveying It was mentioned in the contract that the listed structural quantities are not accurately measured for competitive purposes, so quantity surveying was done to the main structural elements and it was found that the accurate quantities are less than the specified in the original BOQ. § Plaster works: Original mentioned quantity (M 2): 6560 M 2 $ 28250 New quantity (M 2): 4100 M 2 $ 20220 Original quantity (M 3): 3119 M 3 $ 279660 New calculated quantity (M 3): 2755 M 3 $ 267230 Saved amount= $ 7700 § Concrete : Saved amount= $ 12000

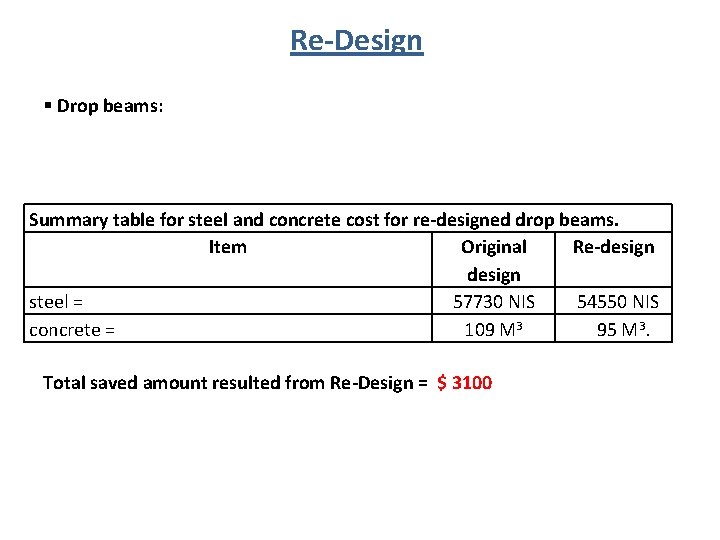

Re-Design § Drop beams: Summary table for steel and concrete cost for re-designed drop

Re-Design § Drop beams: Summary table for steel and concrete cost for re-designed drop beams. Item Original Re-design steel = 57730 NIS 54550 NIS concrete = 109 M 3 95 M 3. Total saved amount resulted from Re-Design = $ 3100

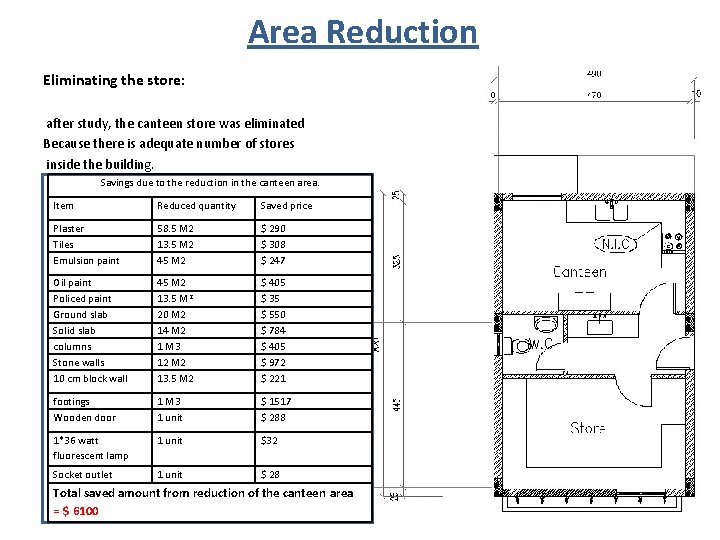

Area Reduction Eliminating the store: after study, the canteen store was eliminated Because there

Area Reduction Eliminating the store: after study, the canteen store was eliminated Because there is adequate number of stores inside the building. Savings due to the reduction in the canteen area. Item Reduced quantity Saved price Plaster Tiles Emulsion paint 58. 5 M 2 13. 5 M 2 45 M 2 $ 290 $ 308 $ 247 Oil paint Policed paint Ground slab Solid slab columns Stone walls 10 cm block wall 45 M 2 13. 5 M 2 20 M 2 14 M 2 1 M 3 12 M 2 13. 5 M 2 $ 405 $ 35 $ 550 $ 784 $ 405 $ 972 $ 221 footings Wooden door 1 M 3 1 unit $ 1517 $ 288 1*36 watt fluorescent lamp 1 unit $32 Socket outlet 1 unit $ 28 Total saved amount from reduction of the canteen area = $ 6100

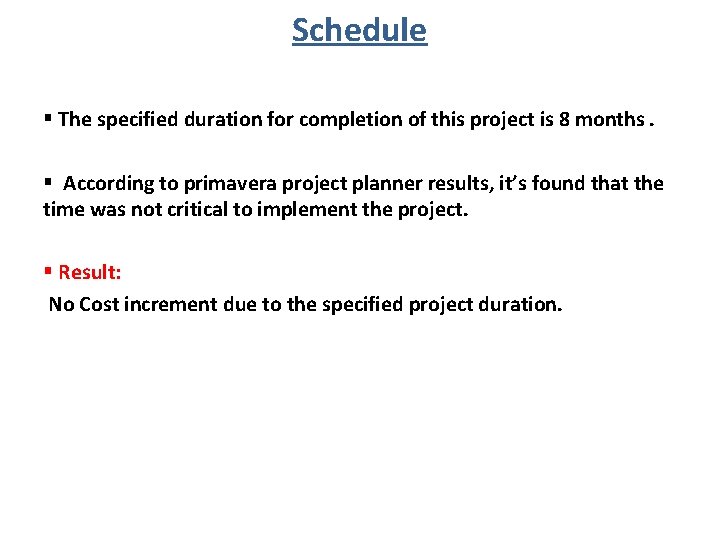

Schedule § The specified duration for completion of this project is 8 months. §

Schedule § The specified duration for completion of this project is 8 months. § According to primavera project planner results, it’s found that the time was not critical to implement the project. § Result: No Cost increment due to the specified project duration.

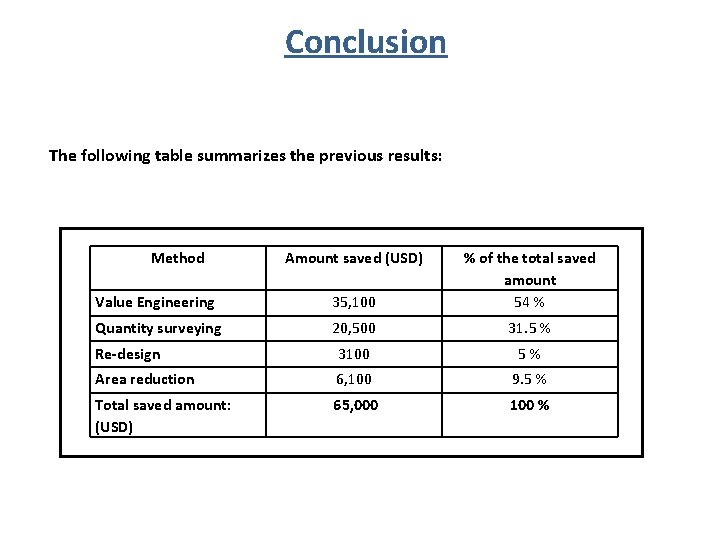

Conclusion The following table summarizes the previous results: Method Amount saved (USD) Value Engineering

Conclusion The following table summarizes the previous results: Method Amount saved (USD) Value Engineering 35, 100 % of the total saved amount 54 % Quantity surveying 20, 500 31. 5 % Re-design 3100 5% Area reduction 6, 100 9. 5 % Total saved amount: (USD) 65, 000 100 %

Recommendations §It is slightly recommended to search more about the application of the Value

Recommendations §It is slightly recommended to search more about the application of the Value Engineering in the Engineering world.

Thanks For attention Ready to answer any Question
