ALICE planning meeting 26 11 2010 261110 ALICE
- Slides: 127
ALICE planning meeting 26. 11. 2010 26/11/10 ALICE planning meeting
Outline • ALICE Christmas break schedule – Access UX 25, L 3 and MNF • Services interruption – Gas, cooling and electricity – DAQ and DCS plans • • Detectors activities Day-by-day schedule wks 49 -2 VIP visits AOB 26/11/10 ALICE planning meeting 2
Christmas break schedule • Start on Tuesday, 7 th December. End on Friday, 18 th February • Plan: – Open both L 3 doors – Installation of 3 TRD and 6 EMCal modules 26/11/10 ALICE planning meeting 3
ALICE Christmas break schedule Open L 3 doors Open Experiment 26/11/10 TRD Close L 3 doors EMCal ALICE planning meeting Close Experiment 4
Access restrictions • The reasons to restrict the access are: – Handling of shielding blocks – Lowering of heavy structures (yellow-platform, TRD and EMCal rotators and modules) – Installation of EMCal modules – Removal of L 3 ventilation – Evacuation tests – … • The access restrictions concern the UX 25 cavern, MNF, L 3 and CRs • SLIMOS shifts must be booked wks 49 -50 and 4 -5 • Indications are given (next slides) concerning the access during the whole break – however we’ll assess the situation on daily basis (5 o’clock meetings) depending on advancement of activities 26/11/10 ALICE planning meeting 5
UX 25 access Criteria for access restrictions: Removal/installation of shieldings (restriction includes RB 24 triplets) • PX 24 blocks: no access CR 5 and UX 25 • PX 24 beams (35 t): no access CR 1 -5, Expo, and UX-25 • All other blocks: no access to UX-25 LHC evacuation test (7/12 after 18: 00 and 24/12 tbc) – no access UX 25 Gas functional test (10/12 - 2 hrs) – no access UX 25 and CR 1 -5 AUG test (20/1) (Arrêt Urgence General – General Emergency Stop) – no access UX 25 DSO test (12 -13/1) (Department Safety Officer) – no access UX 25 26/11/10 ALICE planning meeting No access SX 2 during manipulation of blocks in SX 2 (except ACR and WRs) 6
L 3 (and MNF) access No Ventilation 24 EMCal Evac. EMCal 31 No Ventilation EMCal +AUG Wks 50 and 4: access (TPC) to be coordinated with TC (transport) Wks 1 -2: no access during EMCal SMs insertion inside L 3 (see day-by-day) When moving from low-beta to yellow platform: no access to MNF When inserting the module: no access L 3 and MNF Watcher needed in wk 49 and from wk 4 onwards Wk 6 or 7 (tbd): Kr calibration – TPC T stability (all interventions to be agreed by TC/RC) 26/11/10 ALICE planning meeting 7
Services interruption 26/11/10 ALICE planning meeting 8
Maintenance gas systems 3 10 New gas monitoring Functional tests New planning under discussion – consisting of stopping all systems for 2 days in December (wk 50) (more news next week) 26/11/10 ALICE planning meeting 9
Gas system status over Christmas • • TPC & TRD: ON TOF: ON – stop from 12 to 21/1 (cooling stop, KNF pump stopped) HMPID: ON (Ar backup) PHOS: N 2 flushing PMD: ON (except wks 1 -2 – gas stop) Muon TRK: backup CO 2 Muon TRG: backup Ar • No flammable gases from 10 Dec PM until 21 Jan PM (after maintenance L 3 ventilation) 26/11/10 ALICE planning meeting 10 Albin
Maintenance cooling units Cooling Plants and Primary Network TPC 10 TOF/PHOS 17 EMC SSD/SDD 12 TRD TPC HMPID SPD Maintenance and consolidation 21 Cooling towers Maintenance on production network. No primary water from 12/1 (PM) to 21/1 CR 1 -2 -3, the Wiener PS and detector cooling plants affected (plants can RUN, but no cooling power). Investigating possibility to keep part DCS running (Andre) Maintenance on cooling plants. Replacement of pneumatic actuators for TOF/TRD/TPC plants + TOF/PHOS flowmeter. CP will be stopped during maintenance 26/11/10 ALICE planning meeting 11
Maintenance ventilation units 17 UX 25, Muon 12 TRK-TRG SG 2 26/11/10 ALICE planning meeting UX 25, Muon TRKTRG L 3 12
Safety and electrical systems Evacuation 20 PX 24 fire detect. UPS Auto-transfert Evacuation UX 25 fire detect. + red phones SNIFFER mainten. DSS Evacuation Early morning/late evening (tbc) UPS AUG 26/11/10 ALICE planning meeting. DSO 13
Safety and electrical systems Impact on ALICE • EN/EL: interruption on auto-transfert network (9/12 from 07: 00 till 07: 05): – All 'normal power‘ will be cut for 5 minutes: wall outlets, non-UPS in the ACR, SXL 2, non-UPS power for the cooling plants, gas systems – It will not affect the 'machine network‘ (all racks will remain powered (part of the 'EXD', machine, network) – This network also provides the power to the UPSes, so they will run on battery for the time of this cut – See https: //edms. cern. ch/file/1106913/1/ENNC_2010_196. pdf • EN/EL: AUG Test (20/1) (Arrêt Urgence General – General Emergency Stop) – Major electrical perturbation. Also ACR affected • DSS modification (13/1) – Will stop the full DSS, trigger all interlocks, including stopping power to all racks • LHC evacuation tests (7/12 after 18: 00 and 24/12 tbc) – no access UX 25 26/11/10 ALICE planning meeting 14
DAQ upgrade plans • 21 st Dec PM till the 04 th Jan included – The DAQ will be OFF during the CERN closure. – The ACR PCs will be left ON to give access to the DCS for the detectors teams who need it. • 5 th to the 11 th of January included – The DAQ will be switched ON with the present version of all software to allow a quick commissioning after the installation of new detector modules or the intervention on existing detectors. • 12 th to the 23 rd Jan included – The DAQ will be OFF during the cooling interruption at P 2. – This period will be used by the DAQ team for a major hardware reshuffling (addition of LDCs, replacement of several servers) and a major software upgrade (transition from Linux SLC 4 32 bits to SLC 5 64 bits). • 24 th January – The DAQ will be ON again. It will run under SLC 5 64 bits unless there would be an unexpected key problem. • The electronic logbook will remain available during the whole period. 26/11/10 ALICE planning meeting 15 Pierre/Uli
DCS plans • Baseline: DCS will be operational all times where technically possible – With ‘best effort’ support – With access restrictions during CERN End-of-Year closure (22/12 – 4/1) • Many activities and upgrades are planned – Will be coordinated with individual detectors to minimise impact – For central systems, as much as possible in shadow of other perturbations (e. g. cooling stop) – Perturbations (e. g. for reboots etc. ) cannot be excluded • Detectors are invited to communicate ‘critical periods’, with services needed – Will try to cater for detector needs as much as possible • Known perturbations: – Tue 7/12 10: 00 – 12: 00, interruptions of the GPN link to/from P 2 • Upgrade of router, test impact on ALICE – Wk 50 (13 -17/12) – major updates to all PC (many perturbations to be expected) – 12/1 – 21/1 (cooling stop), only minimal central services. All detector DCS switched off, except for special requests and if cooling power allows • More detailed planning at weekly and daily meetings 26/11/10 ALICE planning meeting 16 André / Peter
Access request Cavern and surface • You should submit an ADI and a task procedure Attach task procedure Two persons minimum ADI https: //edh. cern. ch/Document/ADI 26/11/10 ALICE planning meeting Work breakdown structure – risk associated at each step Task procedure Template EDMS 1103355 17
Detectors activities 26/11/10 ALICE planning meeting 18
EMCal • Status of modules: – 4 modules in SXL 2 – Last 2 modules will be shipped to P 2 around middle of December • Test station will be moved soon to P 2 (SXL 2) • Requiring a lot of access to connect everything up, test, and debug as they commission the new SMs – Low voltage, high voltage (CR 4), and DAQ operating as much as possible during the installation period in January. 26/11/10 ALICE planning meeting 19
EMCal Surveys • Zero measurement (wk 51 -52), after insertion of 1 st module and after the insertion of 2 nd module: – A-side: CALframe feet and rails + modules (adaptors) – C-side (photogrammetry - 1/2 day) • After insertion of 3 rd, after insertion of 4 th and after insertion of 5 th module: – A-side: points chosen depending on results previous survey – C-side: with theodolite from A-side (or full photogrammetry, depending on results previous survey) • After insertion of 6 th module: – A-side: full – C-side: full 26/11/10 ALICE planning meeting 20
PMD • Wk 50: – Lift CROCUS (in order to open L 3 doors) - can be done by P 2 technicians – disconnect cables (after 16/12) • • Wk 51 (20/1): move PMD in parking position (Pieter) Wks 51 -4: repair electronics chains – Need Ar/CO 2 at all times (except during gas stop wks 1 -2) • • • Wks 5 -6 (night): access to CROCUS (doors closed, use CROCUS platform) February: move PMD to final position Wk 6: survey (transfer survey network to miniframe (Antje)) • Wks 1 -2 SPIE: new air cooling system – major installation work in January (should be done by end January) – Nacelle HAULOTTE needed 26/11/10 ALICE planning meeting 21
TOF/PHOS • TOF: – HV hardware checks on SM 13 (December) – TRM replacement (14 TRMs on the A side) (3/01 – 12/01) – Replacement DC-DC (with no LV spare channels): • SM 10 must be displaced (tbc) • 8 -9/12 (after 18: 00). Yannick must intervene to release the support beams • PHOS: (A. Vinogradow at CERN 1/12 end January) – – Investigate module 2 pedestal issues Try to understand behavior of unstable branch in Module 3 Remake ISEG crate to connect to the hardware interlock Fear presence of ice inside cold part - could melt when warming-up crystals • Working at solution to keep freon circulation at all times 26/11/10 ALICE planning meeting 22 Gilda/Yury
Muon TRG • RPC Detector/gas system: – Check gas tightness on few RPC detectors - need nacelle INSIDE and OUTSIDE (Verify availability HAULOTTE) (~3 days between January 10 -18) – Upgrade Sensor gas humidity and pressure regulator (CR 5, schedule to be defined with the gas team) – Replace few RPC modules with high current: under discussion • Electronics: – Maintenance Local decision electronics (December 8 th after 18: 00) – Upgrade FE threshold distributors, higher segmentation (level 4 gangway, December 8 th after 18: 00) – Upgrade firmware DARC and Regional board in order to speed up MTR decision electronics configuration (wk 6, after the DAQ upgrade) 26/11/10 ALICE planning meeting 23 Pascal/Ermanno/Paolo
Muon TRK plans • December: CROCUS firmware upgrade (protection against spurious busy reset signal): – Access to Crocus, Dipole and FASS. Need nacelle end wk 50 – Not possible to use PM 25 lift • High occupancy bus patches (under discussion): – Remove one "bad" slat (and replace by one spare) to test it in lab – Access to Dipole and to muon side with nacelle in December – Depending on the results, fix all remaining “bad” slats in January • January (from wk 2): replacement 2 quadrants ST 2 with faulty wires: – Test spare quadrants in lab (December) – Access to FASS – Crane needed. Survey needed? Waiting for info 26/11/10 ALICE planning meeting 24 Ermanno/Herve
ZDC plans • Check platform displacement with survey – One week – depending on surveyors availability 26/11/10 ALICE planning meeting 25 Paolo
SPD cooling plans – under discussion • Wk 49 (8/12 after 18: 00): cut pipes in order to open the doors • Wks 2 -3 (during cooling stop): wash 4 bad sectors (machine installed on I-side, close to HMPID pump). Access to the outer side of MNF (side I) to work on the heater of sector 0 (nacelle or scaffolding needed) • Wks 3 -4 (as soon as the door is closed): reconnect temporarily pipes and test with dummy sector inside MNF (in parallel with shielding in wk 4) 26/11/10 ALICE planning meeting 26
SSD/SDD SSD: • Ton: remove a cooling pipe from SSD corrosion test setup (week 2) • Replacement CAEN module (C-side) + repair bad temperature signal at the C-side (week 2) SDD: • Calibration of 78 pressure sensors in L 3 and on miniframe (January 12 to 14) 26/11/10 ALICE planning meeting 27
T 0 • Activities planned from 7 -19 December (after 18: 00): – – 26/11/10 Check/repair the amplifiers from A and C side (inside L 3) Check the signal cables from A-side Check/repair fast electronics modules (racks O 18 -19) Need possibility to do standalone runs in parallel ALICE planning meeting 28
TRD installation - weeks 51, 52 • 3 modules at P 2 (SM 2, SM 11 and SM 16). SM 15 not yet at CERN, expected to arrive by beginning December • Installation sequence: 16 → 15 → 11 (or 16 → 11 → 15) • 2 technicians (Philippe and Didier) + Survey (Nail from 6/12) + TC permanently at P 2 – Survey before-after each insertion to check space-frame deformations and displacement of beampipe (flange), miniframe and TPC feet • Connection done right after installation 26/11/10 ALICE planning meeting 29
TRD • Week 49: – LV Wiener ~80 PSU Back-Plane modifications (to improve mechanical stability, same as TPC applied already) – Netgear switches replacements (1 day) – LV line fixation: installation of improved patch panels on front of module (C-side) and replacing cables • Repair pretrigger (A-side, below PMD) – after 20/12 • Week 1: – Finalizing connections, start commissioning • Week 2: – Stable running with cosmics • 3 to 4 weeks in January or February: – Stable running with cosmics for alignment and with Krypton for gain calibrations (to be still discussed) 26/11/10 ALICE planning meeting 30
TPC • Recover all water inside cooling plant (week 50) • Replacement of 15 damaged FECs (equally distributed A-C sides) – ~3 days per FEC. Therefore, we would like to use all available time slots where access to the L 3 is possible – At the end of this activity we will need a period of about 2 weeks where all aforesaid systems are available for final verification, and access to the TPC in case something is not working correctly. • Kr data taking at the end of the shutdown (1 week) 26/11/10 ALICE planning meeting 31
TPC Replacement of the laser • Start the dismantling of the Spectron laser (week 50, Th-Sat after 18: 00): – dismount back wall of laser hut (help of P 2 technician) – stop cooling water (help of P 2 technician) – prepare new water connection (electrical power should be OK) • Install new Ekspla laser (week 1): – remove old laser and install new (use crane to transport laser) – connect cooling water (help of P 2 technician) – reinstall back wall (maybe after cutting a hole in it) • Testing and alignment of new laser (week 2): – possibility to run laser behind closed doors (inside hut) – maybe install laser tube temporarily and shoot into TPC whenever – compatible with other installation work • Possible further testing and adjustment (week 3) 26/11/10 ALICE planning meeting 32 Borge
ACORDE • Check some ACORDE modules (PMTs optical conections, connectors, etc) above the magnet • The plan is to start this activities after the second week of January 2011 26/11/10 ALICE planning meeting 33
Other activities • SPIE + CV: refurbishment ITS dehumidifier in CR – February – Repair leak (replace leaking part – transport needed) – Recirculation air – Add flowmeter (connect to ELMB: Frederick) • • • EN-EL (T. Bourrel): motorize L 3 -Dipole-Miniframe circuit breaker SPIE: cabling UX 25 -CR 4 – January New magnet emergency buttons + flashing lights L 3 and dipole Frederick: humidity sensor L 3 ventilation (extraction) + redo CTP connectors Intervention on cavern lift – One day stop – no access to UX 25. To be scheduled • Google propose to produce a custom Streetview application for CERN showing both outside and underground areas – January 5 to 18 26/11/10 ALICE planning meeting 34
Other activities • Philippe: replace rack filters during cooling stop 26/11/10 ALICE planning meeting 35
Day-by-day schedule UX 25 and MNF - Wk 49 26/11/10 ALICE planning meeting 36
Activities in UX 25 - Week 49 - 6/12 Monday No access UX-25 TRD team at CERN: 6 to 10/12 ITECO HAULOTTE 26/11/10 ALICE planning meeting 37
Activities in MNF - Week 49 - 6/12 Monday No access MNF 26/11/10 ALICE planning meeting 38
Activities in UX 25 - Week 49 - 7/12 Tuesday 8: 00 to 18: 00: no access UX 25 (except Transport, VAC and RP) 18: 00 – midnight: evacuation test (No access UX 25) DGS/RP: samples cooling liquids (SPD highest priority) Reinstall crane electronics PX 24 shielding: blocks VAC TPC FEC Lock L 3 power converter (Fernando) Transport needed (EDH 4472100). Demount GIS protection “the green fence” (ALICE) RP samples Replacement of damaged FECs (after 18: 00) 8: 00 to 18: 00: no access CR 5 26/11/10 ALICE planning meeting 39
Activities in MNF - Week 49 - 7/12 Tuesday 8: 00 to 18: 00: no access MNF 18: 00 – midnight: evacuation test (No access UX 25) 26/11/10 ALICE planning meeting 40
Activities in UX 25 - Week 49 - 8/12 Wednesday 8: 00 to 18: 00: no access UX 25 (except Transport and VAC) 18: 00 to 8: 00: access in general mode TRD Wiener PS Move if needed PX 24 shielding: beams (35 t) VAC TPC FEC and TRD LV Stabilizers Cut SPD pipes (after 18: 00) TRD Wiener PS 8: 00 to 18: 00: no access CR 1 -5 and Expo 26/11/10 TRD: back-Plane modifications LV Wiener (~80 PSU) and Modified LV patch panels and ALICE planning meeting new cables (after 18: 00) Muon TRG Maintenance Local decision electronics (after 18: 00) Upgrade FE threshold distributors, higher 41 segmentation (after 18: 00)
Activities in MNF - Week 49 - 8/12 Wednesday 8: 00 to 18: 00: no access UX 25 18: 00 to 8: 00: access in general mode 26/11/10 ALICE planning meeting 42
Activities in UX 25 - Week 49 - 9/12 Thursday 8: 00 to 18: 00: no access UX 25 (except Transport and VAC) 18: 00 to 8: 00: access in general mode RAMSES: removal of Data Acquisition modules CR 5 TPC FEC and TRD LV MNF shielding VAC TRD Wiener PS Interruption on auto-transfert network (from 07: 00 till 07: 05) Stabilizers TRD Wiener PS No access CR 1 -5 during lifting up of 5 big beams 26/11/10 ALICE planning meeting 43
Activities in MNF - Week 49 - 9/12 Thursday 8: 00 to 18: 00: no access UX 25 18: 00 to 8: 00: access in general mode 26/11/10 ALICE planning meeting 44
Activities in UX 25 - Week 49 - 10/12 Friday 8: 00 to 18: 00: no access UX 25 (except Transport) 18: 00 to 8: 00: access in general mode Gas functional test (2 h no access UX 25 and CR 1 -5). Stop flammable gases (PM) Maintenance PX 24 MAD (transparent) TPC FEC and TRD LV TRD Wiener PS MNF shielding LV 156 TRD Wiener PS Move if needed No access CR 1 -5 during lifting up of 5 big beams 26/11/10 ALICE planning meeting 45
Activities in MNF - Week 49 - 10/12 Friday 8: 00 to 18: 00: no access UX 25 18: 00 to 8: 00: access in general mode 26/11/10 ALICE planning meeting 46
Activities in UX 25 - Week 49 - 11/12 Saturday 8: 00 to 18: 00: no access UX 25 (except Transport) 18: 00 to 8: 00: access in general mode TRD LV TRD Wiener PS MNF shielding LV 156 TRD Wiener PS 26/11/10 ALICE planning meeting 47
Activities in MNF - Week 49 - 11/12 Saturday 8: 00 to 18: 00: no access UX 25 18: 00 to 8: 00: access in general mode 26/11/10 ALICE planning meeting 48
Activities in UX 25 - Week 49 - 12/12 Sunday Access in general mode 26/11/10 ALICE planning meeting 49
Activities in MNF - Week 49 - 12/12 Sunday Access in general mode 26/11/10 ALICE planning meeting 50
Day-by-day schedule UX 25 and MNF - Wk 50 26/11/10 ALICE planning meeting 51
Activities in UX 25 - Week 50 - 13/12 Monday 8: 00 to 18: 00: no access UX 25 (except Transport) 18: 00 to 8: 00: access in general mode MNF shielding L 3 ventilation No access L 3 (no ventilation) LV 156 Muon TRK: CROCUS firmware upgrade Lift maintenance: AS 703 6: 00 to 8: 00; AS 715 10: 00 to 11: 30. TBC After 18: 00 26/11/10 ALICE planning meeting 52
Activities in MNF - Week 50 - 13/12 Monday 8: 00 to 18: 00: no access UX 25 18: 00 to 8: 00: access in general mode 26/11/10 ALICE planning meeting 53
Activities in UX 25 - Week 50 - 14/12 Tuesday 8: 00 to 18: 00: no access UX 25 (except Transport) 18: 00 to 8: 00: access in general mode Lift PMD CROCUS MNF shielding No access L 3 (no ventilation) Prepare opening door 26/11/10 ALICE planning meeting Muon TRK: CROCUS firmware upgrade LV 156 54
Activities in MNF - Week 50 - 14/12 Tuesday 8: 00 to 18: 00: no access UX 25 18: 00 to 8: 00: access in general mode 26/11/10 ALICE planning meeting 55
Activities in UX 25 - Week 50 - 15/12 Wednesday 8: 00 to 18: 00: no access UX 25 (except Transport) 18: 00 to 8: 00: access in general mode VIP visit (tbc): Finance and Council Delegates – 16: 45 MNF shielding Laser hut Open I-side door Dismount back wall of laser hut 26/11/10 Muon TRK: CROCUS firmware upgrade LV 156 TPC FEC TRD cooling Normal hours (access to be coordinated with TC) ALICE planning meeting 56
Activities in MNF - Week 50 15/12 Wednesday 8: 00 to 18: 00: no access UX 25 18: 00 to 8: 00: access in general mode 26/11/10 ALICE planning meeting 57
Activities in UX 25 - Week 50 - 16/12 Thursday 8: 00 to 18: 00: no access UX 25 (except Transport) 18: 00 to 8: 00: access in general mode Prepare opening door Laser After 18: 00 YP rails 26/11/10 ALICE planning meeting TPC FEC TRD cooling Muon TRK: CROCUS firmware upgrade Arrival PMD team 58
Activities in MNF - Week 50 - 16/12 Thursday 8: 00 to 18: 00: no access UX 25 18: 00 to 8: 00: access in general mode 26/11/10 ALICE planning meeting 59
Activities in UX 25 - Week 50 - 17/12 Friday 8: 00 to 18: 00: no access UX 25 (except Transport) 18: 00 to 8: 00: access in general mode Open O-side door Laser After 18: 00 26/11/10 Release all TOF crates supports (Yannick. Samuel) ALICE planning meeting Muon TRK: CROCUS firmware upgrade TRD cooling TRD 16 into rotator and into UX 25. No access low-beta platform TPC FEC Lower YP onto rails 60
Activities in MNF - Week 50 - 17/12 Friday 8: 00 to 18: 00: no access UX 25 Disconnect PMD services (after 20: 00) 18: 00 to 8: 00: access in general mode Removal MNF staircase (access with ladder) 26/11/10 ALICE planning meeting 61
Activities in UX 25 - Week 50 - 18/12 Saturday 8: 00 to 18: 00: no access UX 25 (except Transport) 18: 00 to 8: 00: access in general mode Laser After 18: 00 26/11/10 ALICE planning meeting 62
Activities in MNF - Week 50 - 18/12 Saturday 8: 00 to 18: 00: no access UX 25 Disconnect PMD services 18: 00 to 8: 00: access in general mode 26/11/10 ALICE planning meeting 63
Activities in UX 25 - Week 50 - 19/12 Sunday Access in general mode TRD team at CERN: 19 (PM) to 23/12 26/11/10 ALICE planning meeting 64
Activities in MNF - Week 50 - 19/12 Sunday Disconnect PMD services Access in general mode 26/11/10 ALICE planning meeting 65
Day-by-day schedule UX 25 and MNF - Wk 51 26/11/10 ALICE planning meeting 66
Activities in UX 25 - Week 51 - 20/12 Monday Prepare TRD 16 installation - PM EMCal Survey (1/2 day) YP rails TPC FEC TRD and EMCal Survey GS/ASE: PX 24 fire detection maintenance PMD ventilation Including installation BBF rails SR 16 -15 26/11/10 ALICE planning meeting 67
Move PMD in parking position Activities in MNF - Week 51 - 20/12 Monday TPC cooling pipes (Yannick) - AM 26/11/10 ALICE planning meeting 68
Activities in UX 25 - Week 51 - 21/12 Tuesday TPC FEC GS/ASE: PX 24 fire detection maintenance Install TRD 16 PMD ventilation 26/11/10 ALICE planning meeting 69
PMD: replacement electronics chains Activities in MNF - Week 51 - 21/12 Tuesday 26/11/10 ALICE planning meeting 70

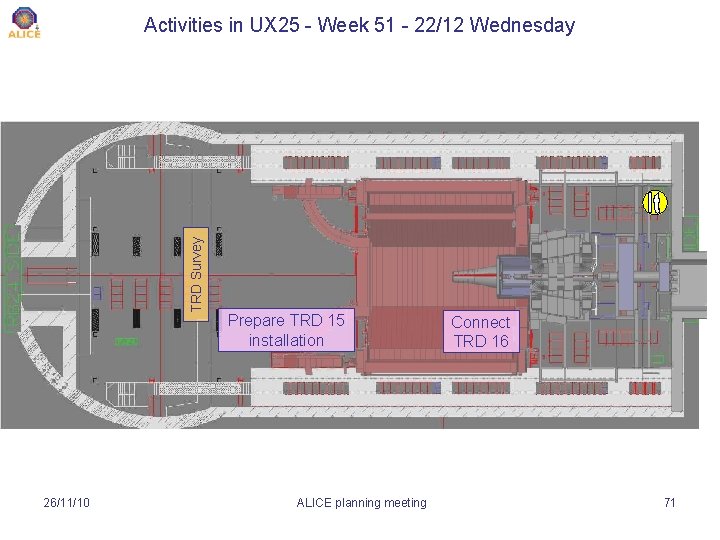

TRD Survey Activities in UX 25 - Week 51 - 22/12 Wednesday 26/11/10 Prepare TRD 15 installation ALICE planning meeting Connect TRD 16 71
PMD: replacement electronics chains Activities in MNF - Week 51 22/12 Wednesday 26/11/10 ALICE planning meeting 72
TRD Survey Activities in UX 25 - Week 51 - 23/12 Thursday Install TRD 15 26/11/10 ALICE planning meeting Connect TRD 16 73
PMD: replacement electronics chains Activities in MNF - Week 51 - 23/12 Thursday 26/11/10 ALICE planning meeting 74
Activities in UX 25 - Week 51 - 24/12 Friday LHC evacuation test. no access UX 25 26/11/10 ALICE planning meeting 75
Activities in MNF - Week 51 - 24/12 Friday LHC evacuation test. no access UX 25 26/11/10 ALICE planning meeting 76
Activities in UX 25 - Week 51 - 25/12 Saturday Christmas day 26/11/10 ALICE planning meeting 77
PMD: replacement electronics chains Activities in MNF - Week 51 - 25/12 Saturday 26/11/10 ALICE planning meeting 78
Activities in UX 25 - Week 51 - 26/12 Sunday TRD team at CERN: 26 to 30/12 26/11/10 ALICE planning meeting 79
PMD: replacement electronics chains Activities in MNF - Week 51 - 26/12 Sunday 26/11/10 ALICE planning meeting 80
Day-by-day schedule UX 25 and MNF - Wk 52 26/11/10 ALICE planning meeting 81
Activities in UX 25 - Week 52 - 27/12 Monday TRD Survey Including installation BBF rails SR 11 Prepare TRD 11 installation Connect TRD 15 26/11/10 ALICE planning meeting 82
PMD: replacement electronics chains Activities in MNF - Week 52 - 27/12 Monday 26/11/10 ALICE planning meeting 83
Activities in UX 25 - Week 52 - 28/12 Tuesday Prepare TRD 11 installation Connect TRD 15 26/11/10 ALICE planning meeting 84
PMD: replacement electronics chains Activities in MNF - Week 52 - 28/12 Tuesday 26/11/10 ALICE planning meeting 85
Activities in UX 25 - Week 52 - 29/12 Wednesday TRD Survey Install TRD 11 26/11/10 ALICE planning meeting 86
PMD: replacement electronics chains Activities in MNF - Week 52 29/12 Wednesday 26/11/10 ALICE planning meeting 87
Activities in UX 25 - Week 52 - 30/12 Thursday TRD Survey Move EMCal rotator + SM 5 onto low beta platform, and perform handling test 26/11/10 EMCal infrastructure ALICE planning meeting Connect TRD 11 88
PMD: replacement electronics chains Activities in MNF - Week 52 - 30/12 Thursday 26/11/10 ALICE planning meeting 89
Activities in UX 25 - Week 52 - 31/12 Friday EMCal infrastructure 26/11/10 ALICE planning meeting 90
PMD: replacement electronics chains Activities in MNF - Week 52 - 31/12 Friday 26/11/10 ALICE planning meeting 91
Activities in UX 25 - Week 52 - 1/1/2011 Saturday New Year day 26/11/10 ALICE planning meeting 92
Activities in MNF - Week 52 - 1/1/2011 Saturday New Year day 26/11/10 ALICE planning meeting 93
Activities in UX 25 - Week 52 - 2/1 Sunday 26/11/10 ALICE planning meeting 94
Activities in MNF - Week 52 - 2/1 Sunday 26/11/10 ALICE planning meeting 95
Day-by-day schedule UX 25 and MNF - Wk 1 - 2011 26/11/10 ALICE planning meeting 96
Activities in UX 25 - Week 1 - 3/1 Monday PH-DT: new gas monitoring system (no fresh gas injection whole week) (tbc) Lower SM 6 onto low beta platform Move HAULOTTE SM 5 Connect TRD 11 TPC FEC Install EMCal 40 deg-C (PM) Laser TOF TRM PMD ventilation Install new Ekspla laser 26/11/10 ALICE planning meeting 97
PMD: replacement electronics chains Activities in MNF - Week 1 - 3/1 Monday 26/11/10 ALICE planning meeting 98
Activities in UX 25 - Week 1 - 4/1 Tuesday Laser EMC Survey (AM) Install EMCal 40 deg-A (PM) TPC FEC EMC Survey SM 6 TOF TRM PMD ventilation 26/11/10 ALICE planning meeting 99
PMD: replacement electronics chains Activities in MNF - Week 1 - 4/1 Tuesday 26/11/10 ALICE planning meeting 100
Activities in UX 25 - Week 1 - 5/1 Wednesday RAMSES: reinstallation of Data Acquisition modules CR 5 Maintenance UPS ESS 307/2 X (transparent) GS/ASE: UX 25 fire detection maintenance Laser TPC cooling 26/11/10 EMC Survey TPC FEC Lower SM 7 onto low beta platform TOF TRM PMD ventilation ALICE planning meeting 101
PMD: replacement electronics chains Activities in MNF - Week 1 - 5/1 Wednesday 26/11/10 ALICE planning meeting 102
Activities in UX 25 - Week 1 - 6/1 Thursday GS/ASE: UX 25 fire detection + red phones maintenance Lower SM 8 onto low beta platform TPC cooling 26/11/10 Install EMCal 60 deg-C TPC FEC EMC Survey SM 7 Laser TOF TRM PMD ventilation ALICE planning meeting 103
PMD: replacement electronics chains Activities in MNF - Week 1 - 6/1 Thursday 26/11/10 ALICE planning meeting 104
Activities in UX 25 - Week 1 - 7/1 Friday GS/ASE: UX 25 fire detection + red phones maintenance TPC cooling 26/11/10 Install EMCal 60 deg-A TPC FEC EMC Survey SM 8 Laser TOF TRM PMD ventilation ALICE planning meeting 105
PMD: replacement electronics chains Activities in MNF - Week 1 - 7/1 Friday 26/11/10 ALICE planning meeting 106
Activities in UX 25 - Week 1 - 8/1 Saturday Laser 26/11/10 ALICE planning meeting 107
Activities in MNF - Week 1 - 8/1 Saturday 26/11/10 ALICE planning meeting 108
Activities in UX 25 - Week 1 - 9/1 Sunday 26/11/10 ALICE planning meeting 109
Activities in MNF - Week 1 - 9/1 Sunday 26/11/10 ALICE planning meeting 110
Day-by-day schedule UX 25 and MNF - Wk 2 26/11/10 ALICE planning meeting 111
Activities in UX 25 - Week 2 - 10/1 Monday PH-DT: new gas monitoring system (no fresh gas injection whole week) (tbc) VIP visit (Mr Herman Josef Lamberti, Deutschen Bank). From 15: 30 TPC FEC Laser TPC cooling Muon TRG: RPC Check gas tightness on few RPC detectors (need both nacelles) Lower SM 9 onto low beta platform PMD ventilation SSD Testing and alignment of new laser HAULOTTE needed 1 day (if possible to move it) SSD: replacement CAEN module (C-side) + repair bad temperature signal (C-side) 26/11/10 ALICE planning meeting 112
PMD: replacement electronics chains Activities in MNF - Week 2 - 10/1 Monday 26/11/10 ALICE planning meeting 113
Activities in UX 25 - Week 2 – 11/1 Tuesday Laser SPD cooling TPC cooling Muon TRG: RPC TPC FEC Visit (30 students. Peter Glaessel and Kai Schweda) PMD ventilation SSD/SDD cooling Wash 4 bad sectors + repair heater (nacelle) 26/11/10 ALICE planning meeting 114
PMD: replacement electronics chains Activities in MNF - Week 2 - 11/1 Tuesday 26/11/10 ALICE planning meeting 115
Activities in UX 25 - Week 2 - 12/1 Wednesday Cooling towers maintenance (start 14: 00) (No primary water) Maintenance UPS EBS 106/2 X (transparent) SNIFFER maintenance Lower SM 10 onto low beta platform Cleaning rack filters (Philippe) Laser SPD cooling Muon TRG: RPC Install EMCal 80 deg-C TPC FEC EMC Survey SM 9 PMD ventilation SDD/ SSD SDD: calibration of 78 pressure sensors SSD: removal of cooling pipe from corrosion test setup 26/11/10 ALICE planning meeting 116
PMD: replacement electronics chains Activities in MNF - Week 2 - 12/1 Wednesday 26/11/10 ALICE planning meeting 117
Activities in UX 25 - Week 2 - 13/1 Thursday Cooling towers maintenance (No primary water) DSS modification. Will stop the full DSS, trigger all interlocks, including stopping power to all racks SNIFFER maintenance RAMSES: radiation source tests EN/CV: maintenance SG 2 ventilation HMPID cooling Install EMCal 80 deg-A TPC FEC EMC Survey SM 10 SPD cooling PMD ventilation SDD 26/11/10 ALICE planning meeting 118
PMD: replacement electronics chains Activities in MNF - Week 2 - 13/1 Thursday 26/11/10 ALICE planning meeting 119
Activities in UX 25 - Week 2 - 14/1 Friday Cooling towers maintenance (No primary water) SNIFFER maintenance RAMSES: radiation source tests EN/CV: maintenance SG 2 ventilation SDD SPD cooling VAC EMC Survey TPC FEC EMC Survey Start pumping out PMD ventilation SPD cooling 26/11/10 ALICE planning meeting 120
PMD: replacement electronics chains Activities in MNF - Week 2 - 14/1 Friday 26/11/10 ALICE planning meeting 121
Activities in UX 25 - Week 2 - 15/1 Saturday Cooling towers maintenance (No primary water) 26/11/10 ALICE planning meeting 122
Activities in MNF - Week 2 - 15/1 Saturday 26/11/10 ALICE planning meeting 123
Activities in UX 25 - Week 2 - 16/1 Sunday Cooling towers maintenance (No primary water) 26/11/10 ALICE planning meeting 124
Activities in MNF - Week 2 - 16/1 Sunday 26/11/10 ALICE planning meeting 125
VIP visits • Mr Herman Josef Lamberti, Mitglied des Vorstands der Deutsche Bank, Germany, on Monday 10 th January 2011 Visit schedule: • Finance and Council Delegates to visit one of the four major LHC underground sites on 15 th December at 16 h 30 26/11/10 ALICE planning meeting 126
AOB • Peter Ginter: wk 4 • Special ”working at height” training session on November 30 th – If you are interested, you should contact asap Fernando • Next planning meeting Friday 3 December 26/11/10 ALICE planning meeting 127
- For todays meeting
- Proposal kickoff meeting agenda
- What is meeting and types of meeting
- Types of meeting
- Initial planning meeting
- Strategic planning vs tactical planning
- Planning balance sheet in urban planning
- Role segmentation workforce planning
- N planning
- Aggregate planning is capacity planning for:
- Long medium and short term planning in primary schools
- What is language planning
- Aggregate capacity planning
- Examples of aggregate planning
- Small business server 2010
- Visual studio 2010 training
- Ul 2010
- Visual studio 2005 download
- Microsoft project tutorial 2010
- Microsoft project 2010 tutorial
- Visio 2010 trial
- Dm 249
- Exchange 2010 best practices
- Sta 2010
- Earth science sol 2010
- 7/10/2010
- Florida building code 2010
- Rmo 76-2010
- 2010/7 sayılı genelge tkgm
- The small boy saw george with a crazy dog recently
- Beurteilungsfehler
- Sasrea act 2 of 2010
- Who won the royal rumble 2010
- June 2010 physics regents answers
- Censo da educação superior 2010
- Powerpoint zemin rengi
- Censo de poblacion 2010
- Owasp top ten 2013
- Owasp top 10 2010
- Mul 2010
- 2010 micro frq
- Excel 2010 kullanımı
- Microsoft outlook 2010 training
- Exchange server management tools
- Table design access
- Ms excel merupakan program pengolah
- Da toolset
- Mlif definition
- 7/10/2010
- Loi rct du 16 décembre 2010
- 107/2010
- Falsafah kspk
- Pp 53 tahun 2010
- June 2010 chemistry regents
- 10 de junio de 2010
- Irizar 2010
- Ms word 2007 view tab
- Betts and neihart
- Ssapweb
- Goal seek in excel 2007
- Excel 2010 training
- Email archiving and retention exchange 2012
- Orden 5958
- 2010
- Visual basic 2010 ide
- Visual 2010 express
- After the fall 2010
- Monthly planner 2010
- 1ter1
- 2010 pearson education inc
- 2010 pearson education inc
- Aerosol system nfpa
- Ssxx ssyy ssxy calculator
- 2010 pearson education inc
- Miranda natalie 2010
- Caltrans standard plans 2010
- Osterwalder & pigneur 2010
- Biology 30 diploma 2005
- Microsoft forefront protection 2010 for exchange server
- Horoskop 2010
- 2010 cxxx
- Apm 2010
- Psu 2010 equation
- Aisc 2010
- 2010 pearson education inc answers
- Alabama course of study math 2010
- Alabama course of study math 2010
- Din en 50522
- Windows embedded 7 iso
- Cara mengaktifkan macro di excel 2007
- Tpe 2010
- Fas incoterm 2010
- In the new drm law, ndcc became
- T. trimpe 2010 http://sciencespot.net/
- Salesforce plugin for outlook 2010
- Rd 455/2010
- Invalsi 2010-11
- Nnnn 2010
- Plan nacional de desarrollo 2010 a 2014
- Moncler 2010
- Gambar toolbar formatting
- Sharepoint 2010 migration best practices
- Office 2010 project
- What is this
- ربط gmail مع outlook 2010
- Fam 2020 checklist
- Rt. 2010 s. 1345
- The tempest 1992
- Pipp sekolah kebangsaan
- Replay queue length exchange 2010
- Eurodance 2010
- Ens 2010
- National education policy 1998-2010
- Outputkloof
- 2010 pearson education inc answers
- 2010 pearson education inc answers
- Cara mengoperasikan microsoft power point
- 2010 cmc california mechanical code
- çağatay ulusoy freundin
- Aha guidelines 2010
- Survivability level fire alarm
- Amc8 2001
- Xxxxx on
- A business case for peering in 2010
- Diphiodont
- Copyright 2010
- 2010 pearson education inc
- 2010 pearson education inc
