Actions List 1 ACTION LIST BEER Revisit current
Actions List 1

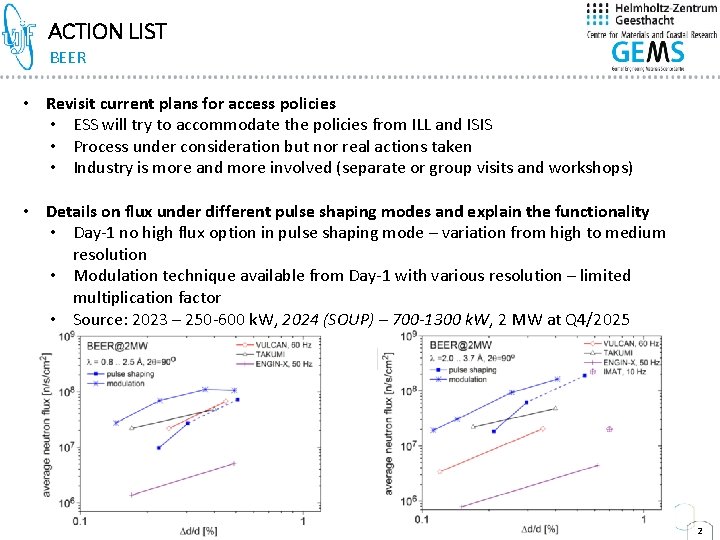

ACTION LIST BEER • Revisit current plans for access policies • ESS will try to accommodate the policies from ILL and ISIS • Process under consideration but nor real actions taken • Industry is more and more involved (separate or group visits and workshops) • Details on flux under different pulse shaping modes and explain the functionality • Day-1 no high flux option in pulse shaping mode – variation from high to medium resolution • Modulation technique available from Day-1 with various resolution – limited multiplication factor • Source: 2023 – 250 -600 k. W, 2024 (SOUP) – 700 -1300 k. W, 2 MW at Q 4/2025 2

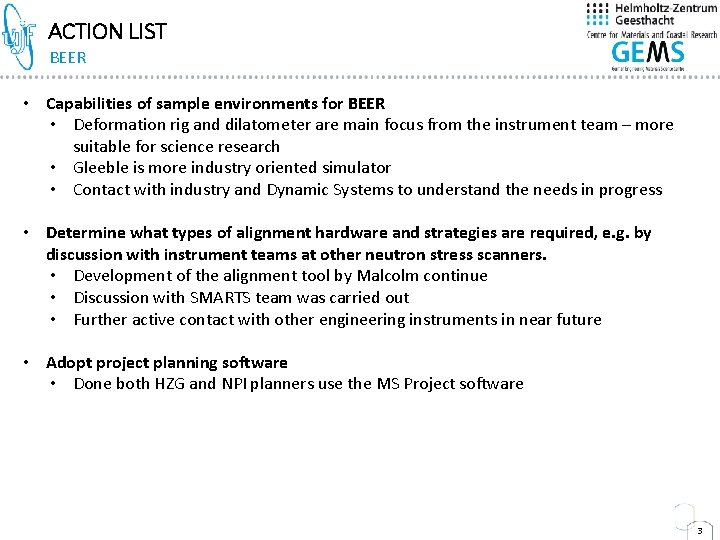

ACTION LIST BEER • Capabilities of sample environments for BEER • Deformation rig and dilatometer are main focus from the instrument team – more suitable for science research • Gleeble is more industry oriented simulator • Contact with industry and Dynamic Systems to understand the needs in progress • Determine what types of alignment hardware and strategies are required, e. g. by discussion with instrument teams at other neutron stress scanners. • Development of the alignment tool by Malcolm continue • Discussion with SMARTS team was carried out • Further active contact with other engineering instruments in near future • Adopt project planning software • Done both HZG and NPI planners use the MS Project software 3
Progress Update 4
PROGRESS UPDATE Contracts • Draft of Contribution agreement passed ESS council in December signatures pending • Work on TA on going • NBOA on critical path TG 3 by 30. 07. 2019 Plan B under discussion with ESS 5
PROGRESS UPDATE In-bunker & SEE Call for tender verification - CTV: • • Chopper Neutron guides in-bunker Hexapod and Rotary stage 6 -axis robot arm Ø Feedback received last Friday Ø Minor changes 6
DETECTOR STATUS G. Nowak, J. Plewka, Ch. Jacobsen, C. Gregersen, F. Theopold, A. Beldowski, J. Burmester Inside view: Detector-planes structure Outside view: & on delay-line pre-amp: Main-amp, CFD, FPGA(TDC)-unit for 2 planes: 1000 mm ≈1460 Detector electronics (outside): mm 1000 - 1 m 2 - 10 B 4 C-coatings commerc. available -weight: 600 kg -“connection“ to ICS/EPICS integrated -for HV-supply a NIM create needed -CF 4 -gas supply needed 7

TG 3‘S HZG Feb ‘ 19 CTV IDR TG 3‘s Final TG 3 Jan ‘ 20 Mar ‘ 20 Jun ‘ 20 Aug ‘ 20 Choppers, in bunker neutron optics, sample stage Choppers, in bunker neutron optics, sample stage, Detector Collimators Choppers, in bunker neutron optics, sample stage, Detectors Collimators TG 3 8
GUIDE OUTSIDE OF THE BUNKER Contract for the transport guide and guide exchanger • Contract for the design and manufacturing of the transport guide (outside of the bunker, including safety shutter part) + focusing part (including slit system) + guide exchanger was signed – Nuvia-Mirrotron is the winner • Kick-off meeting in January • Early manufacturing documentation will be submitted shortly for transport part • IDR planned in September • Discussion on the last slit system design: fixed exchangeable apertures vs. motorised slit system (limited space) 9
IDR – CAVE, GUIDE SHIELDING, SAFETY SHUTTER IDR meeting in December 11, 2018 • Small issues with the level of description of interfaces • Safety shutter needs some more work • Overall no mayor issues with the concept design • Serious debate about the H 1 and H 2 scenarios for engineering • Definition of “full beam”, redefinition of “worst-sample” • Passive shielding for H 2 preferred • Not-real comments about shielding calculations • Cave re-design 10
H 1 AND H 2 SCENARIOS Full beam and the worst-sample definition H 1 IDR definition Full beam: all choppers stopped open, all slits are fully open Worst-samples: 1 cm 3 of water (neutron scatterer), 1 cm 3 Ni (gamma emitter) H 2 IDR definition (active monitoring, dose on cave wall 20 m. Sv/h) Full beam: all choppers stopped open, all slits are fully open Worst-sample: 100 x 1 mm 3 Cd sheet Cave wall thickness in IDR: 55 cm rear and side walls, 60 roof and front wall Re-definition of the worst-sample: 4 x 4 x 1. 5 cm 3 on Ni (Ni harder gamma than Cd) Active monitoring of H 2: troubles with definition of devices and place where to measure, safety components! – expensive, passive solution preferred when reachable New simulation shows that H 1 (bigger Ni) overgoes H 2 (Cd in the beam) Thicker shielding needed -> front and roof wall 125 cm, side and back wall 105 cm !Shrinking of the inner space, floor load capacity, feasibility! Þ re-definition of roof as control-zone (25 m. Sv/h – no access), walls: concrete + steel Þ Side and rear wall: 60 cm concrete + 14 steel, roof: 78 cm of concrete (B 4 C tiles on walls) Þ Floor load: 20 t/m 2 very difficult to achieve – local overload could be acceptable Þ Schedule delay: 2 months (but we could keep the installation at the end of this year) 11
H 1 AND H 2 SCENARIOS Full beam and the worst-sample definition What if floor load limit will be able to achieve? Redefinition of H 1 “full beam” scenarios • Decrease the probability of stopping all of the choppers in open position by • applying control software procedures (can’t be eliminated, not safety related software!) • user will not be able to change the mode of measurement (modulation or pulse chapping) • Frame overlap chopper at 80 m will be rotation all the time (decrease the flux on the sample, can limit the imaging option on the instrument) • Used fixed smaller aperture in the guide system (reduction of science case) • User will be able to change the slits so the worst-case H 1 scenario is fully open slit system H 2 scenario will need to be handled with active monitoring • gamma monitors in the control hutch and near by the hot spot – safety component • incorporation of additional light shutter to link to the gamma monitor – safety component • Not clear answer from the radiation safety group how to handle this scenario It will lead to another delay in the sub-TG 3 for the cave and further installation process. 12
TG 3‘S NPI June ‘ 19 IDR TG 3’s TG 4‘s Installation Final TG 3 Sep ‘ 19 Oct ‘ 19 Nov ‘ 19 Jan ‘ 20 Aug ’ 20 Guide outside of the bunker, guide support Cave & hutch, guide shielding, safety shutter Guide outside of the bunker, guide support Cave, guide shielding Cave Guide shielding TG 3 13

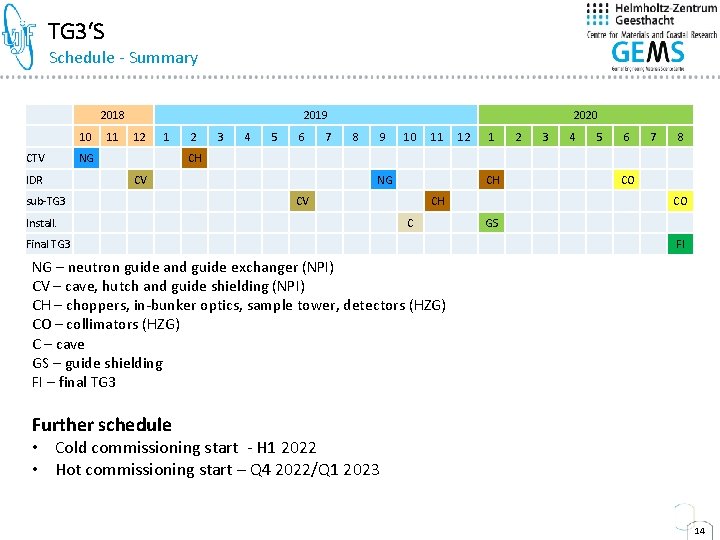

TG 3‘S Schedule - Summary 2018 2019 2020 10 11 12 1 2 3 4 5 6 7 8 9 10 11 12 1 2 3 4 5 6 7 8 CTV NG CH IDR CV NG CH CO sub-TG 3 CH CO FI CV Install. Final TG 3 C GS NG – neutron guide and guide exchanger (NPI) CV – cave, hutch and guide shielding (NPI) CH – choppers, in-bunker optics, sample tower, detectors (HZG) CO – collimators (HZG) C – cave GS – guide shielding FI – final TG 3 Further schedule • Cold commissioning start - H 1 2022 • Hot commissioning start – Q 4 2022/Q 1 2023 14
