1 BI LHC Planning for LS 2 Global
1 BI LHC Planning for LS 2 ØGlobal LHC LS 2 Planning https: //espace. cern. ch/en-dep-mef-lpc/LS 2/Global%20 Schedules/Forms/All. Items. aspx ØBI Planning 25. 01. 2019 G. Schneider BE-BI

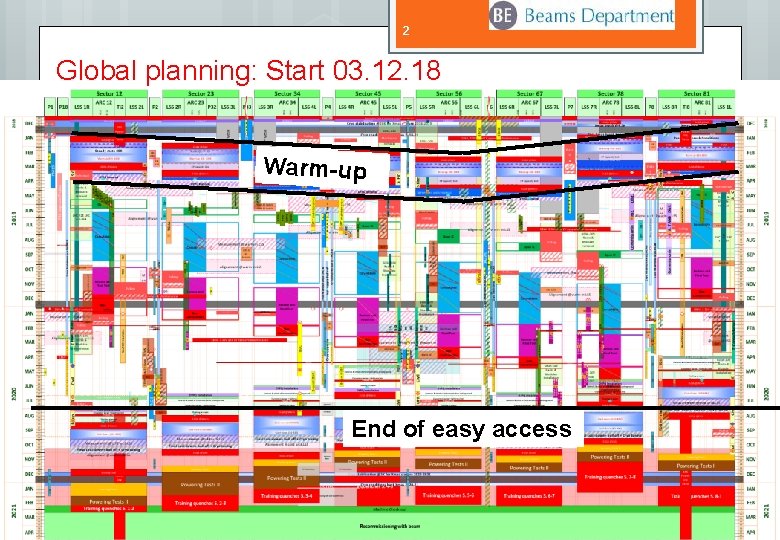

2 Global planning: Start 03. 12. 18 Warm-up End of easy access 04. 09. 2018 G. Schneider BE-BI
3 BSRT and BTVSE activities (VSC involvement) BSRTM mirrors and viewports removed (left and right) for lab inspection BTVSE: BTVSE IP 6 left: after inspecton o. k. BTVSE IP 6 right internal line: removed for lab refurbishment 25. 01. 2019 G. Schneider BE-BI
4 Dates for LS 2 ØAll maintenance + service work finished by February 2020 ØMaintenance + service instrument check until April 2020 ØDifficult access as from August 2020 25. 01. 2019 G. Schneider BE-BI
5 Up-date since last meeting Ø BSRT D 5 R 4 and D 5 L 4 mirrors and window flanges removed. Ø BTVSE IP 6: Ø BTVSE internal beam line removed and serviced in the laboratory Ø external beam line BTVSE remains in tunnel after inspection Ø Wire scanner: Ø Wire scanner 4 left: Will be vented as from week 5 on the left side and VSC will start with mechanical works for the sectorisation. Ø Bakeout foreseen end April 2019 25. 01. 2019 G. Schneider BE-BI
6 LSS 4 L 15. 01. 2019 G. Schneider BE-BI
LSS 4 R 16. 11. 2018 7 G. Schneider BE-BI
Activities: BL 16. 11. 2017 8 G. Schneider BE-BI
9 Activities: IQ and BP 16. 11. 2018 G. Schneider BE-BI
10 Activities: PM and ML 15. 01. 2019 G. Schneider BE-BI
